• Tyrone Middle School - Major Renovations

    Updated on 12/13/22

    Project information:

    Architect:  Rowe Architects

    Contractor: A.D. Morgan Construction, Inc

    CM Project Website: https://www.tyronemiddleschool.com/

    PCSB Project Coordinator: Jason Novisk

    Project Budget: $28 Million

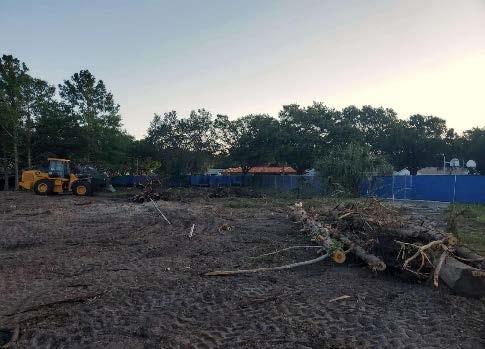

    Construction Start Date: February 2021

    Completion: August 2022

    Construction/Renovation of:

    The project includes new construction, renovation, and remodeling of the existing Tyrone Middle School campus which houses the Center for Innovation and Digital Learning (CIDL). CIDL is the district’s premier, technology-focused middle school where students inquire and explore simulation, artificial intelligence and virtual reality in a project-based, blended learning environment. The project’s goal is to create a dynamic, state-of-the-art renovation that fosters collaborative creativity, innovation and invention where students utilize technology as a tool to enhance their learning experience in today’s world. When complete, this interconnected campus design should embody Tyrone’s innovation and digital learning theme with tech infrastructure and adaptive learning spaces supporting a 1:1 device initiative, classroom innovation and social interaction.

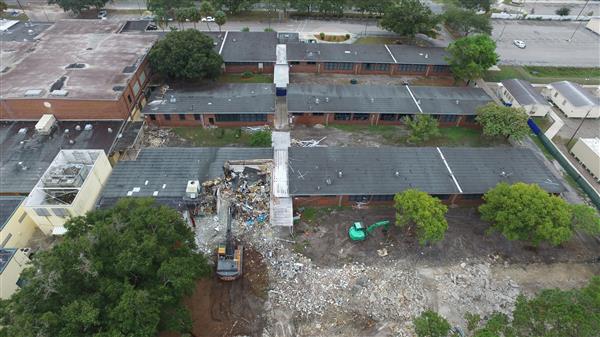

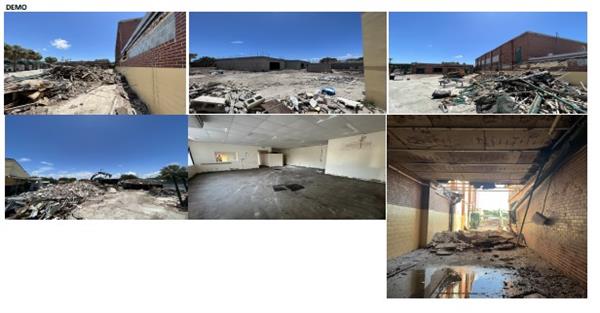

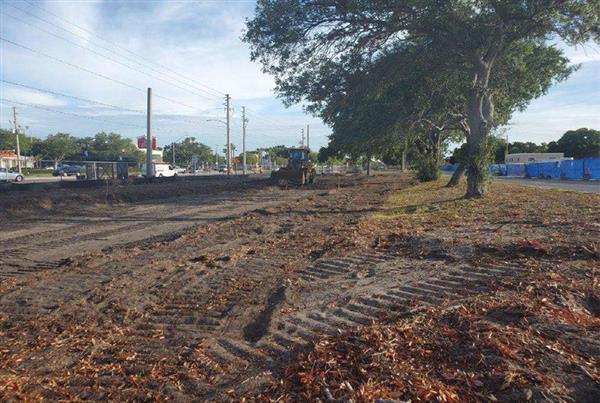

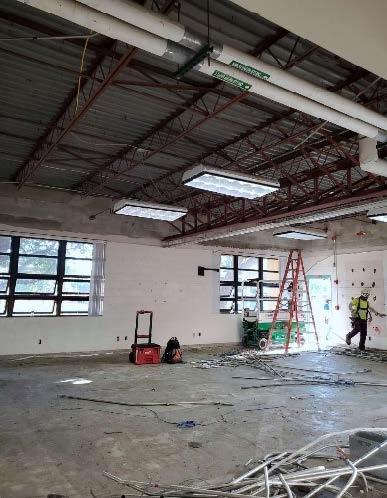

    Demolition will include:
    Buildings 1-7, 9-14, and 16-22

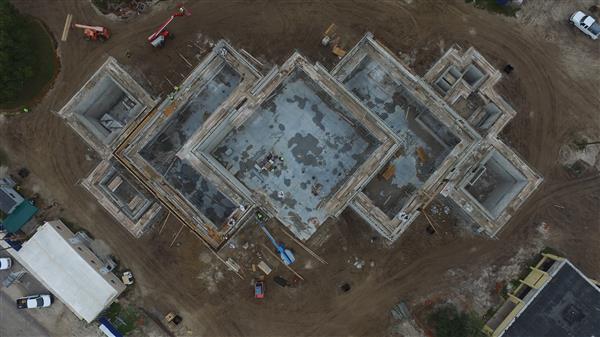

    New construction will include:
    • Administration suite w/ multi-use collaborative space
    • Central Energy Plant
    • Cafeteria
    • Media Center
    • Science classrooms
    • General classrooms
    • Parking lot layout in the front of the campus

    Renovations and Remodeling to include:
    • Campus to receive new interior and exterior paint throughout for all painted elements
    • Building 8 is to receive minor renovation work to include new interior and exterior paint throughout, new ceilings and lights, and new flooring. The building’s HVAC system is also to be evaluated for life expectancy.
    • Building 15 is to receive a total renovation which would include but not limited to new ceilings, lights, refinishing the gym flooring, and paint. The building’s HVAC system is also to be evaluated for life expectancy.
    • Buildings 23-26 are to receive minor renovation work to include new interior and exterior paint throughout, new ceilings and lights, and new flooring. The HVAC systems are also to be evaluated in these buildings for life expectancy.
    • Re-Roof existing Buildings to remain, Buildings 8,15, 23-26

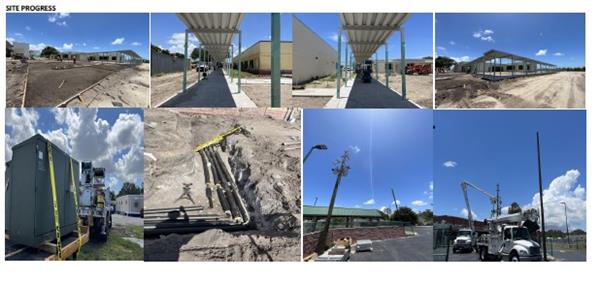

    Project status:

     Week of 11/25/22

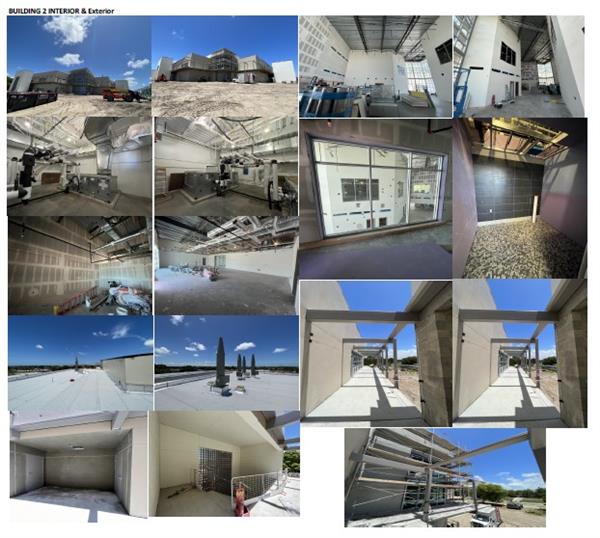

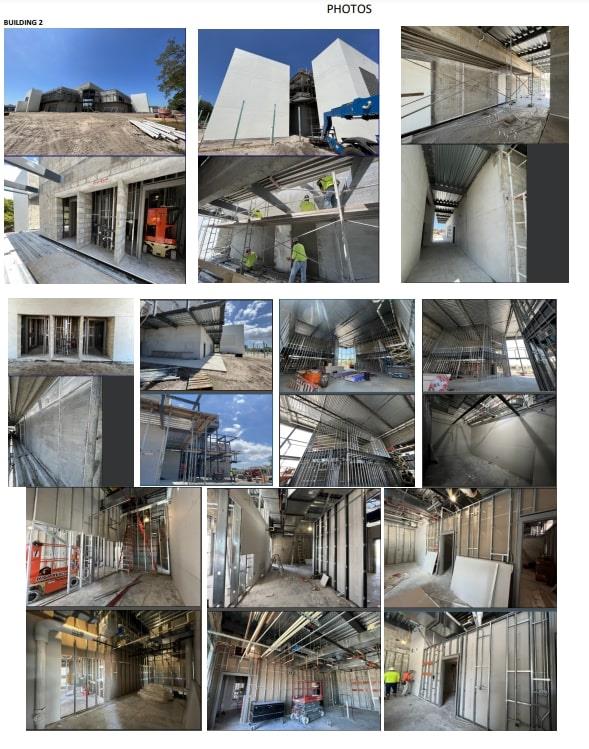

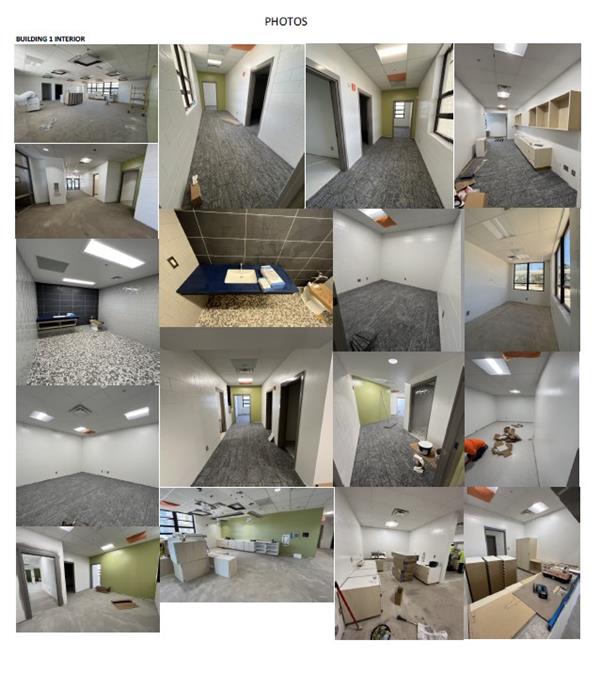

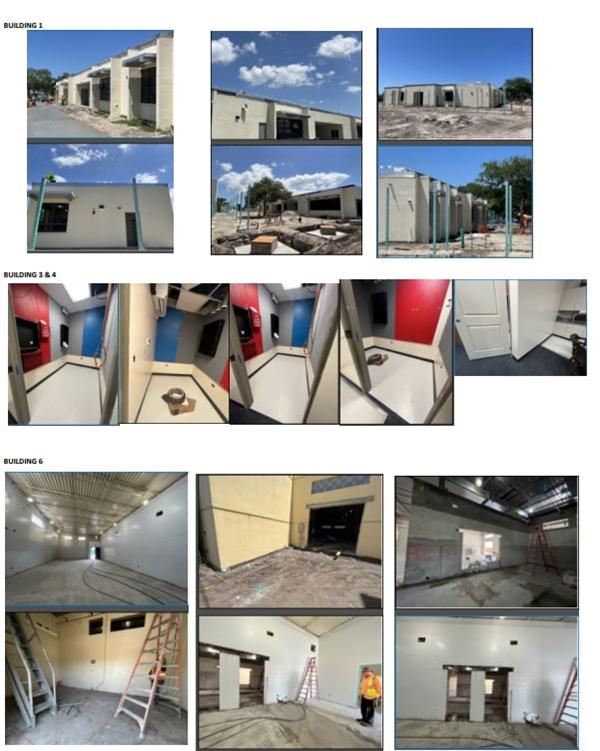

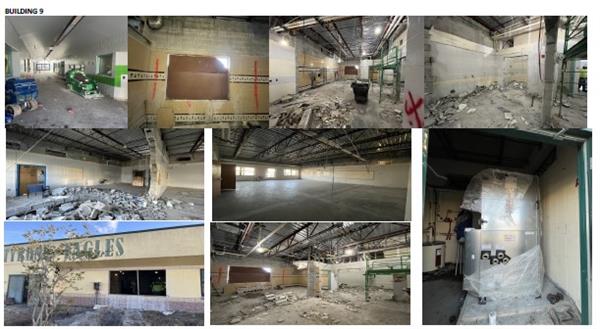

    Building #1, 2, 3, 4, 9 and 10

    Subcontractor's are working on punch list after hours when building is not occupied and on weekends.  We are currently reviewing completed items which is approximately 80% of the 1218 Total punch items for bldg. 1, 2, 3, 4, 9 & 10.

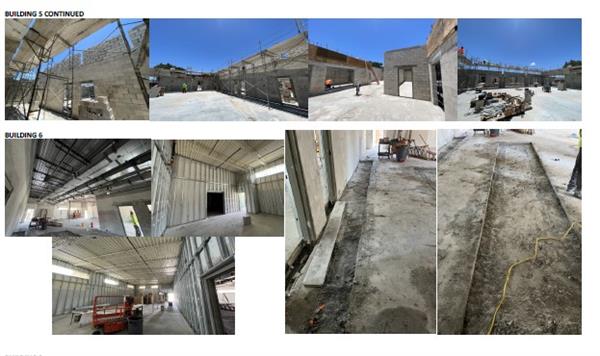

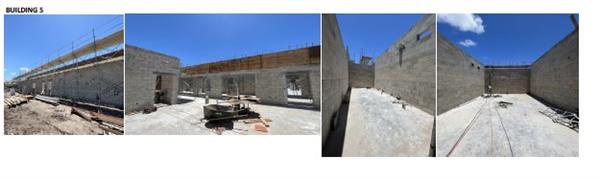

    Building #5

     Exterior paint Finish coat (complete - 100%)
     MEP overhead in kitchen in progress (approximately 100%).
     Roofing parapet wall flashing in progress 80% (waiting for metal cap now)  kitchen area -floor and grout complete (progress 100%)
     Restrooms floor and wall tile underway (progress 50%)
     Exterior window framing and glass - progress 95%

    Building #6

    Interior drywall / Finish in progress 100% complete  Interior Paint 2nd Coat (2 of 2 complete)
     Light Fixture Trim installation (in progress 100%)
     Acoustic ceiling grid and tiles in progress 95%
     Rooms flooring - Carpet tile and VCT in progress 100%  Casework in progress (base install 100% and cabinet 10%)

    Building #7

    Wall Framing in locker room in progress 90% complete
     Ceiling Framing in locker room/ offices/ restroom (in progress 90%)
      MEP overhead rough in progress 90%

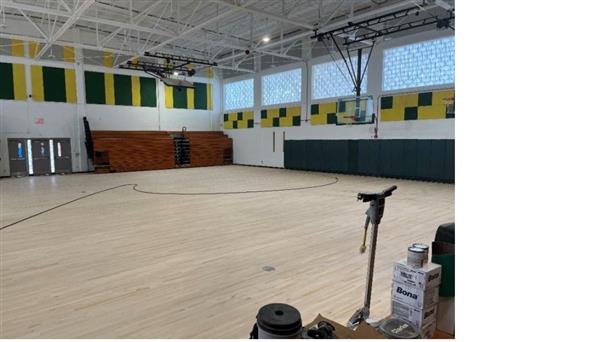

     Gym Floor repair Complete 100% and re-sanding schedule to start week 11.28.22

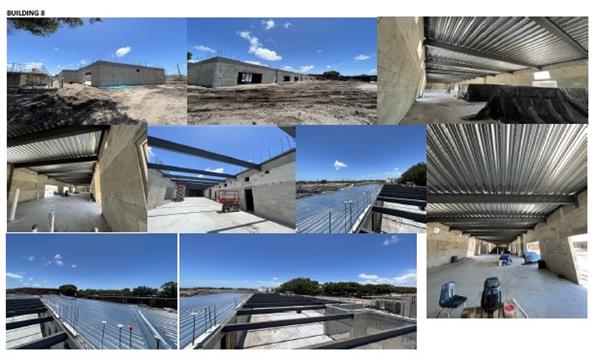

    Building #8

    Exterior Window Framing and glass in progress 100%
     Drywall framing on 1st floor in progress (100%) complete.
     Drywall finish on 1st floor in progress (95%) complete.
     Drywall on 2nd floor in progress (75%) complete.
     MEP overhead rough in progress on First Floor (100%)
     MEP overhead rough in progress on second Floor (80%)
     Electrical wall rough 1st Floor in progress 100%
     Electrical wall rough 2nd Floor in progress 70%
     Roofing parapet wall flashing in progress 80% (waiting for metal cap now)

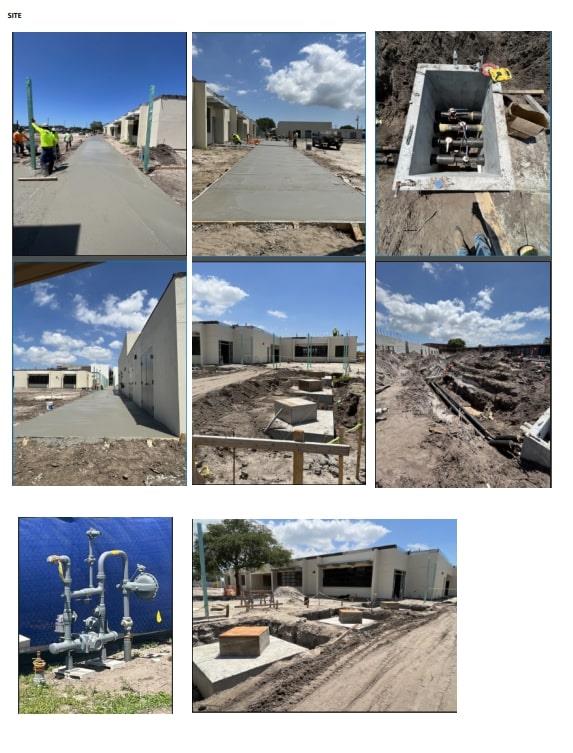

    Site Work Remaining scope

      Footers for Aluminum Canopy near bldg. 5& 8 (in progress 70%)
      Form and Pour sidewalks from West to East (progress 10%)   Install Storm Lines from Pond H3 to Bus loop pond.
