• Clearwater High - Major Renovations

    Updated on 12/13/22

    Project information:

    Architect:  Hepner Architects, Inc.

    Contractor: Je Dunn Construction Group, Inc.

    CM Project Website: https://www.clearwaterhs.jedunnbuilds.com

    PCSB Project Coordinator: Mike Parkinson

    Project Budget: $57.5 Million

    Construction Start Date: March 2021

    Completion: October 2023

    Construction/Renovation of:

    The project will include new construction, renovation and remodeling of the existing Clearwater High School Campus. The new site plan will include a beautification element along the street edge of Gulf to Bay which the City of Clearwater will be included in the design development.  There will also be a minimum of 25 portables that will be needed to house students during construction.

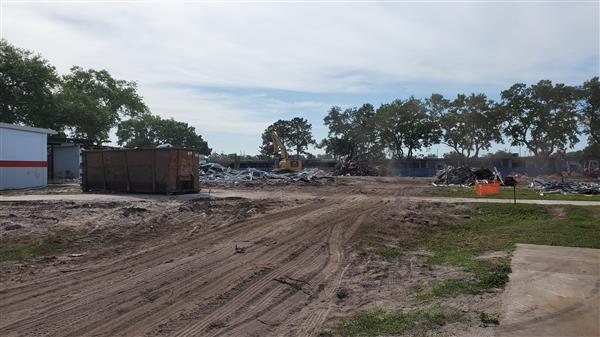

               Demolition will include

                  Buildings 2, 3, 5-17, 22, 32, 34 and 35

              New construction will include:

      • Administration suite w/ multi-use collaborative space
      • Central Energy Plant
      • Cafeteria
      • Media Center
      • Science classrooms
      • General classroom learning suites
      • Entrance to the football stadium along with a new synthetic turf field and track
      • Parking lot layout in the front of the campus and a new location for the driver’s ed course
      • ESE classrooms

      Renovations and Remodeling include:

      • Campus to receive new interior and exterior paint throughout for all painted elements.

      • Building 4 is to receive minor renovation work to include new interior and exterior paint throughout, new ceilings and lights, and new flooring in the gymnasium lobby.

      • Building 18 is to receive a total remodel which would include, but not limited to, new ceilings, lights, flooring, paint, windows and new HVAC.  Building 18 will house the ROTC, Aerospace program, Woodshop and additional classroom space.

      • Building 19 is to receive a total remodel which would include but not limited to new ceilings, lights, flooring, paint, and new HVAC.  Building 19 will house the Adult Education program and will have flex space for high school testing lab(s).

      • Building 24 is to receive minor renovation work to include new interior and exterior paint throughout, new ceilings and lights and new flooring. The building’s HVAC system is also to be evaluated for life expectancy.

      • Building 25 is to receive minor renovation work to include new interior and exterior paint throughout, new ceilings and lights and new flooring. The building’s HVAC system is also to be evaluated for life expectancy.

    Project status:

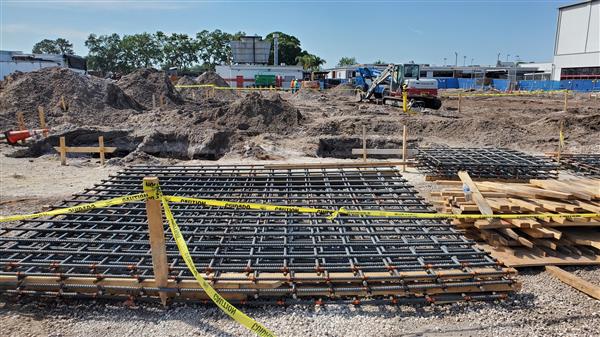

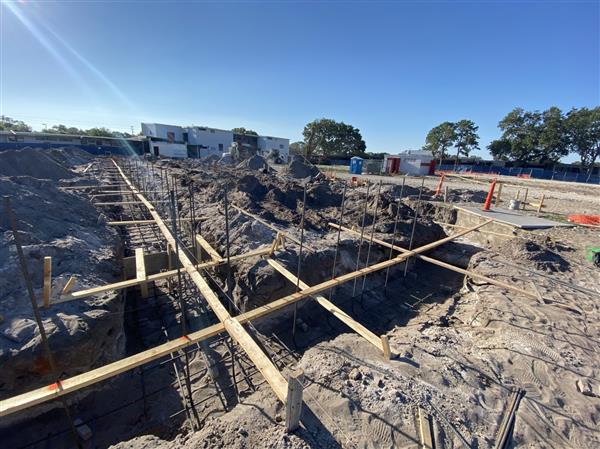

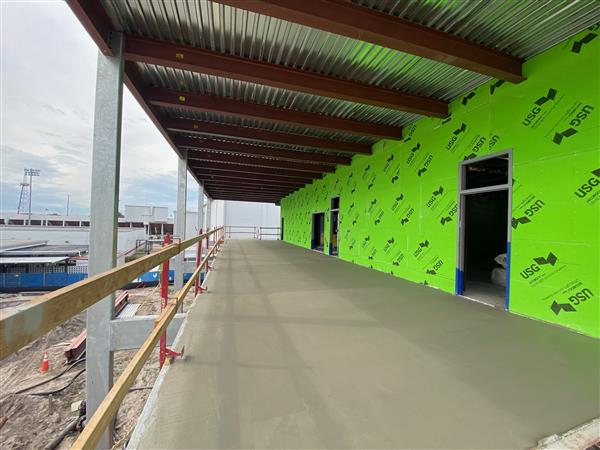

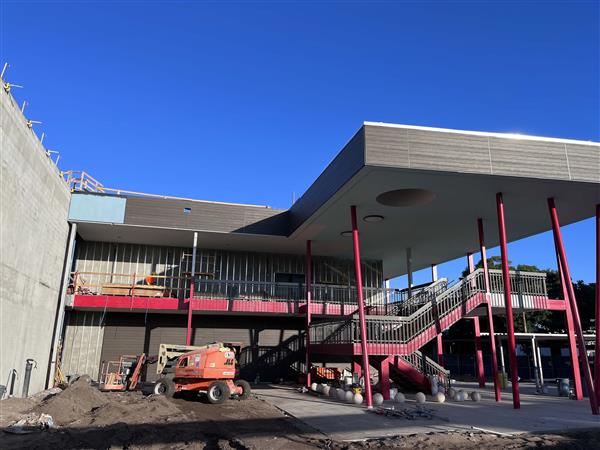

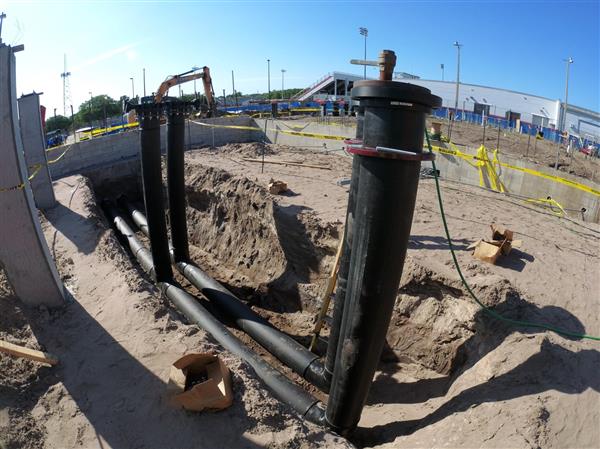

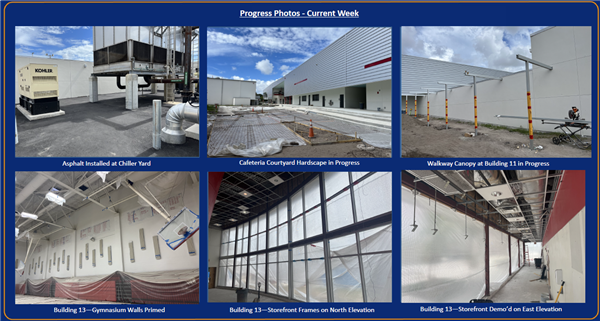

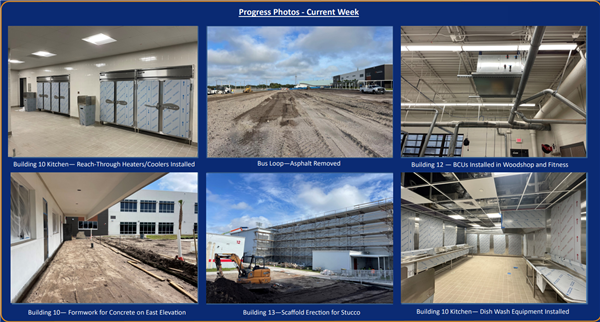

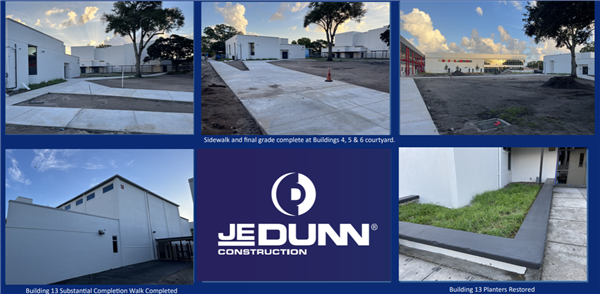

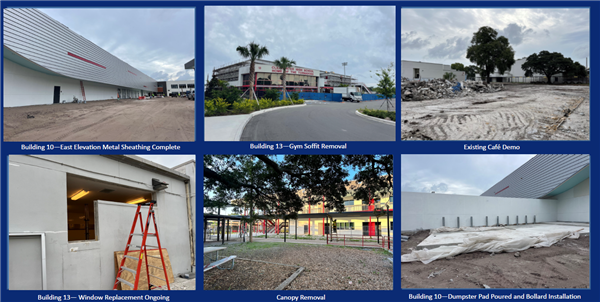

    Week of 5/15-5/19/23

    Building 10:

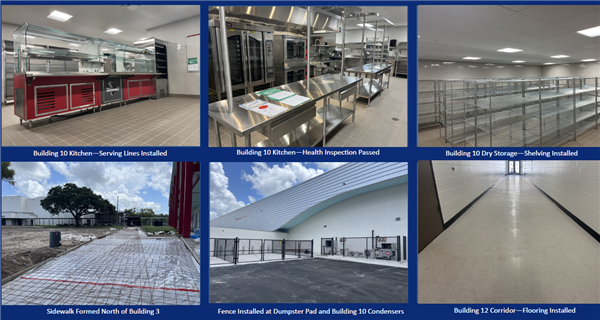

    • Wall tile in kitchen serving line complete
    • Kitchen quarry tile grouted
    • Stucco complete on east elevation
    • Exterior building number signs installed
    • 10A fire sprinkler pressure test passed

    Building 12:

    • Interior wood doors delivered

    Building 13:

    • Prepping punched openings for new windows

    Site:

    • Building 10 sidewalk on west elevation poured
