Facilities Design and Construction (FD&C)
Page Navigation
- Facilities Design & Construction (FD&C)
- Staff and Organizational Chart
- PAE Handbook and Design Criteria
- School Ed Specs
- Building Permit Application
- Current Major Building Projects
-
Completed Projects
- 2019 Cypress Woods Elementary School
- 2019 Lakewood High School
- 2020 Melrose Elementary School
- 2020 Pinellas Park Middle School
- 2020 Tarpon Springs High School
- 2021 North Shore Elementary School
- 2021 Northeast High School
- 2021 Richard O. Jacobson Technical High School at Seminole
- 2021 San Jose Elementary School
- 2021 Sanderlin IB K-8 School
- 2021 Sawgrass Lake Elementary School
- 2021 Shore Acres Elementary School
- 2022 Coachman Service Center
- 2022 Orange Grove Elementary School
- 2022 St. Petersburg High School
- 2023 Clearwater High School
- 2023 Lakewood High School
- 2023 Mangrove Bay Middle School
- 2023 Midtown Academy
- 2023 Mildred Helms Elementary School
- 2023 Pinellas Central Elementary School
- 2023 Seventy-Fourth St. Elementary School
- 2023 Tyrone Middle School
- 2024 Gibbs High School
- 2024 Gulf Beaches Elementary School
- 2024 Sandy Lane Elementary School
-

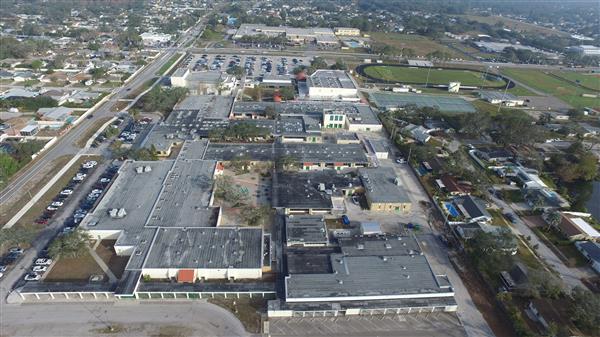

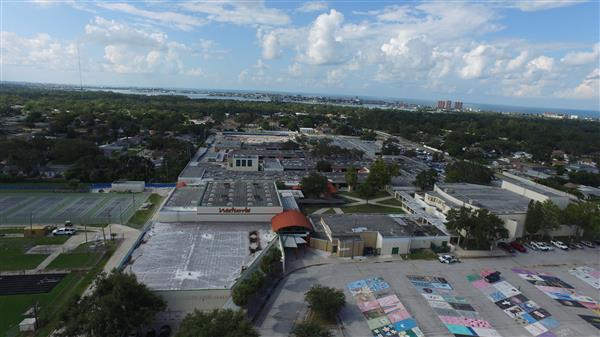

Seminole High School - New Construction, Renovations and Remodel
Project Information:
Architect: Wannemacher Jensen Architects
Contractor: Ajax Building Company, LLC
PCS Project Coordinator: Erin Ellis
Project Budget: 57,000,000
Start Date: March 2025
Completion: September 2027
Construction/Renovation of:
The project at Seminole High School includes the following new construction, renovation and remodeling campus wide:
- Roofing throughout campus using a 20-year liquid applied roof product
- Replacement of one chiller as it is nearing the end of its useful life

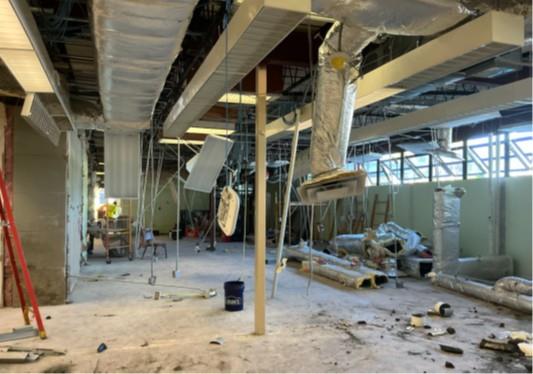

- HVAC – replacing all ceiling-mounted unit ventilators with vertical fan coil units as well as identifying any old HVAC equipment that has reached its useful life and replacing it.
- Campus electrical distribution throughout
- Refresh classrooms with paint, ceiling tiles, lighting, roller window shades, also ensure safety tinting film to be placed on all exterior windows, evaluate doors and hardware for replacement and new signage throughout the facility. Replace any smartboards with interactive projectors to make campus consistent.
- Cafeteria: demo, new construction and remodel of 6100 ft2
- New Kitchen and Cafeteria totaling 20,500 sq. ft. (kitchen, cafeteria, storage, mechanical)
- Demolish the west dining space and cafeteria, leaving the east dining space to be remodeled/renovated into new art classrooms.
- Outdoor dining/quad: rejuvenate to create a collegiate atmosphere and accommodate the school's one lunch system
- Creation of an entrance to give the campus more of a collegiate feel as well as improve parking and traffic flow
- Rework the parent drop-off/pick-up to create longer queuing
- Front Office, Administration Building and Guidance Suite: A complete remodel and change of layout may be needed depending on the design of the new front entrance. All new ceilings, floors, lights and paint throughout
- Exterior: repaint, reface and ensure the entire campus has a unified paint scheme
- Refresh of Media Center: new ceilings, lights, flooring and paint
- Remodel/relocation of the arts classroom which is to be placed into the remodeled east dining room
- Refresh hallways with ceiling tiles, paint, lighting and flooring (selective removal of lockers)
- Demolish Buildings 9 and 11-14
- Building 10: remove Hauserman partitions and replace them with new partitions as required
- Auditorium and Gymnasium: evaluate lighting and have recommendations on replacement or remain as is
- Music Building
- Create a vestibule to control unconditioned air from entering the building for the band
- Create a stage/performance space for band/chorus performances/practices
- Add security cameras where needed to ensure campus has complete coverage (district will provide locations of inadequacies)

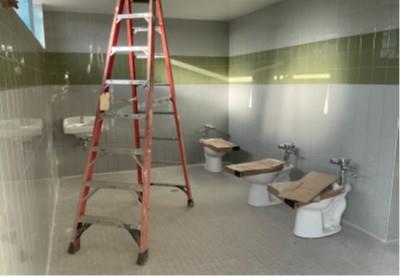

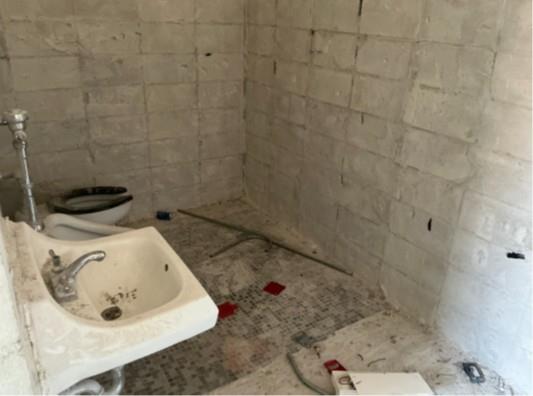

- Renovate restrooms throughout the entire facility
- Evaluate plumbing throughout for possible re-coating of water and sanitary lines throughout the campus
- The district has facility assessments for plumbing scope

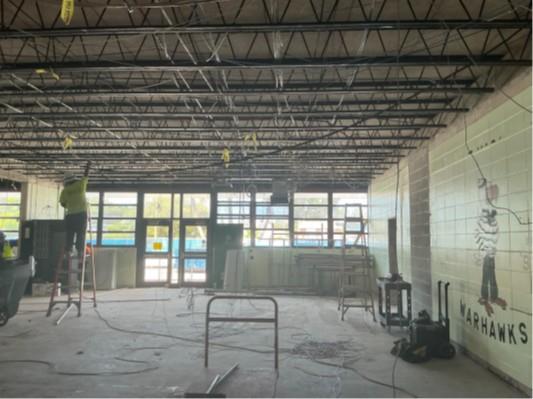

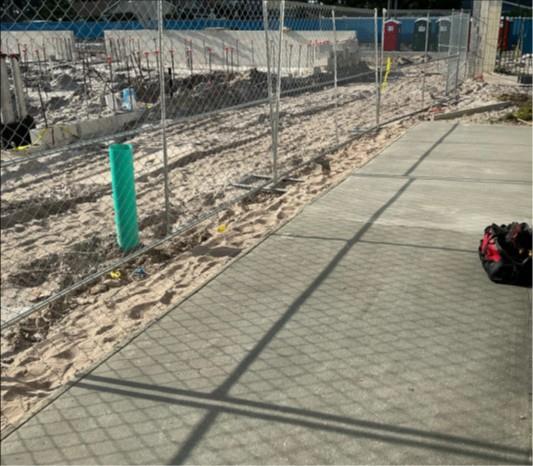

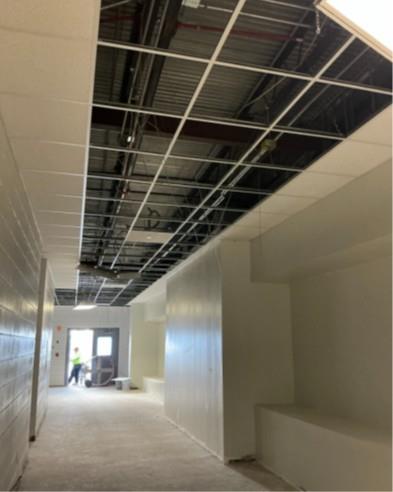

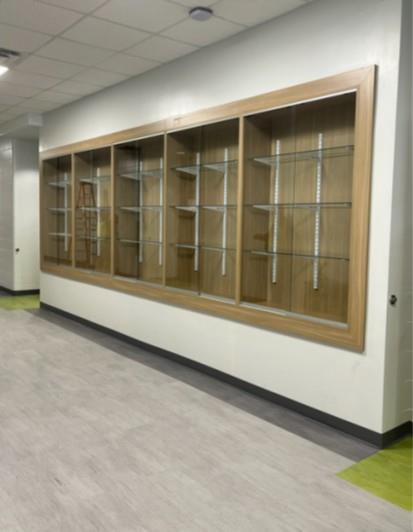

Project Status:

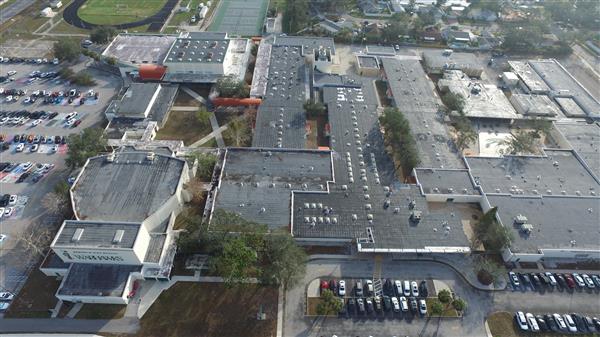

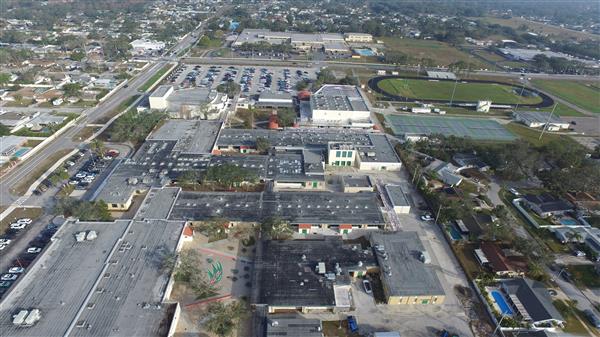

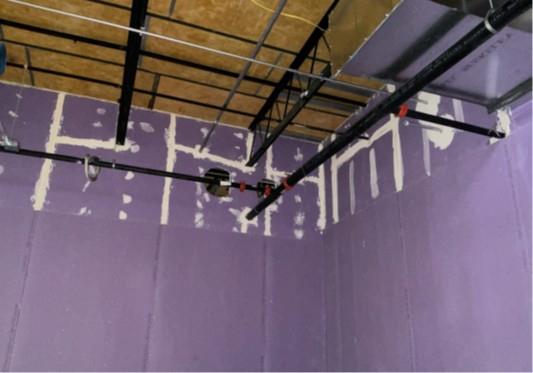

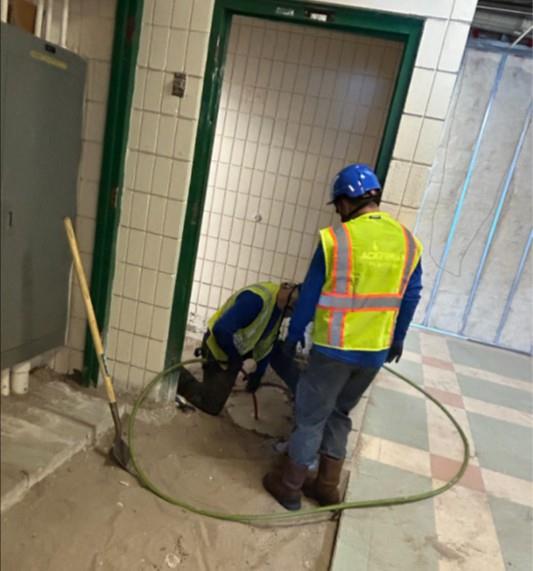

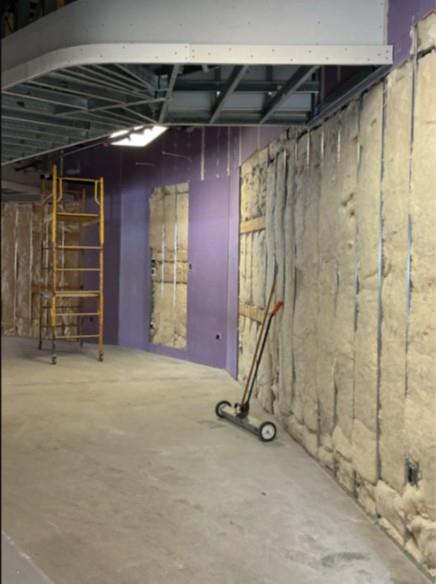

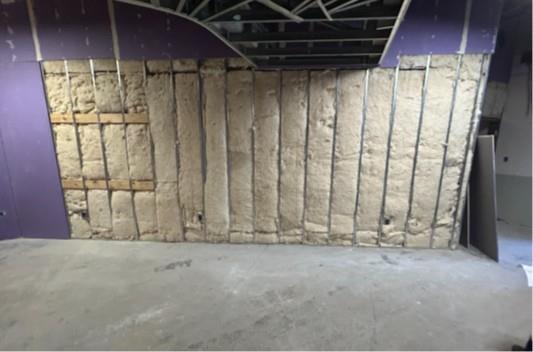

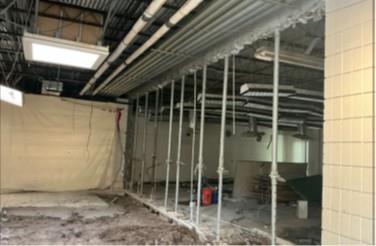

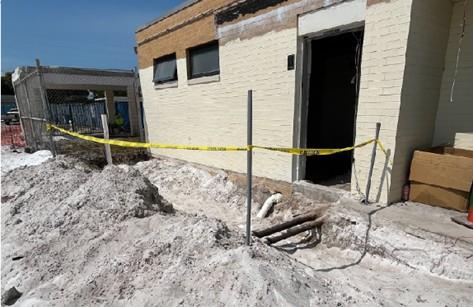

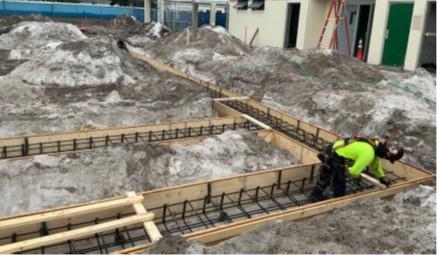

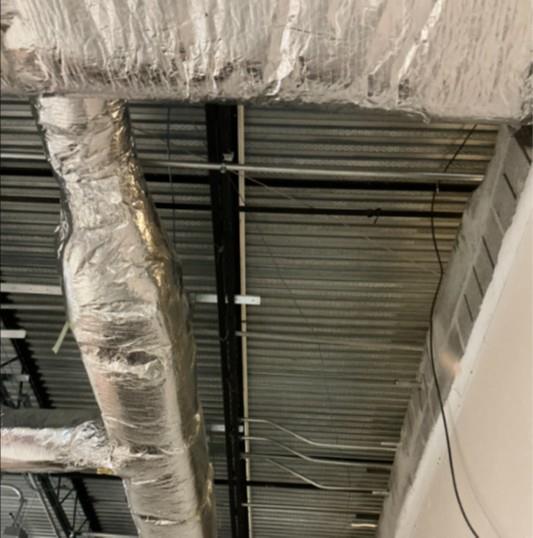

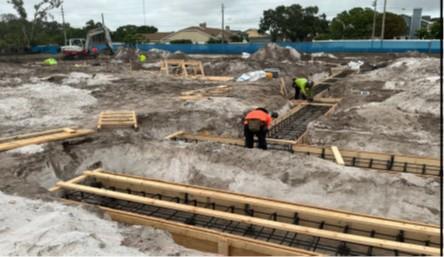

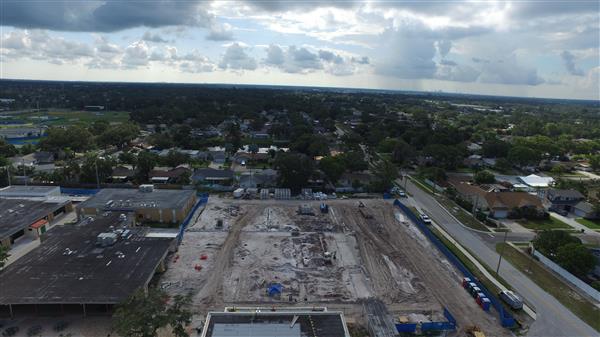

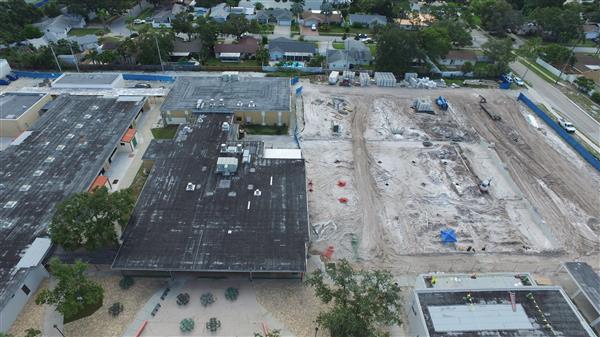

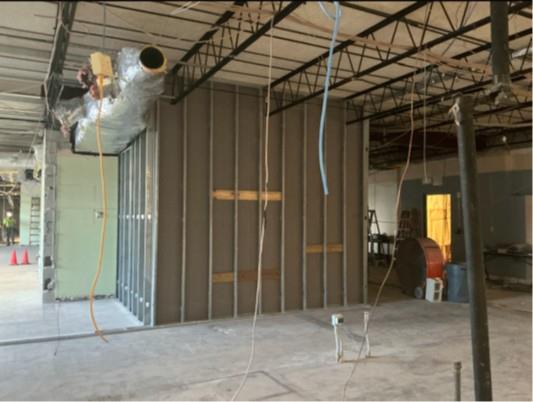

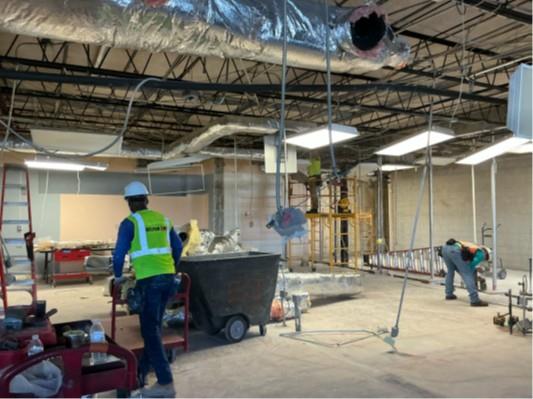

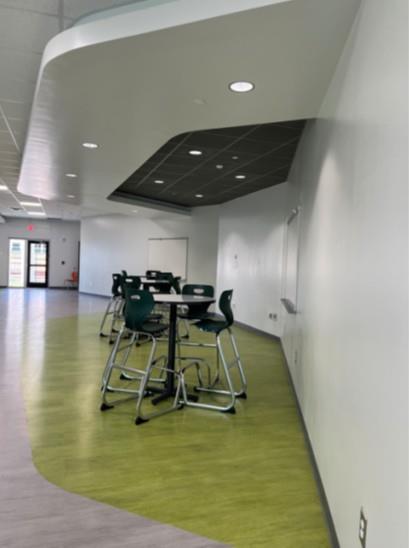

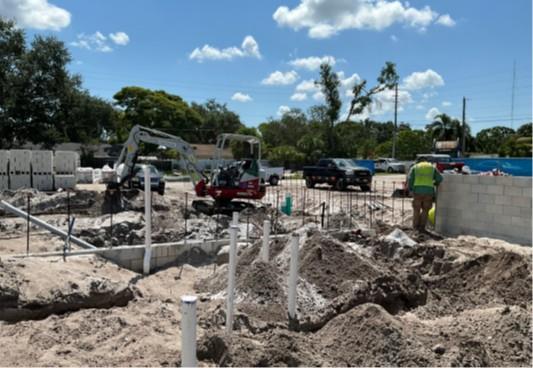

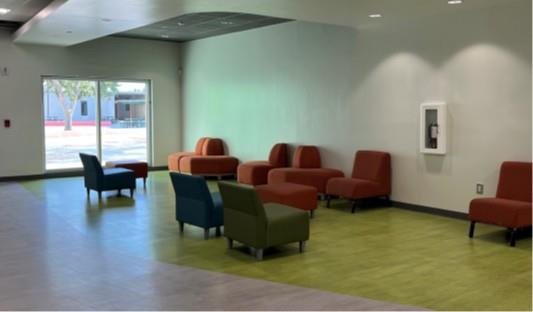

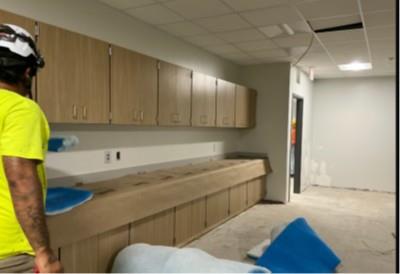

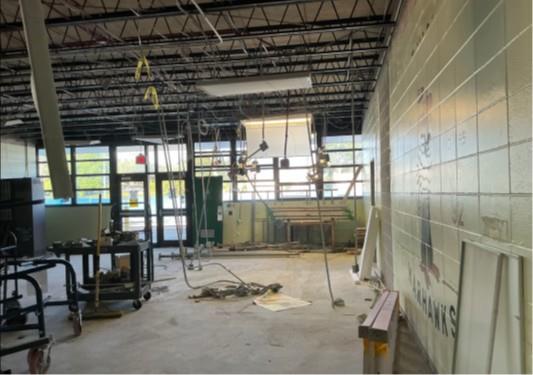

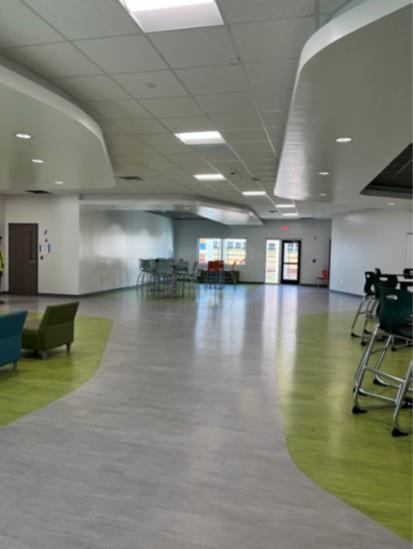

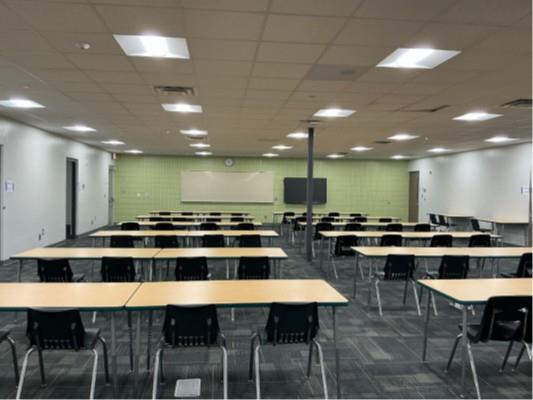

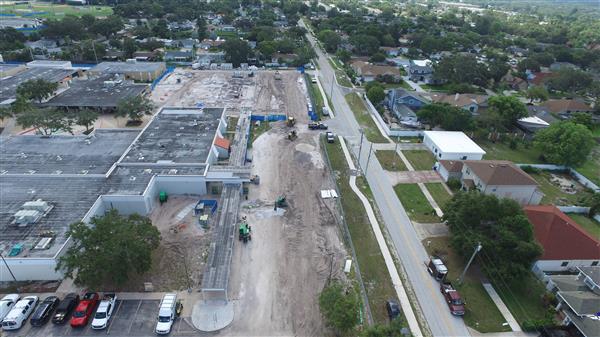

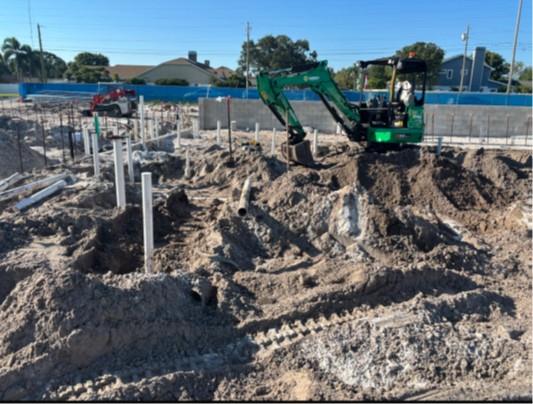

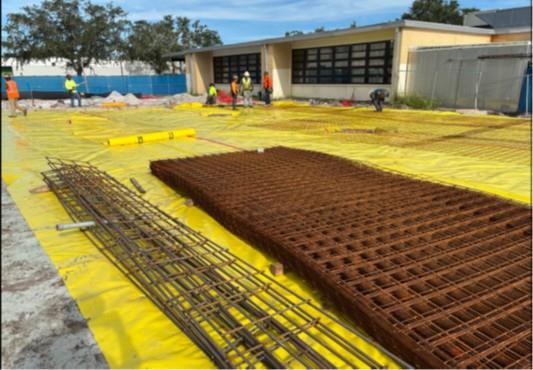

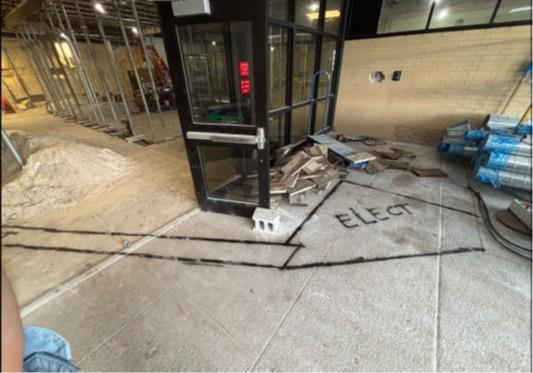

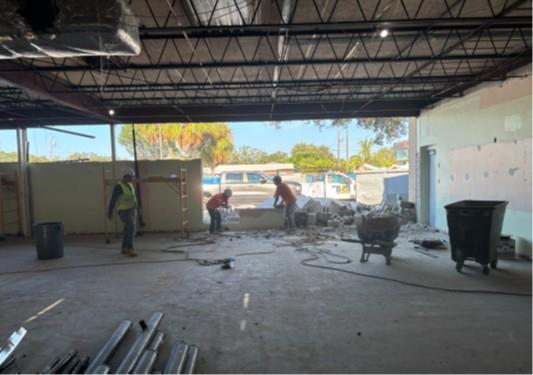

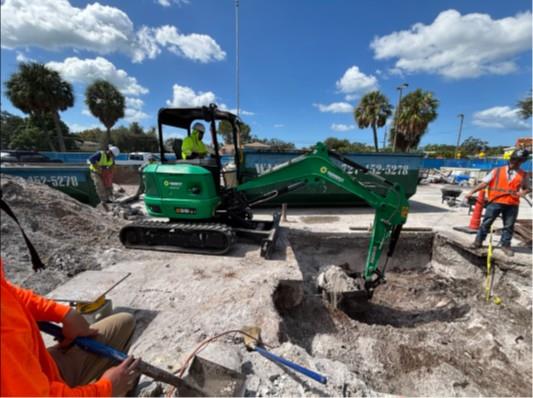

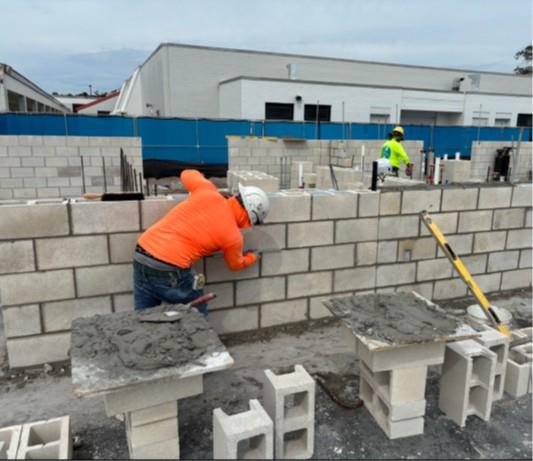

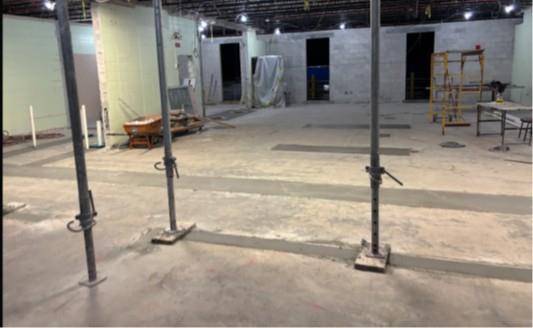

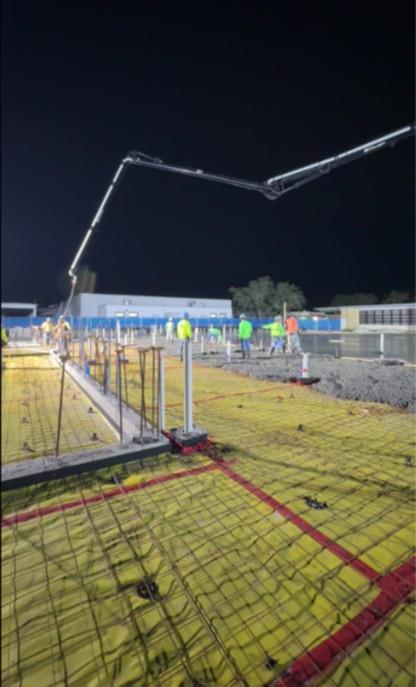

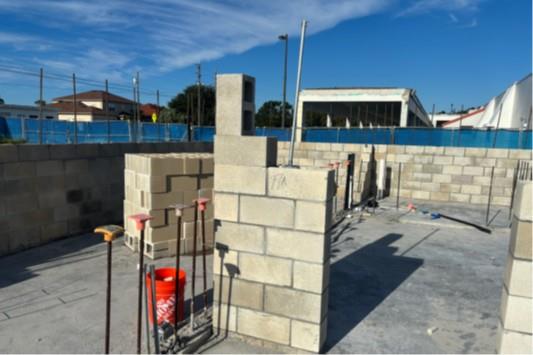

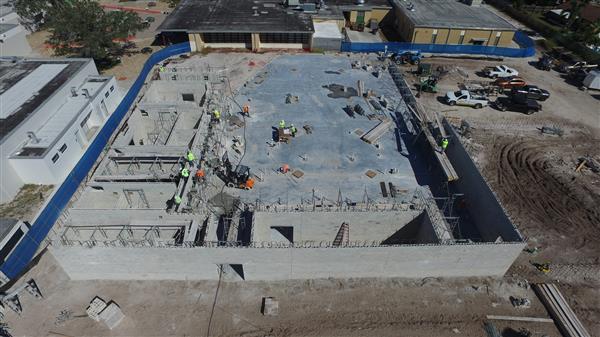

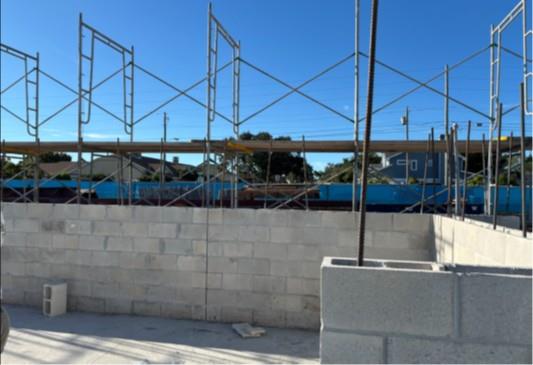

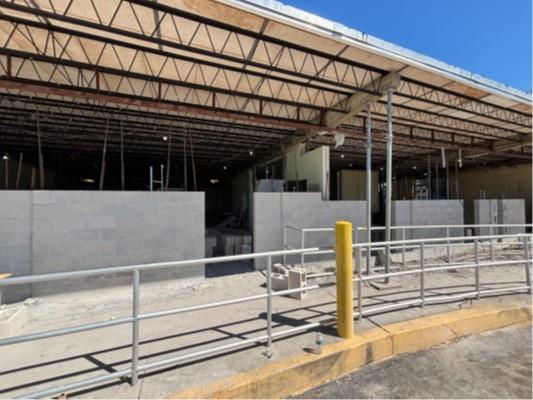

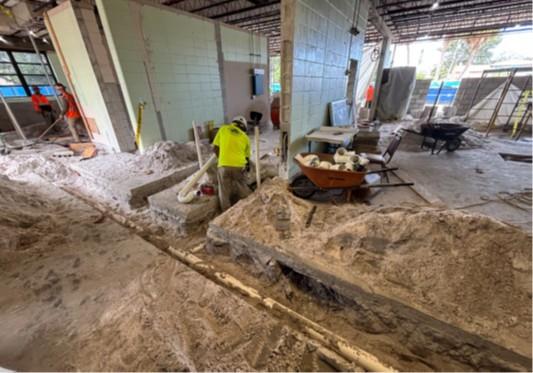

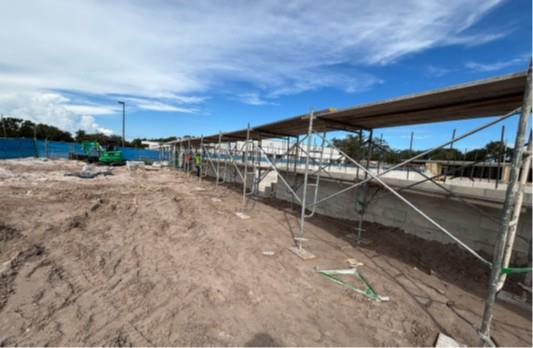

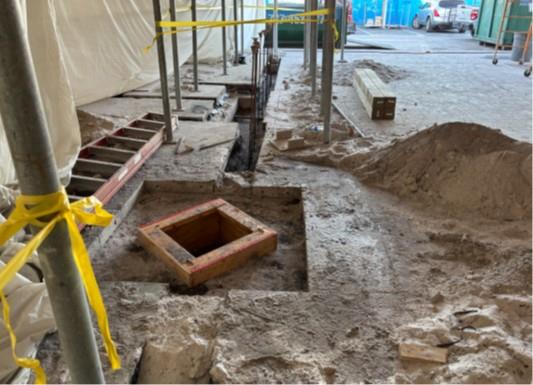

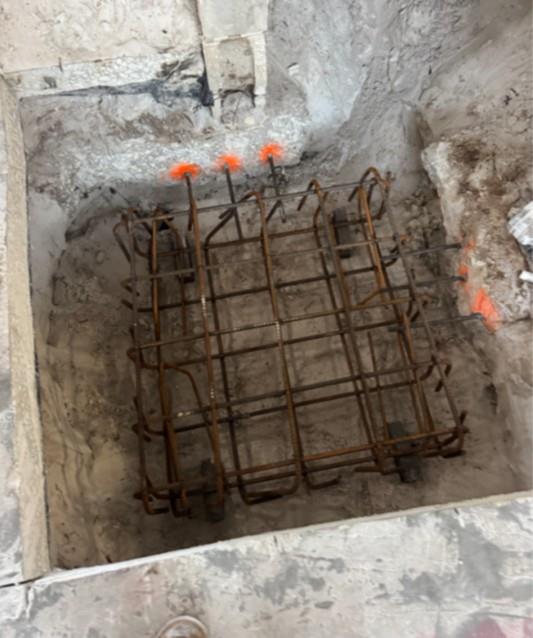

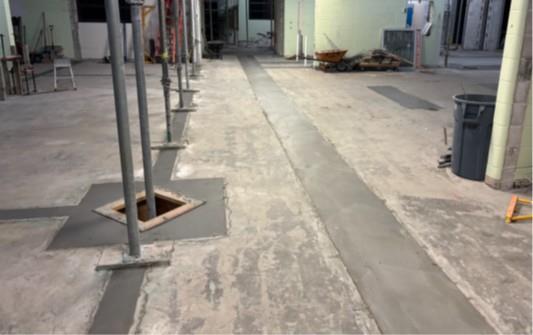

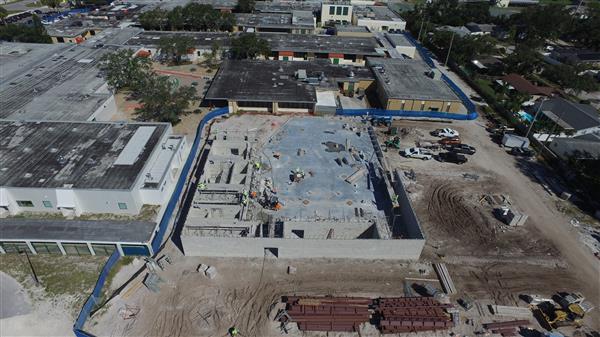

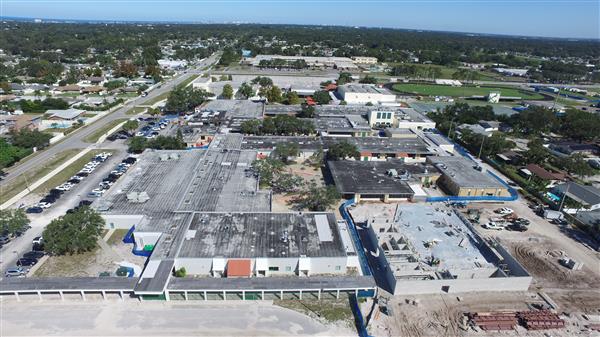

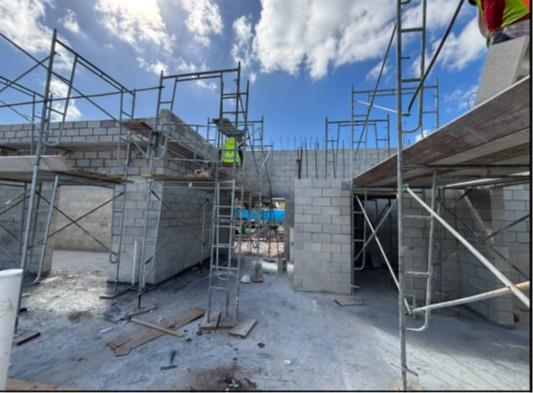

Week of 3/7/25

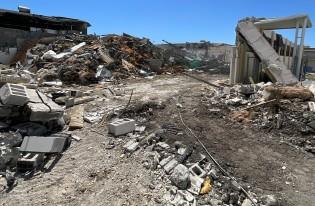

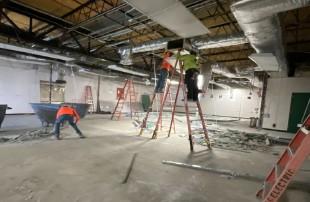

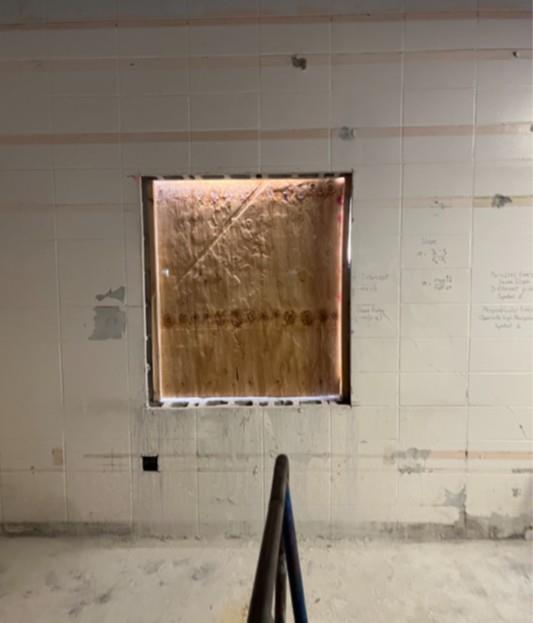

- Ajax mobilization and site set up

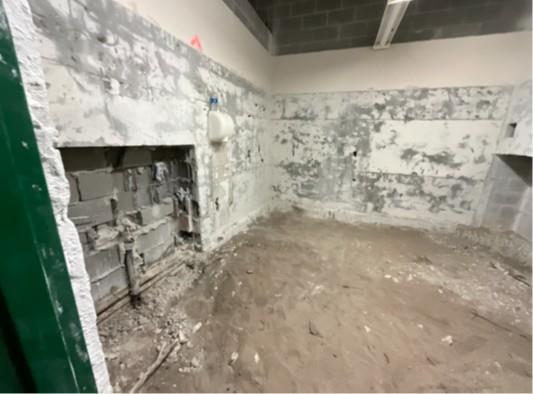

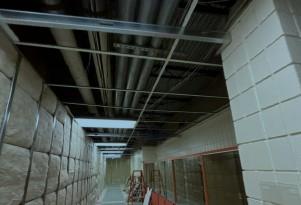

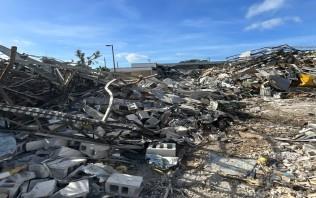

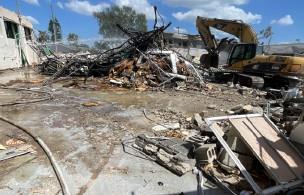

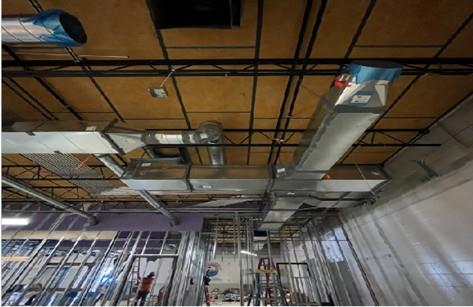

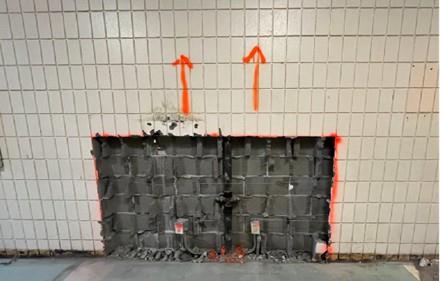

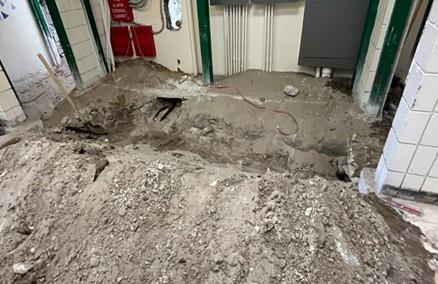

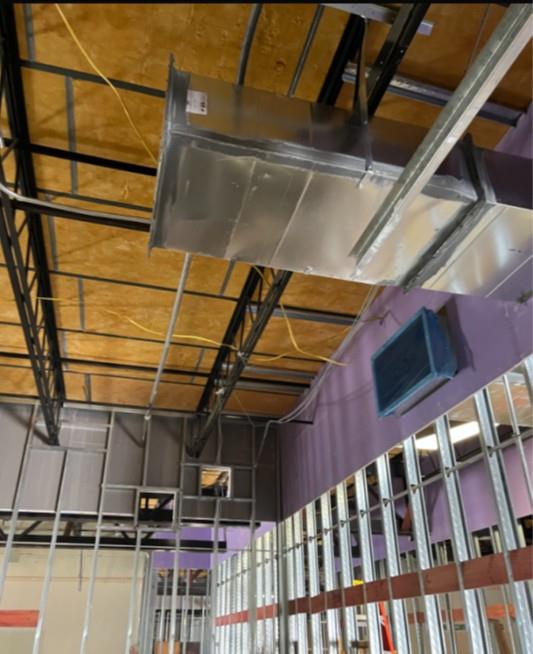

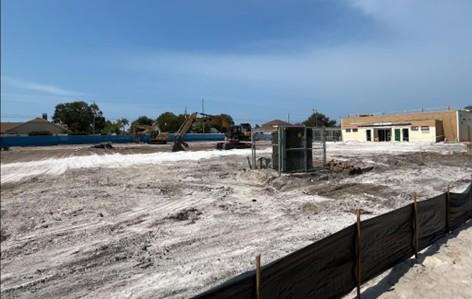

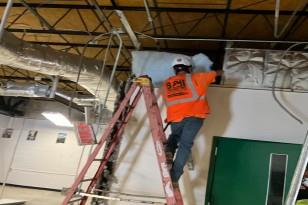

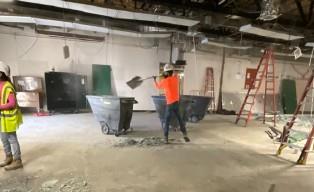

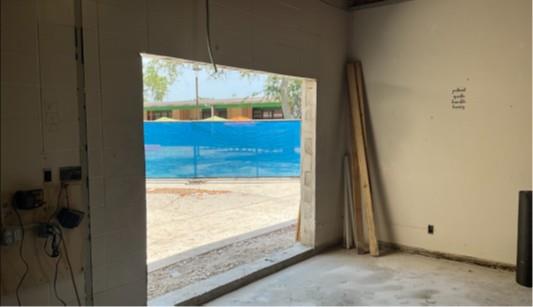

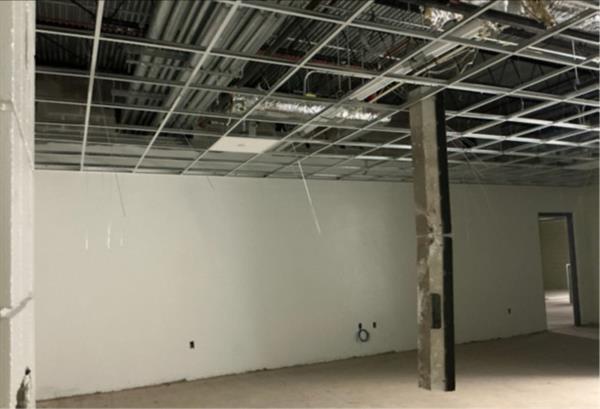

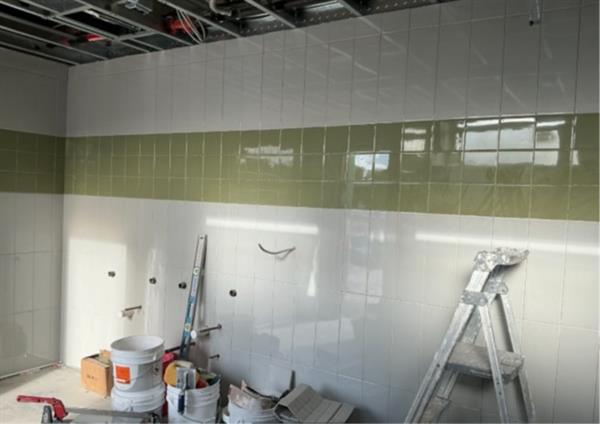

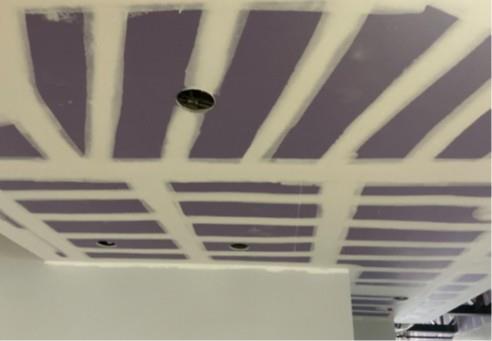

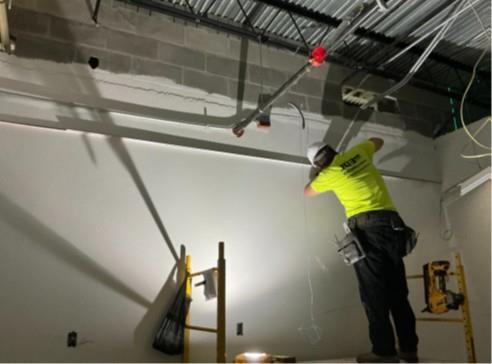

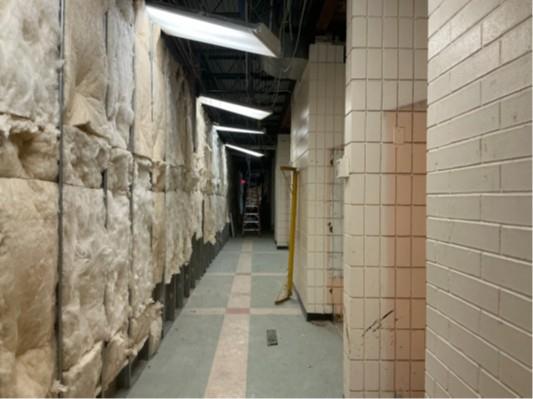

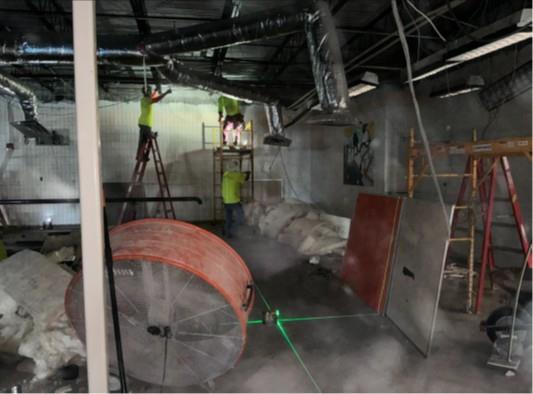

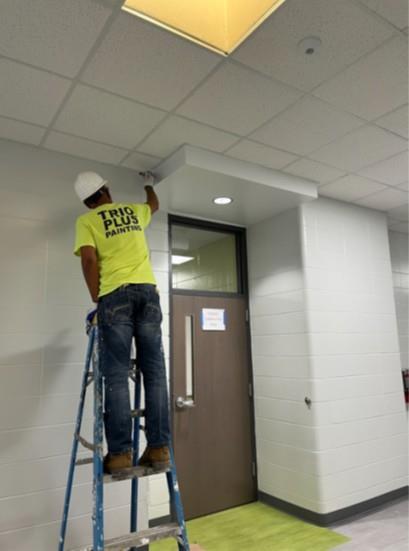

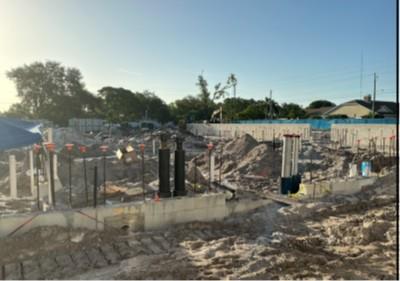

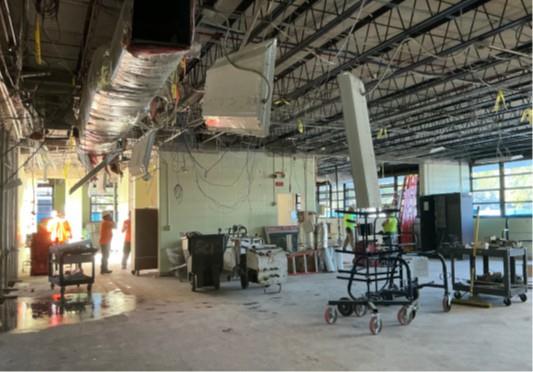

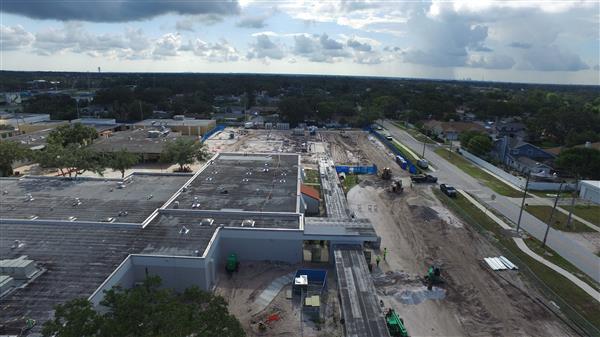

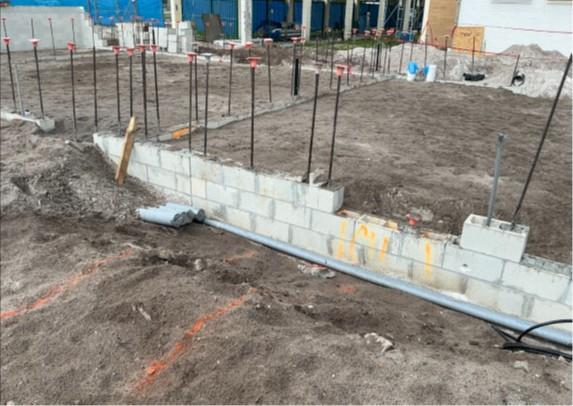

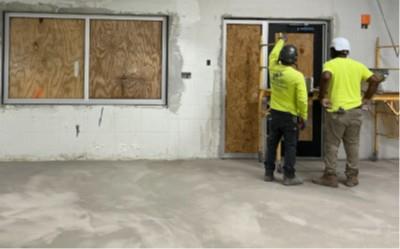

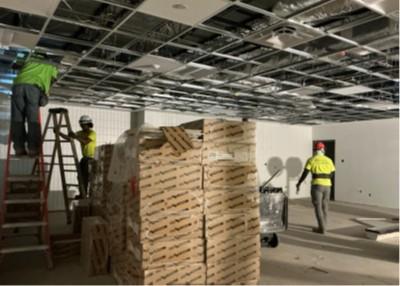

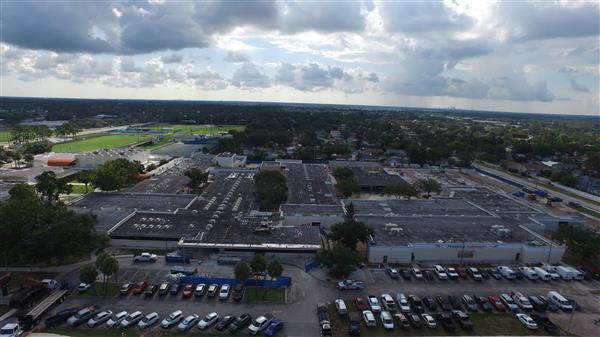

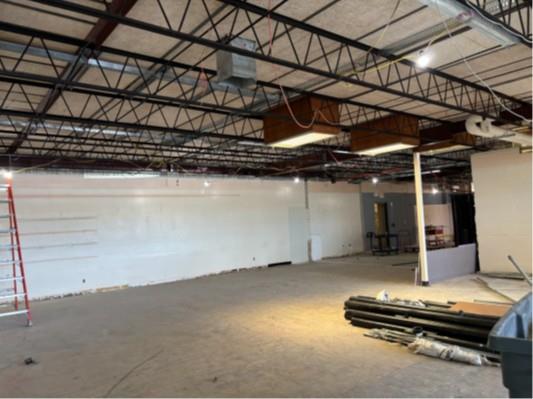

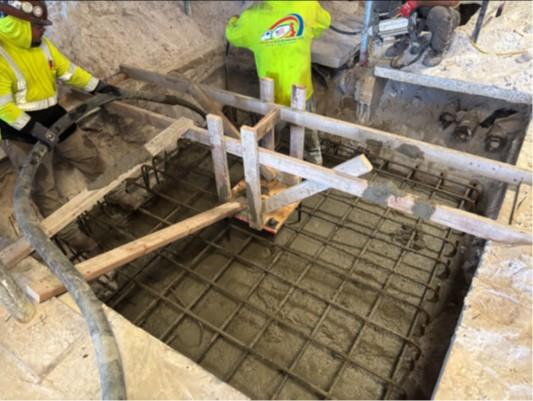

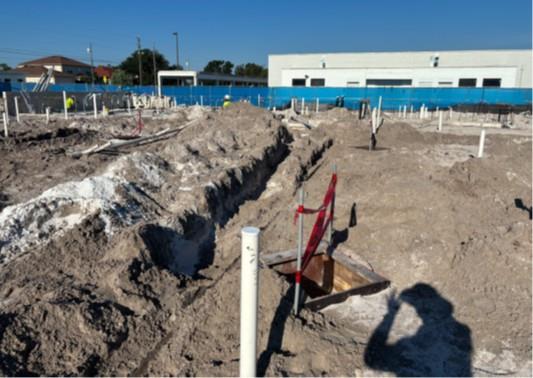

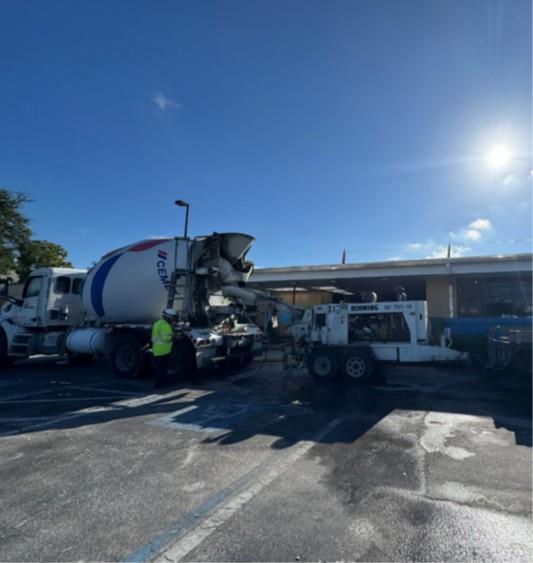

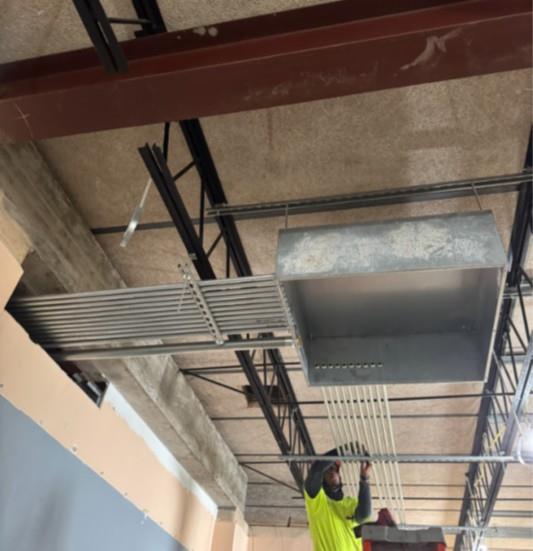

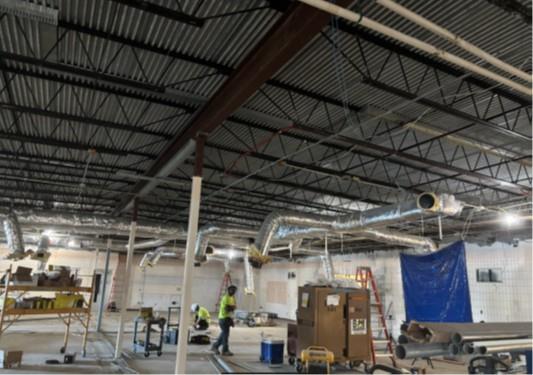

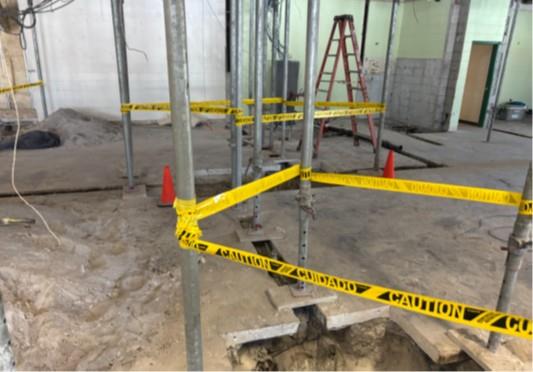

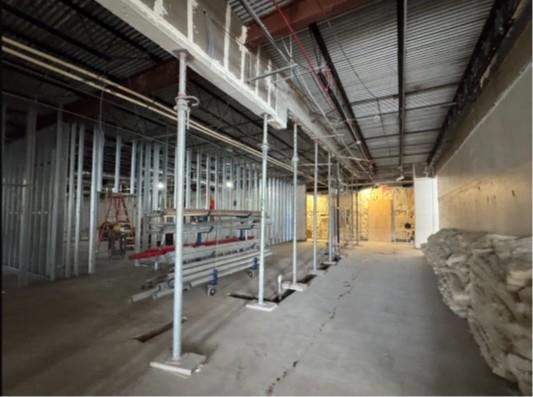

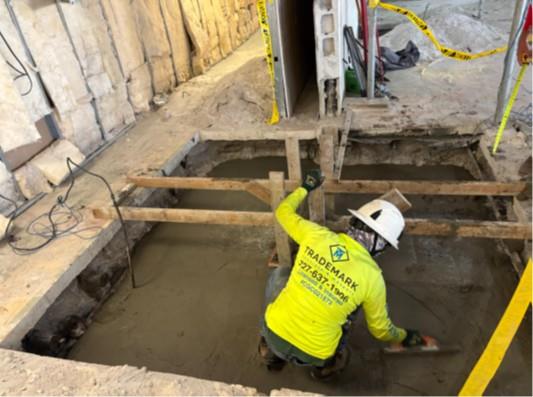

- Asbestos abatement completed on Buildings 11, 12, 13 and 14
