Facilities Design and Construction (FD&C)
Page Navigation
- Facilities Design & Construction (FD&C)
- Staff and Organizational Chart
- PAE Handbook and Design Criteria
- School Ed Specs
- Building Permit Application
- Current Major Building Projects
-
Completed Projects
- 2019 Cypress Woods Elementary School
- 2019 Lakewood High School
- 2020 Melrose Elementary School
- 2020 Pinellas Park Middle School
- 2020 Tarpon Springs High School
- 2021 North Shore Elementary School
- 2021 Northeast High School
- 2021 Richard O. Jacobson Technical High School at Seminole
- 2021 San Jose Elementary School
- 2021 Sanderlin IB K-8 School
- 2021 Sawgrass Lake Elementary School
- 2021 Shore Acres Elementary School
- 2022 Coachman Service Center
- 2022 Orange Grove Elementary School
- 2022 St. Petersburg High School
- 2023 Clearwater High School
- 2023 Lakewood High School
- 2023 Mangrove Bay Middle School
- 2023 Midtown Academy
- 2023 Mildred Helms Elementary School
- 2023 Pinellas Central Elementary School
- 2023 Seventy-Fourth St. Elementary School
- 2023 Tyrone Middle School
- 2024 Gibbs High School
- 2024 Gulf Beaches Elementary School
- 2024 Sandy Lane Elementary School
Leadership Center
-
Leadership Center - New Building
Project Information:
Architect: Rowe Architects
Contractor: Skanska
PCS Project Coordinator: Javier Perez
Project Budget: $15,400,000

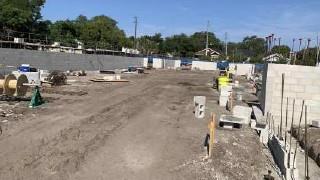

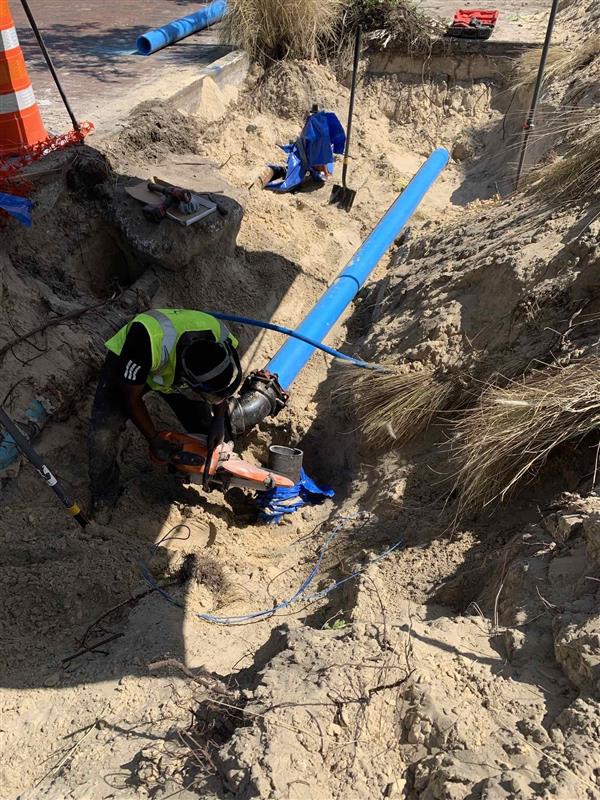

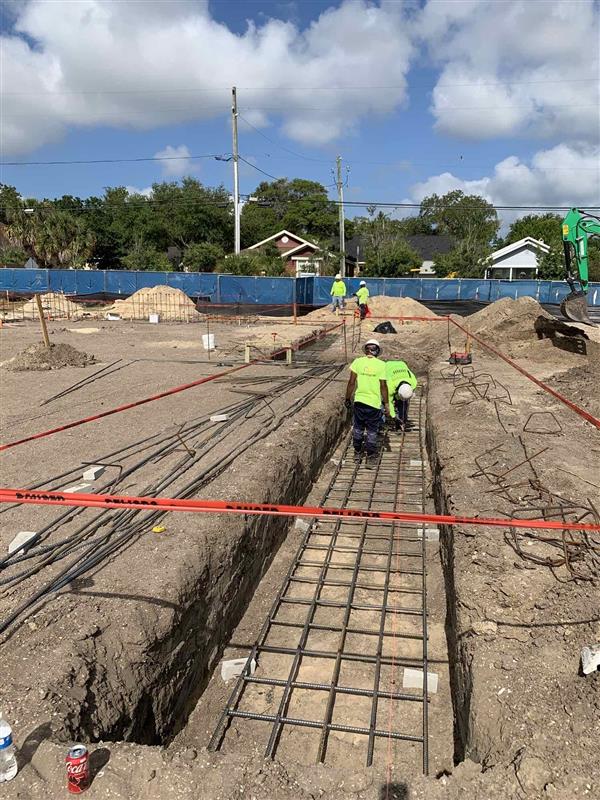

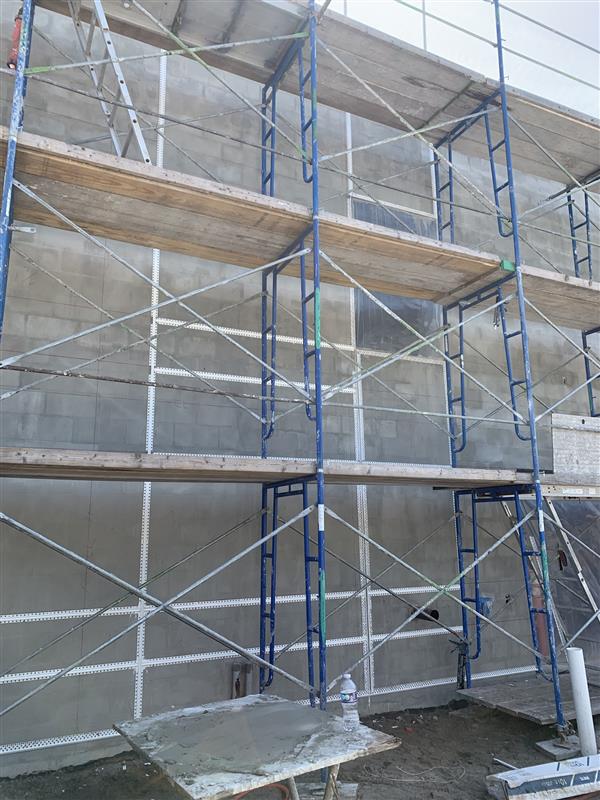

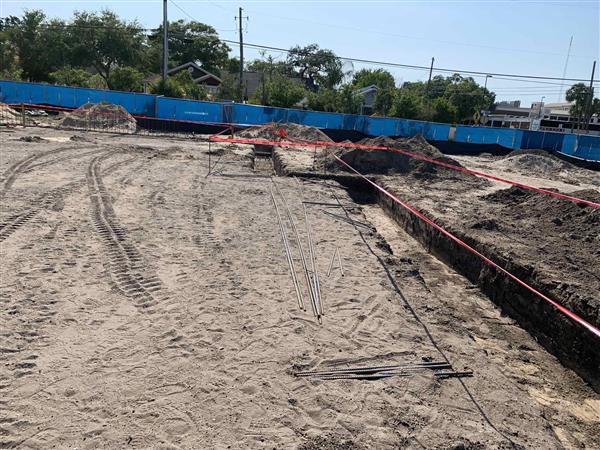

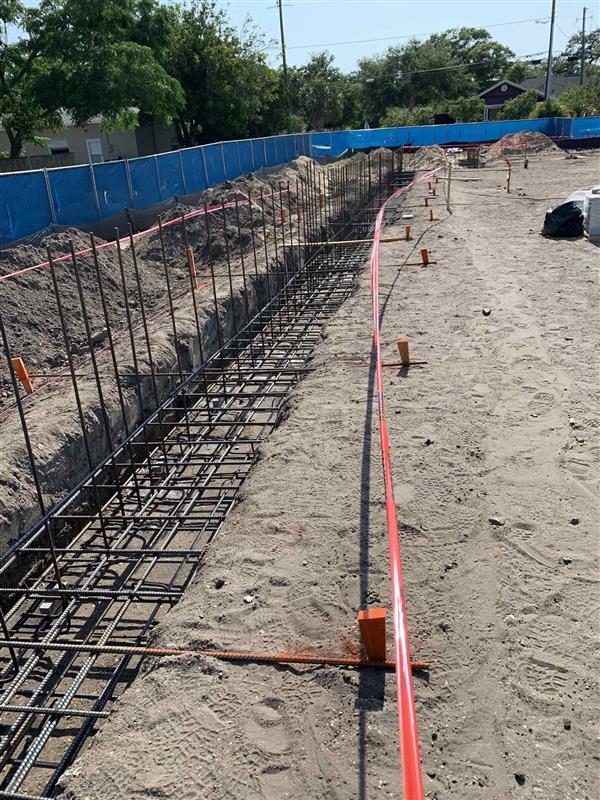

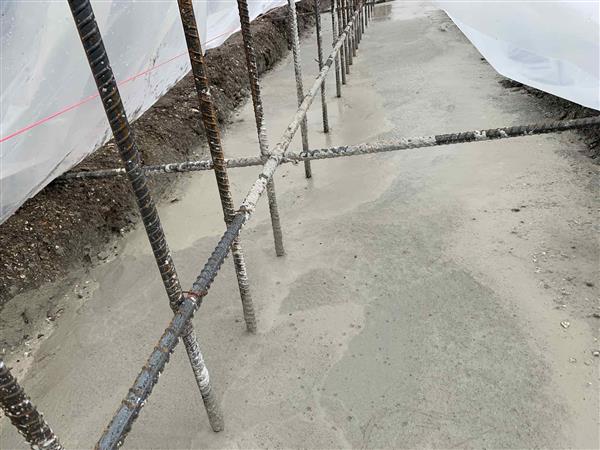

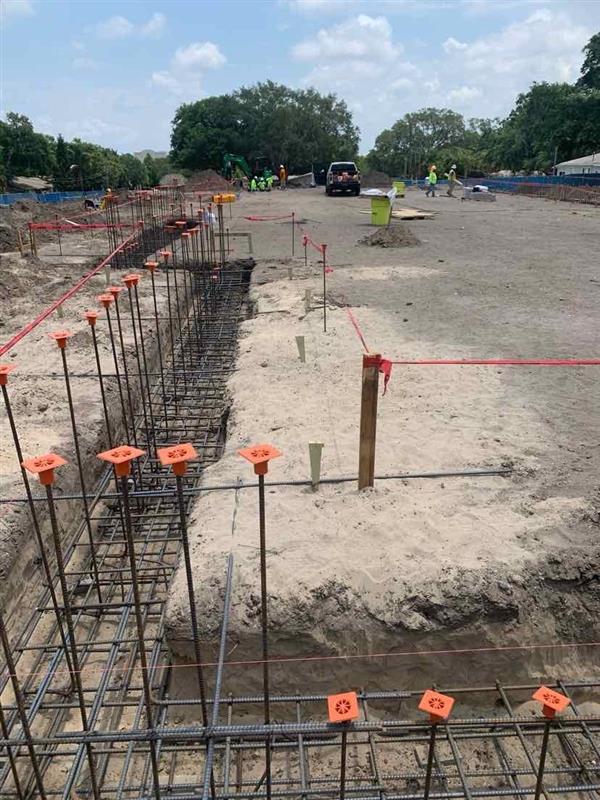

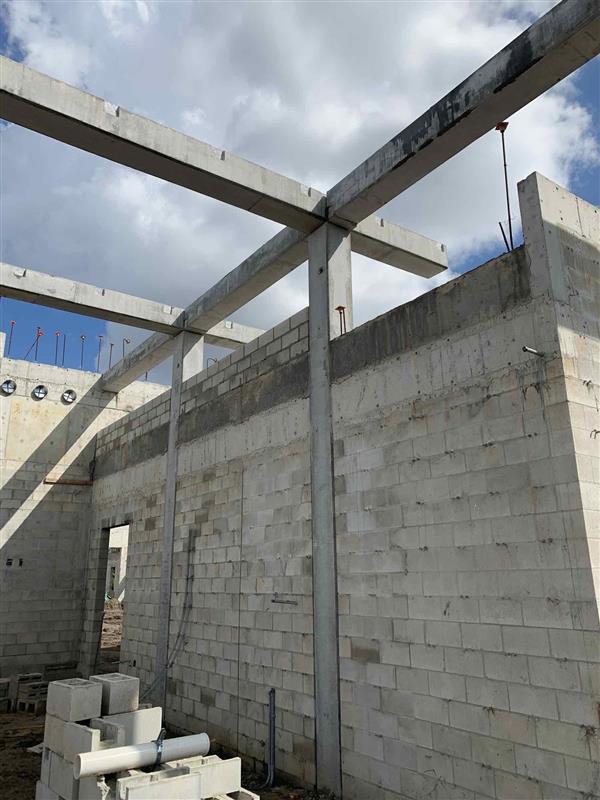

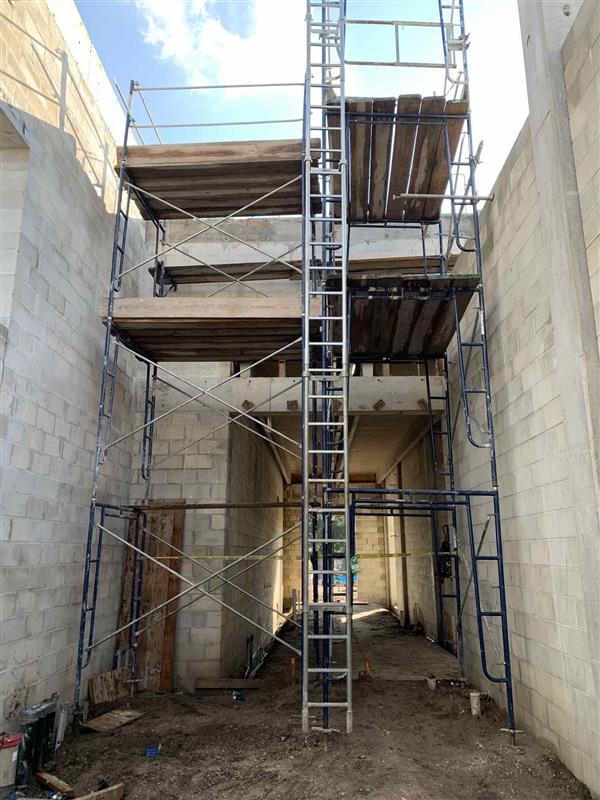

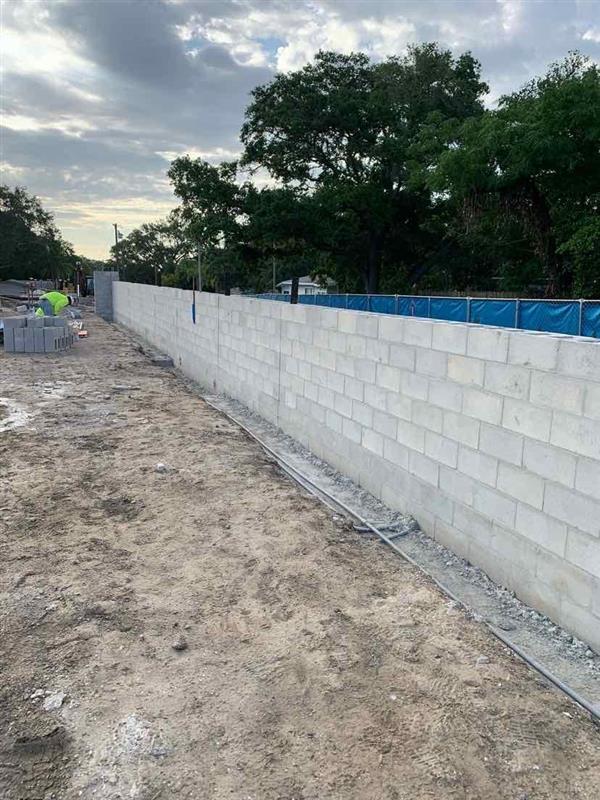

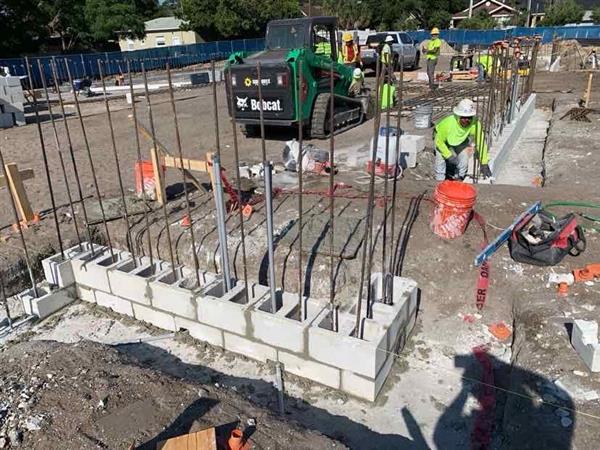

Start Date: January 2024
Completion: July 2025

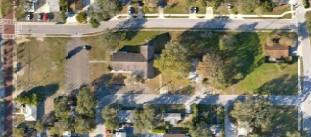

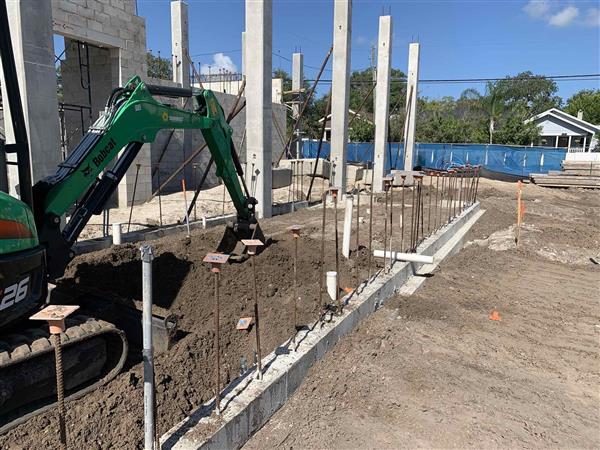

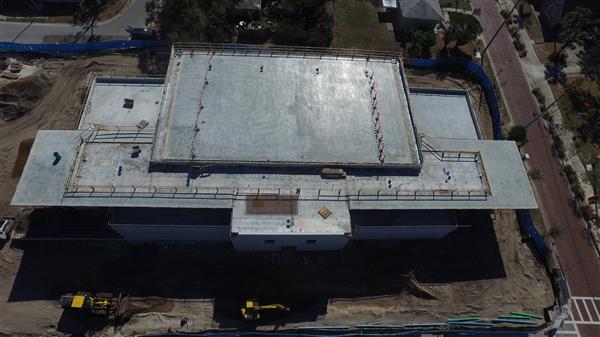

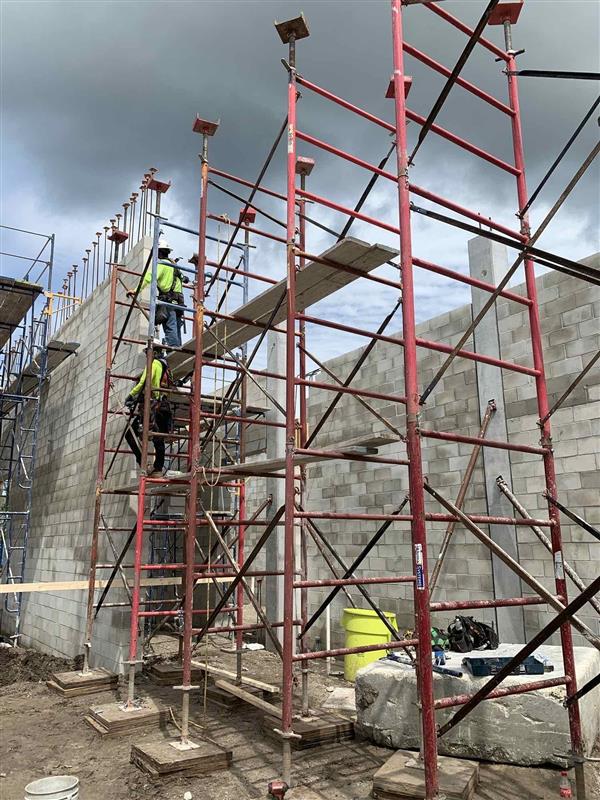

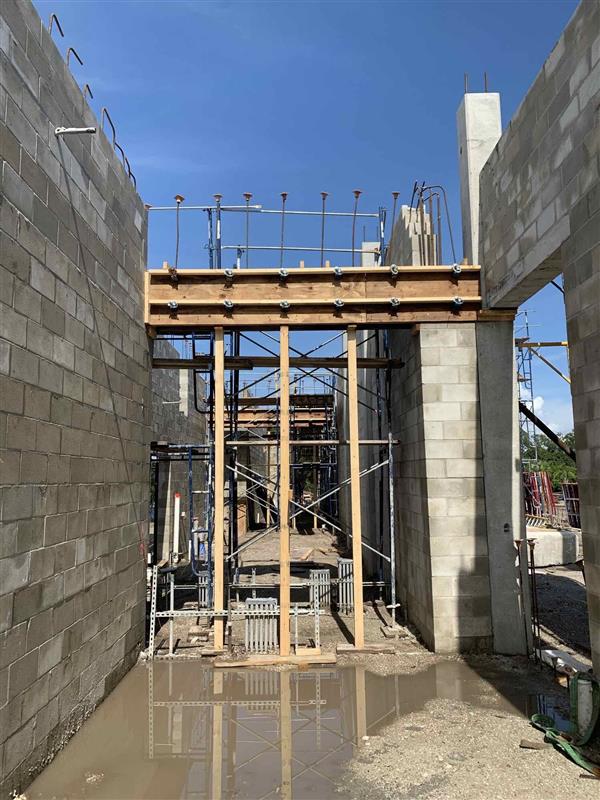

Construction/Renovation of:

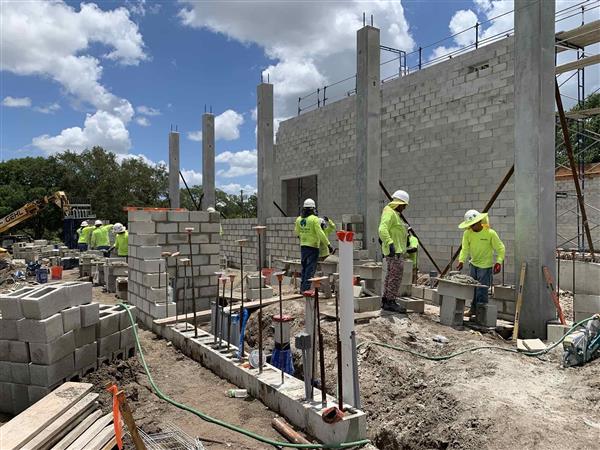

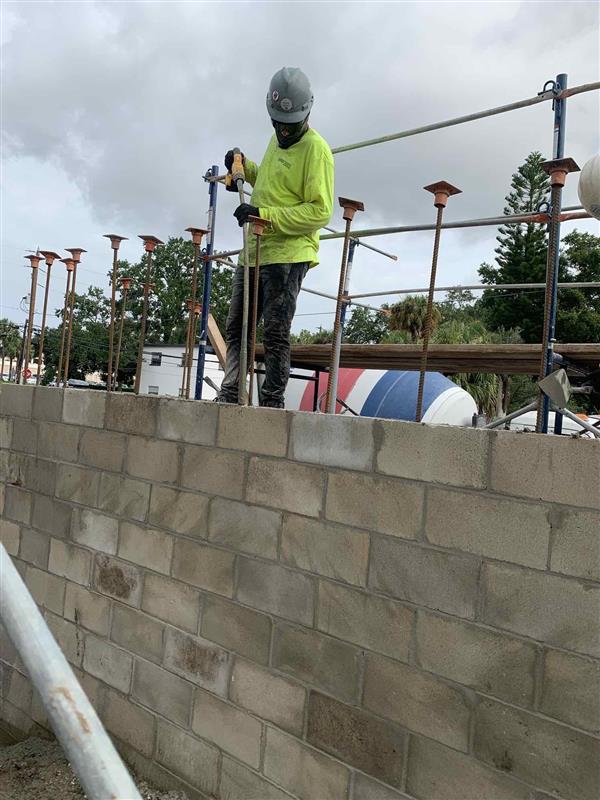

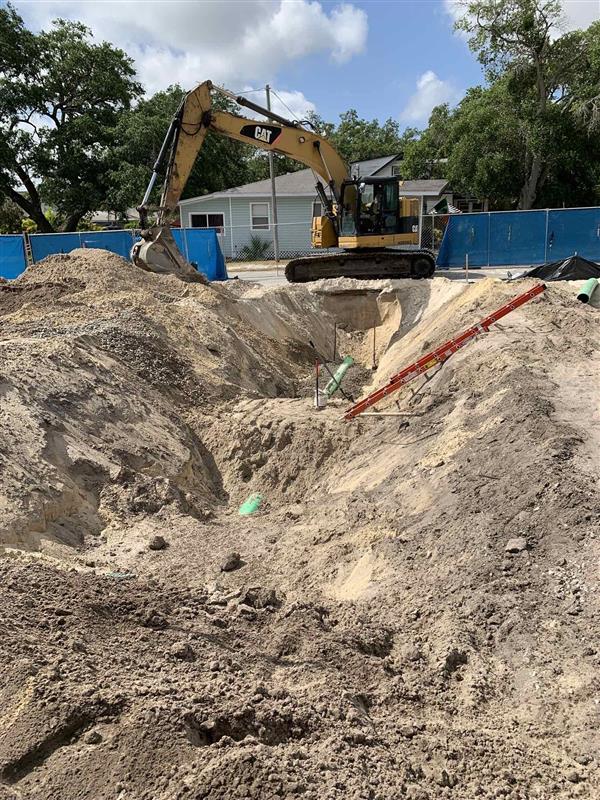

The project includes new construction of a 21st century Leadership Center to enhance the growth of working professionals within the district and the surrounding community. The project’s goal is to construct a new multi-use facility.
New construction will include:

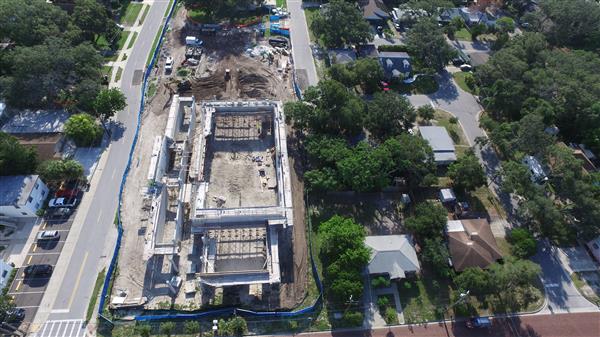

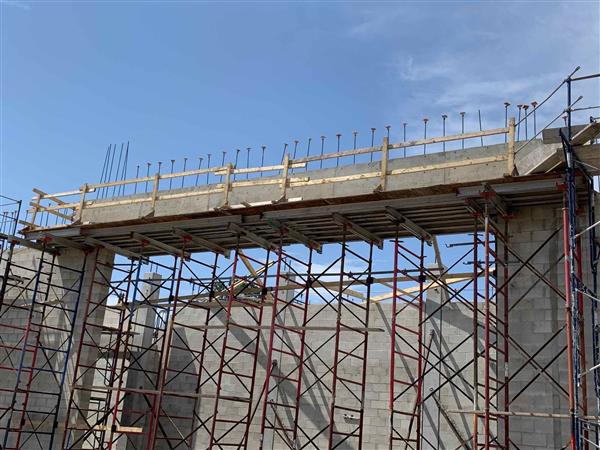

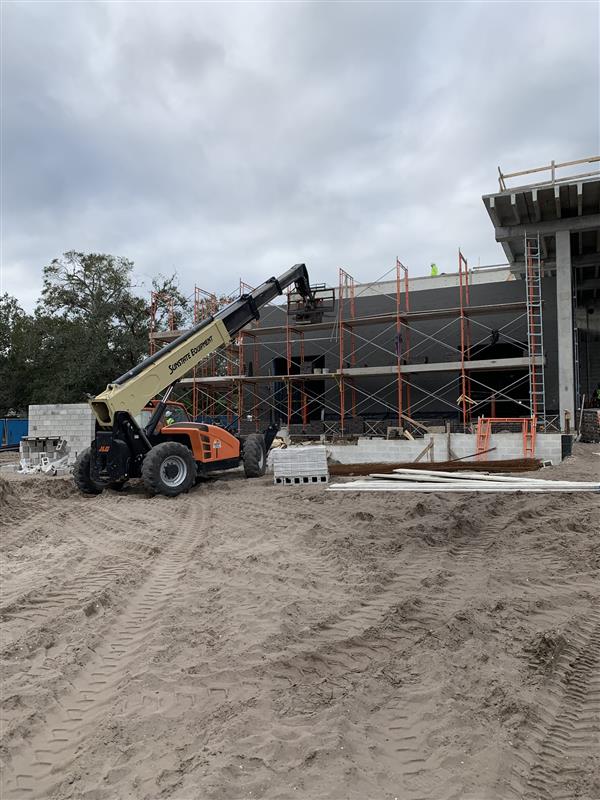

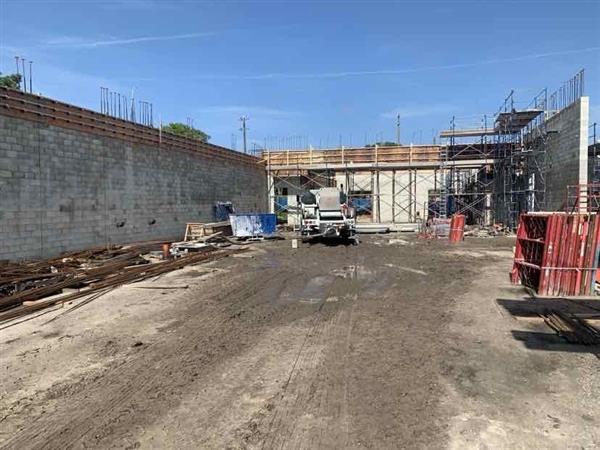

- New construction of a 14,690 square foot multi-use facility
- Open concept plan that incorporates:

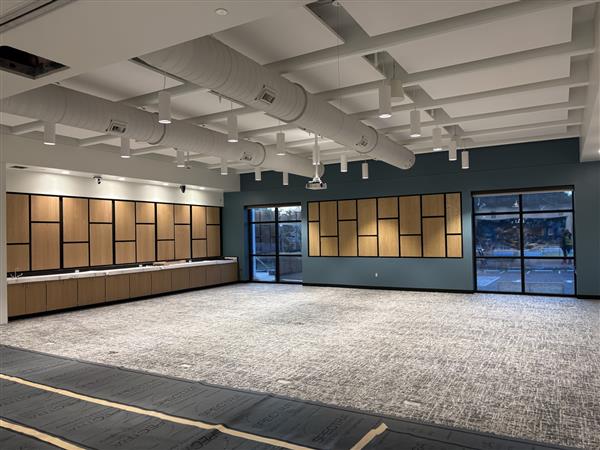

- Large training room that could also host community events
- Small break out rooms adjacent to the large training room

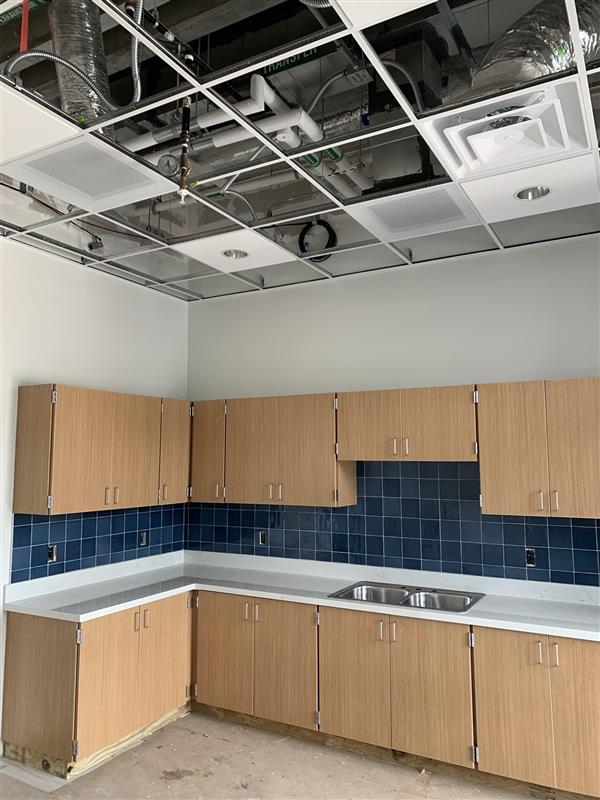

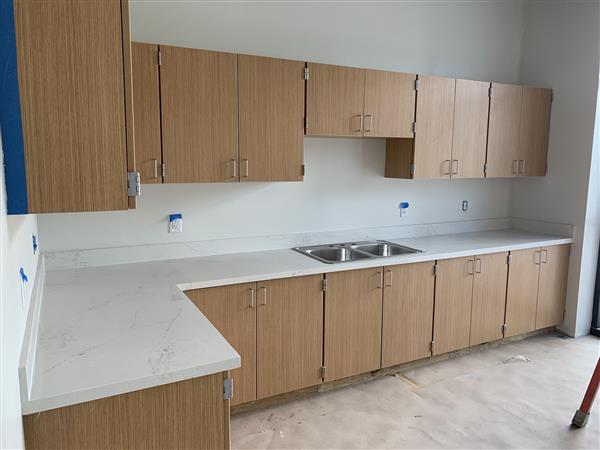

- Serving kitchen area

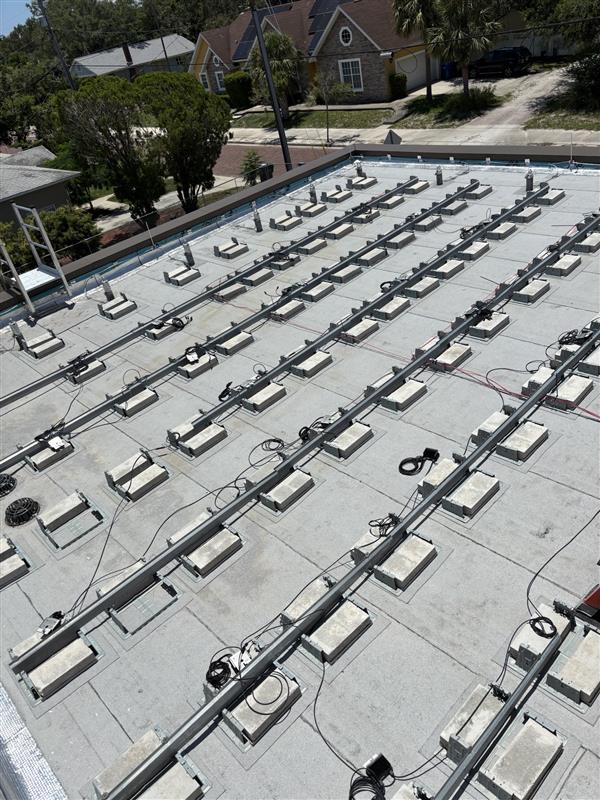

- Use of photovoltaic panels is highly anticipated
- New asphalt parking lot for up to 50 cars and grass parking for overflow

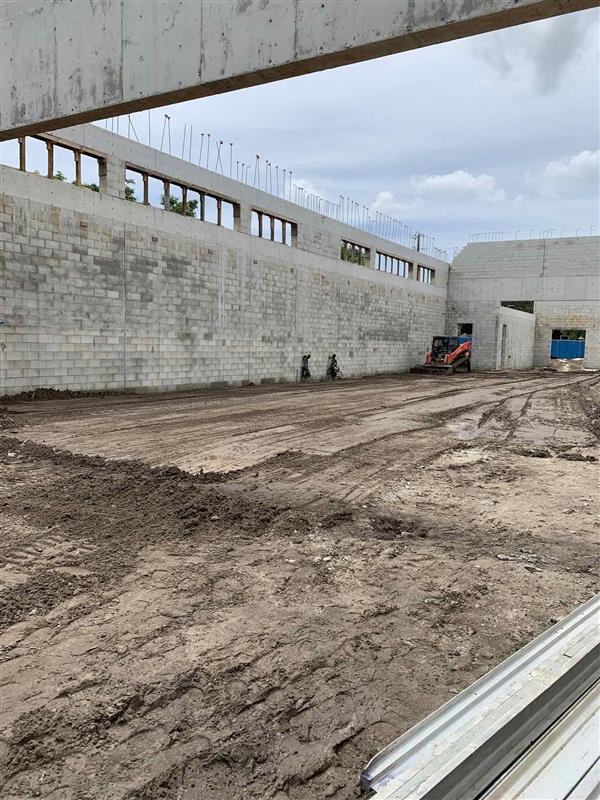

Demolition will include:

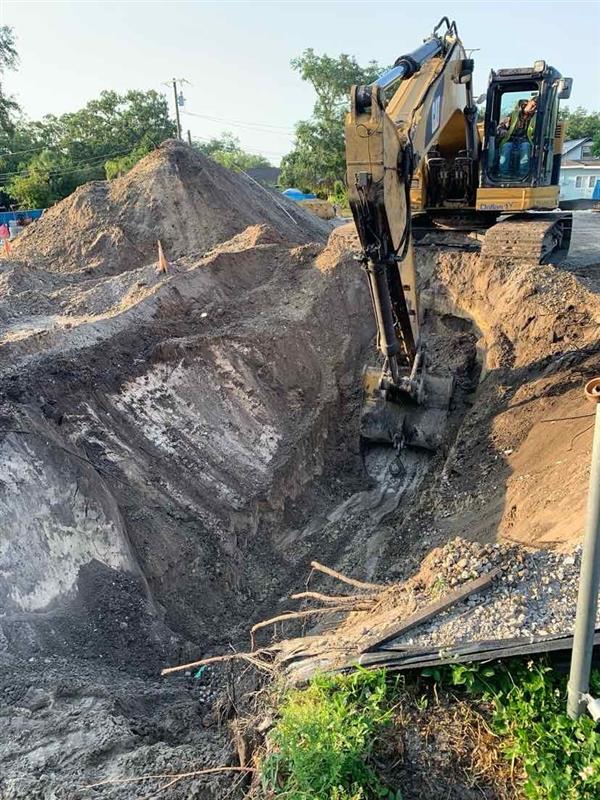

- Removal of existing 7,400 sq. ft. Center for Professional Education Building
- Removal of existing 2,000 sq. ft. Ancillary Building

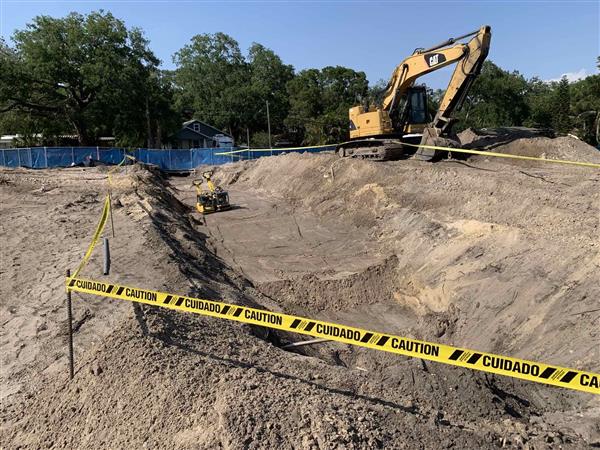

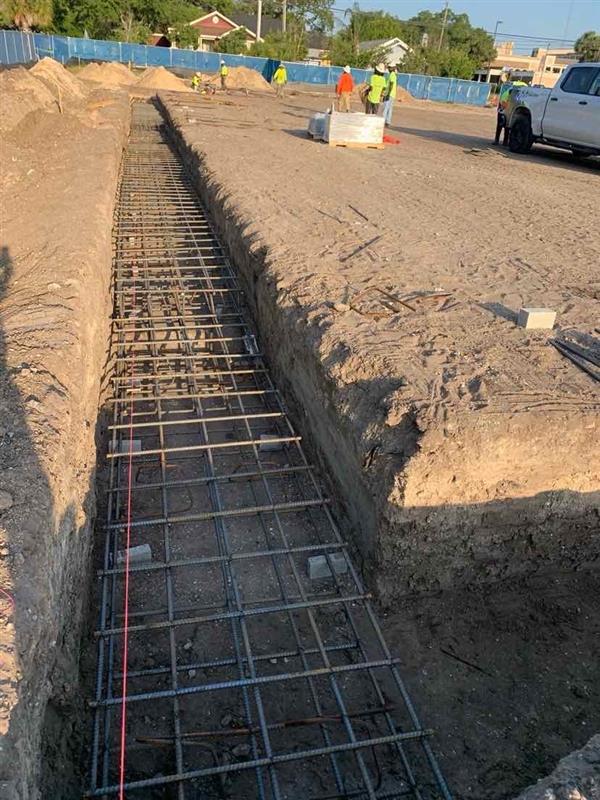

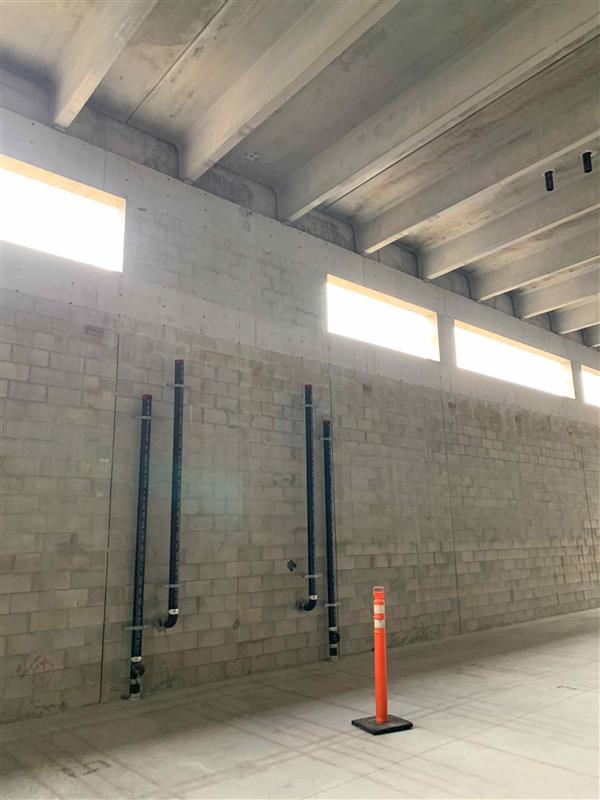

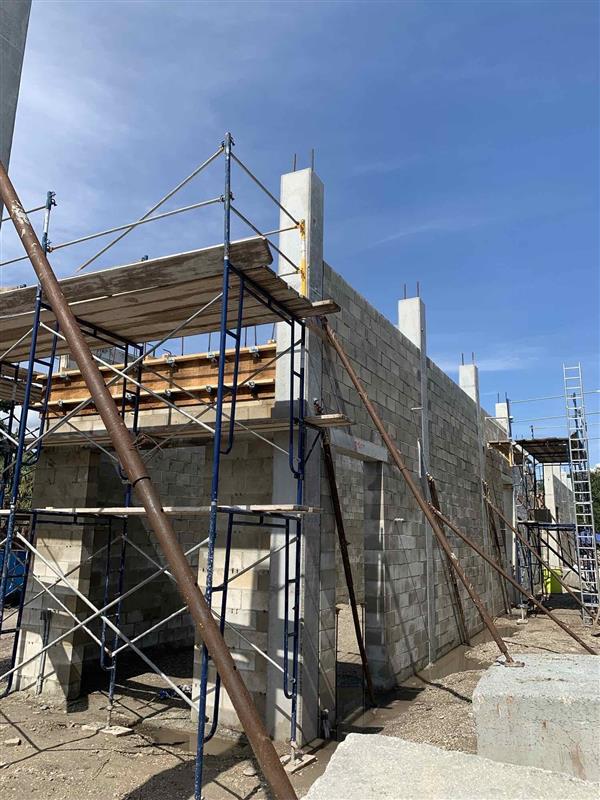

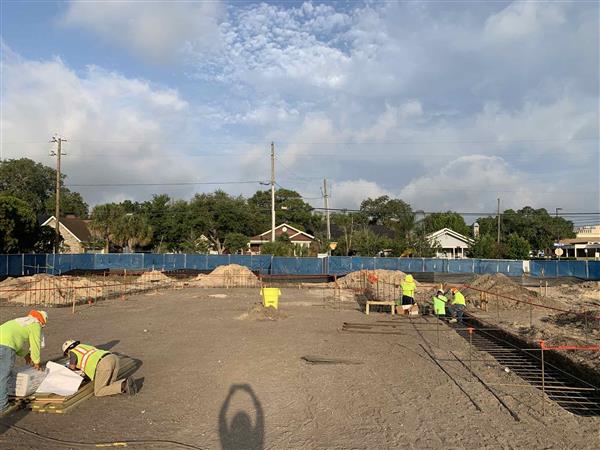

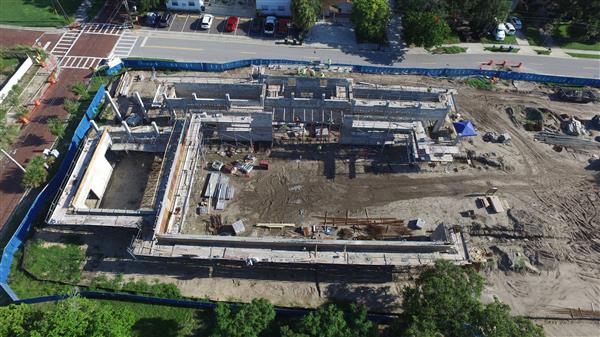

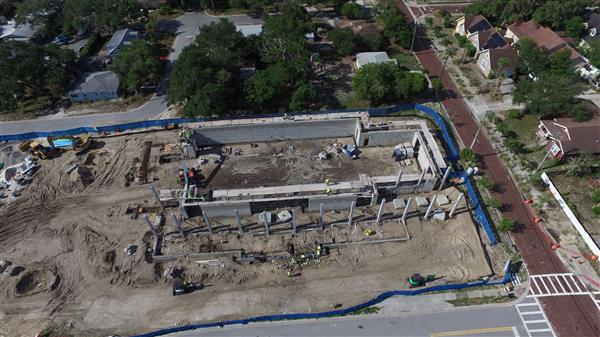

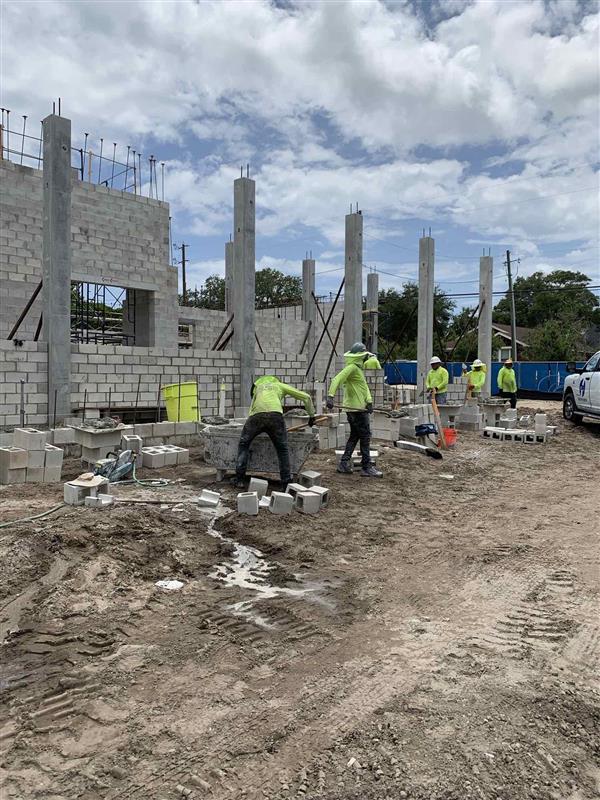

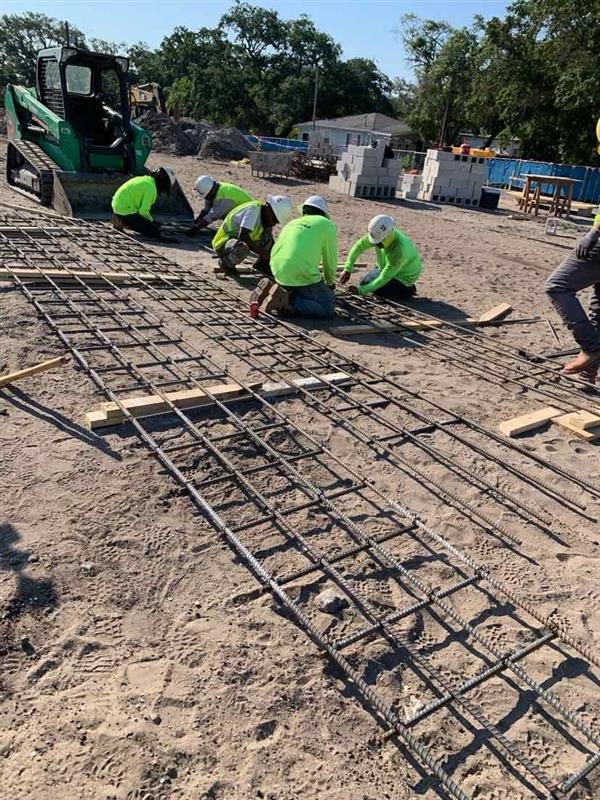

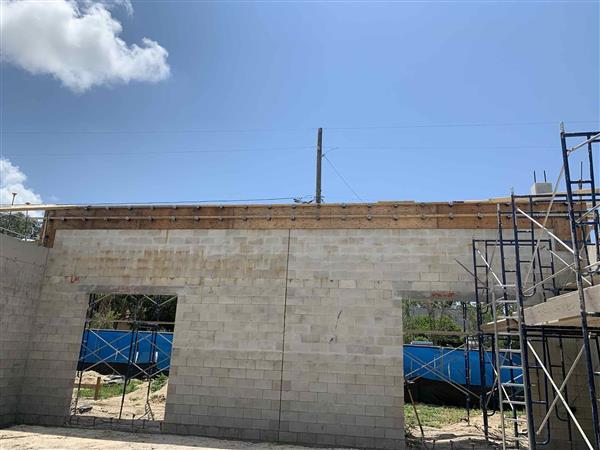

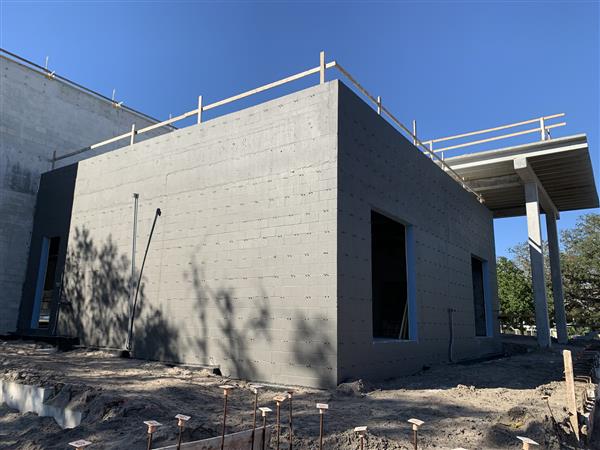

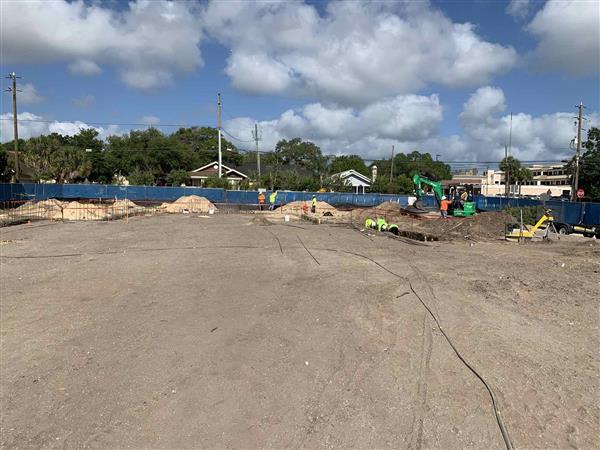

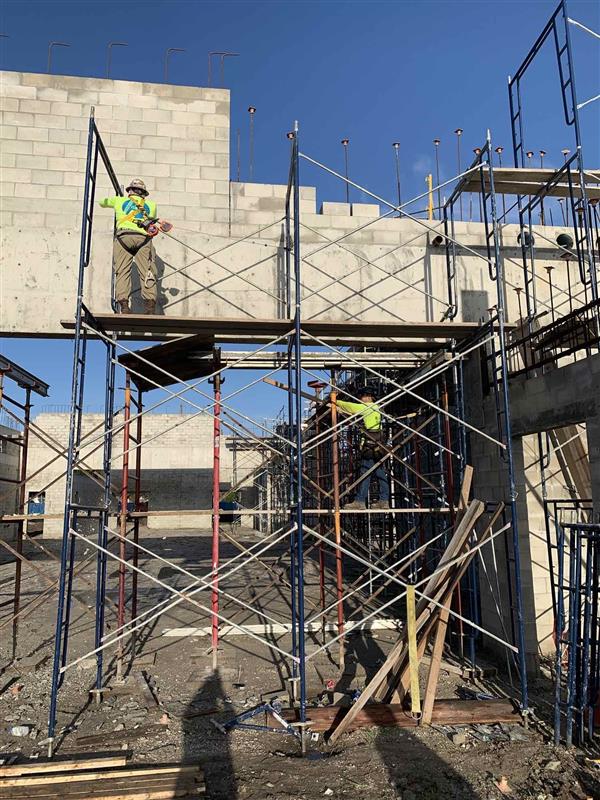

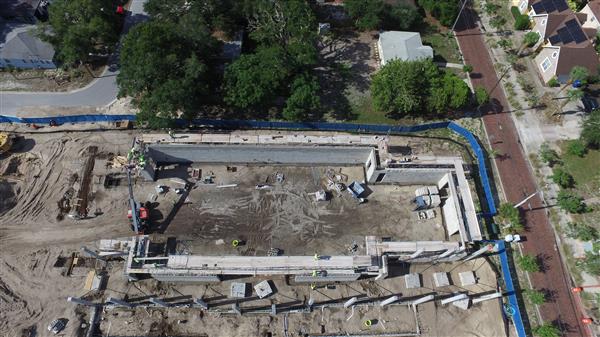

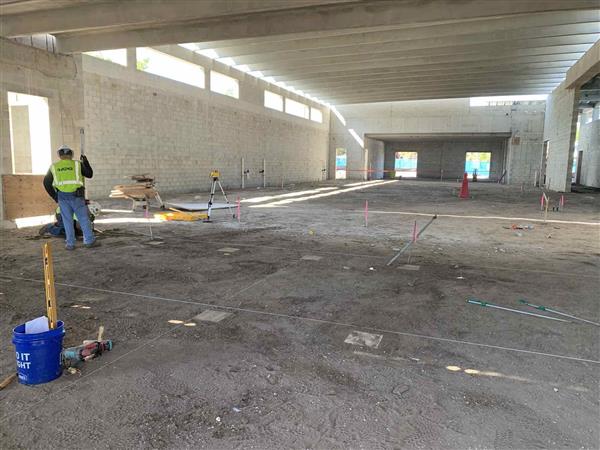

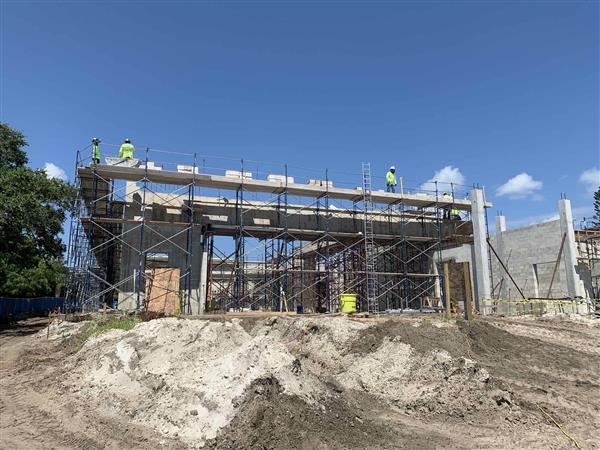

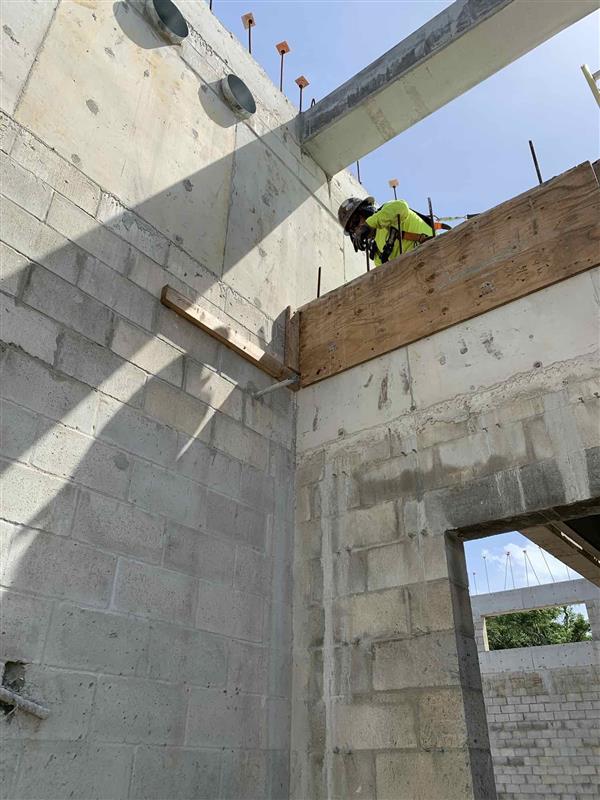

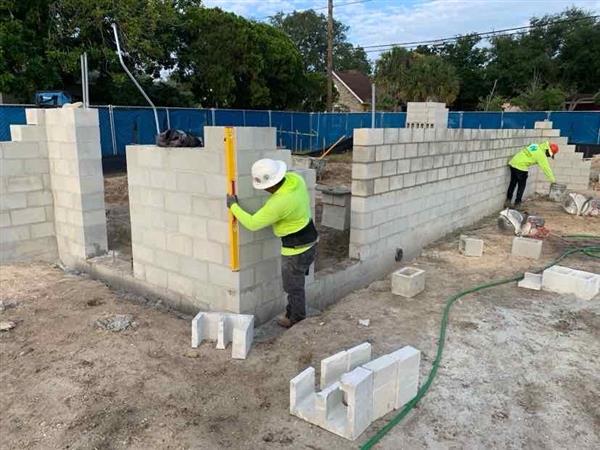

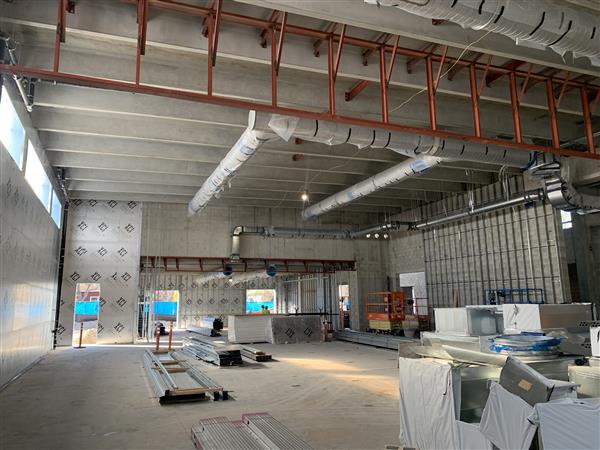

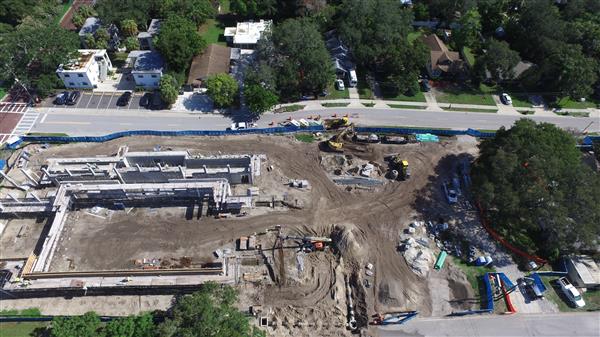

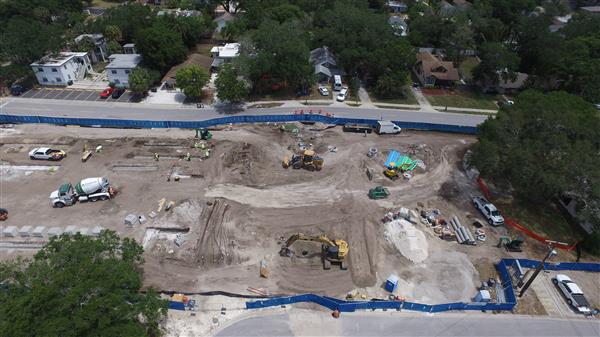

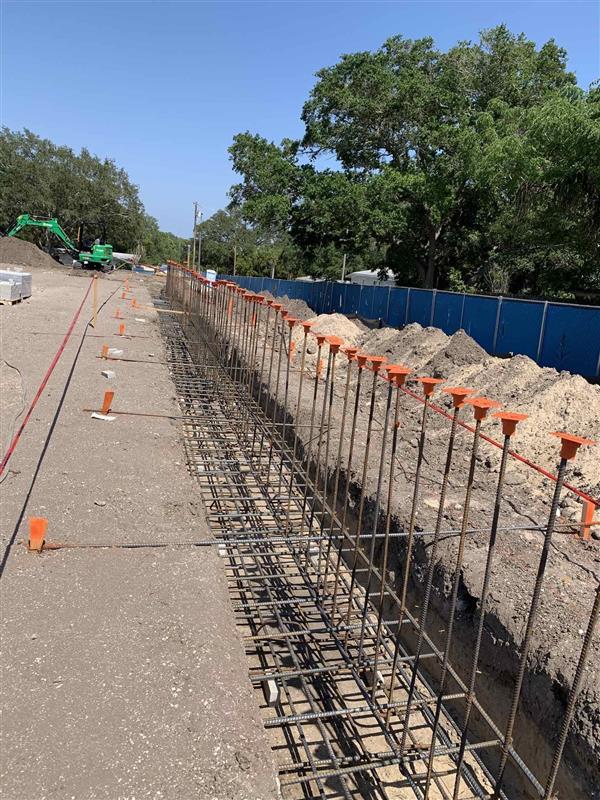

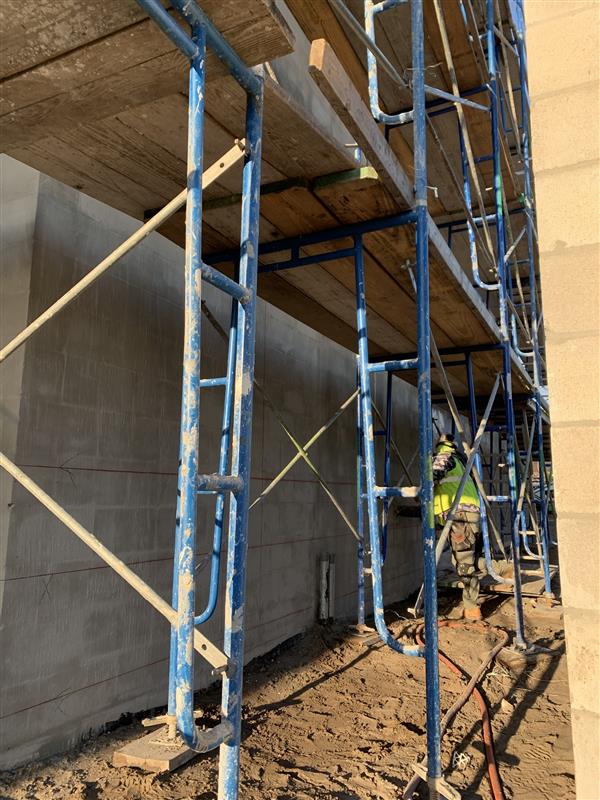

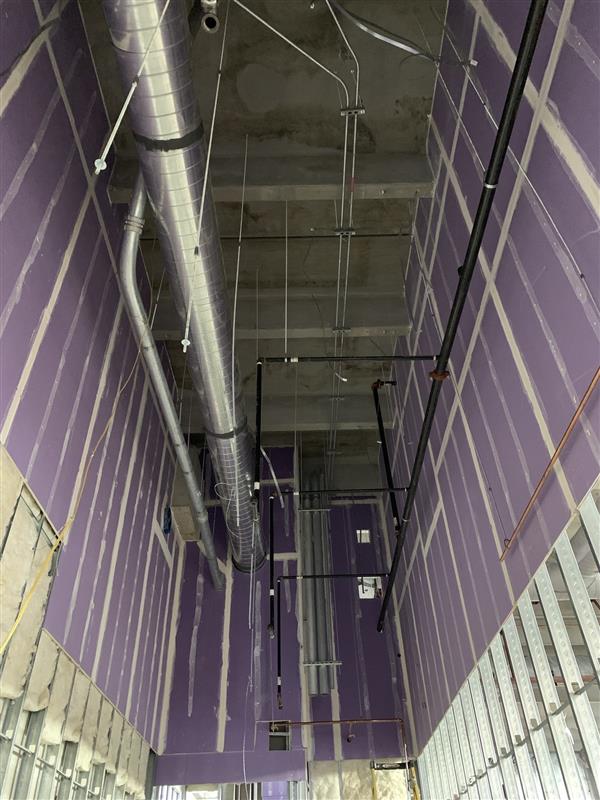

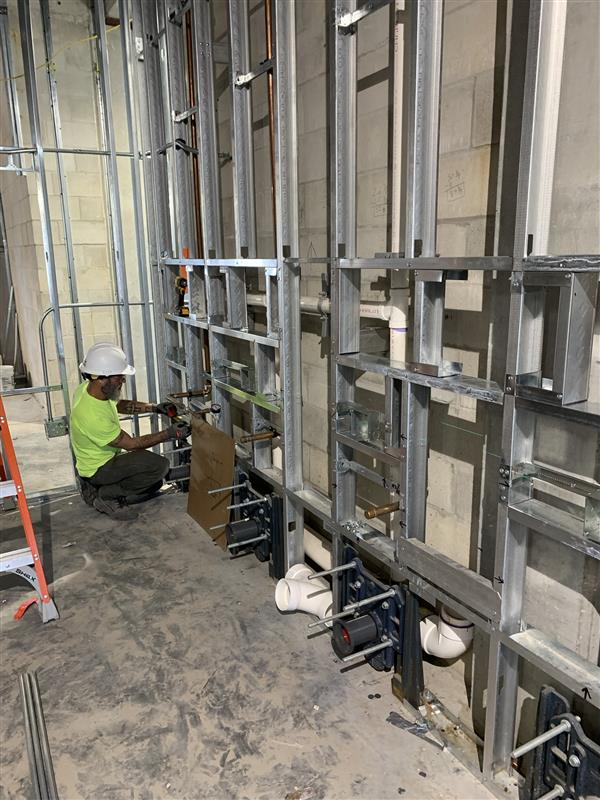

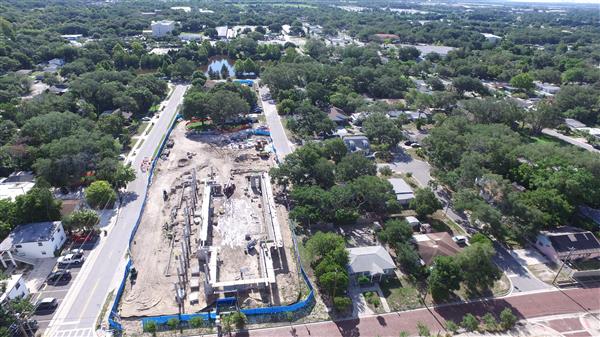

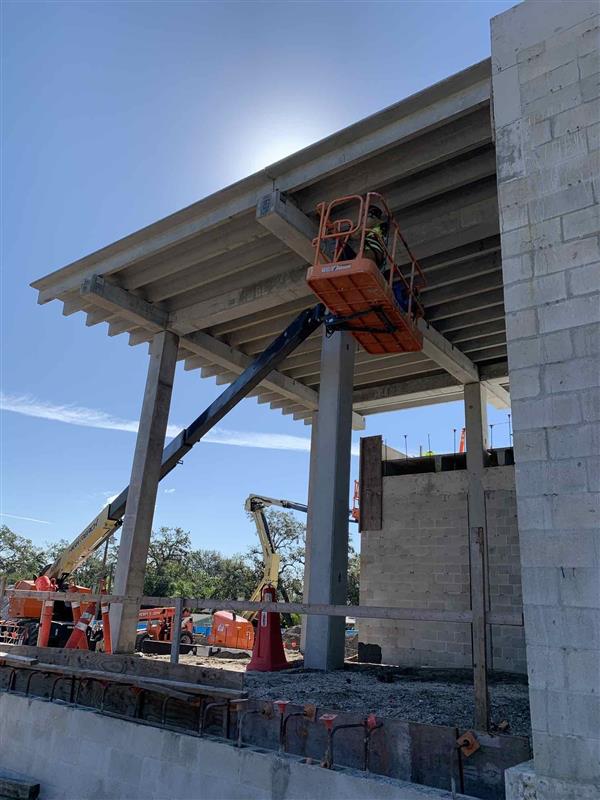

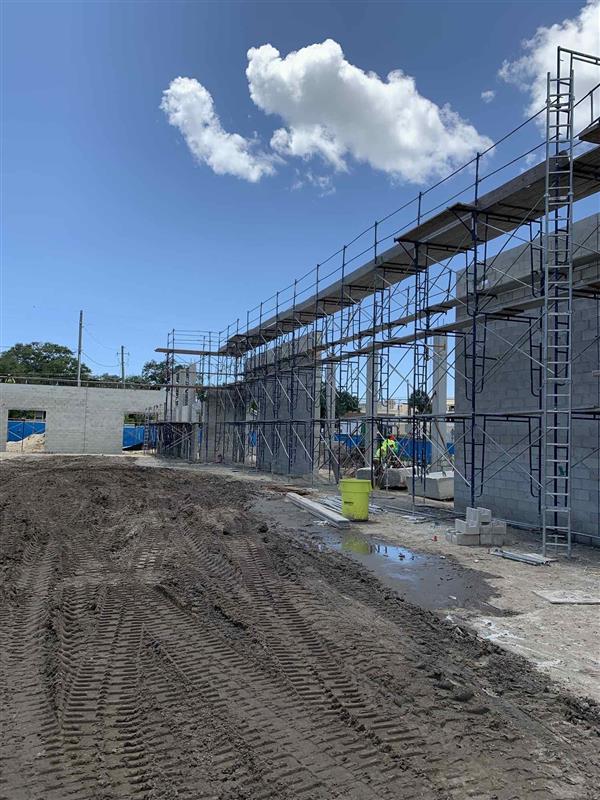

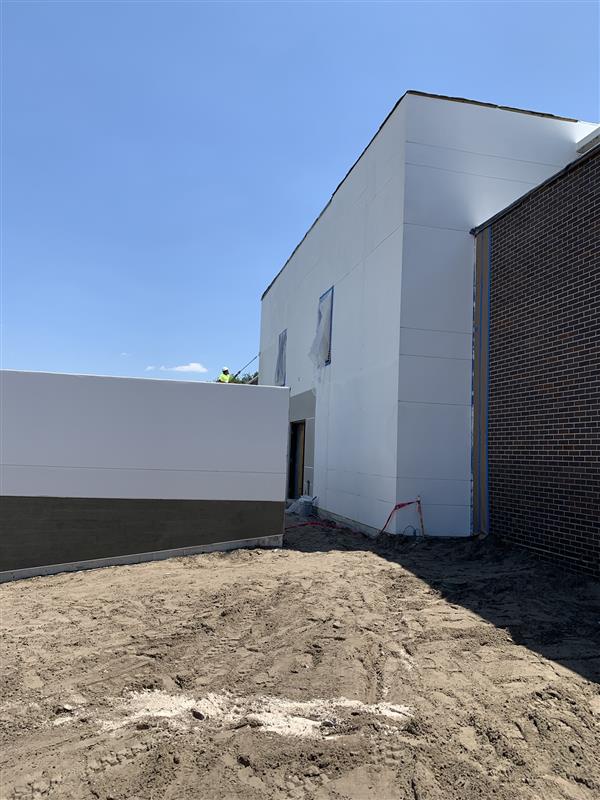

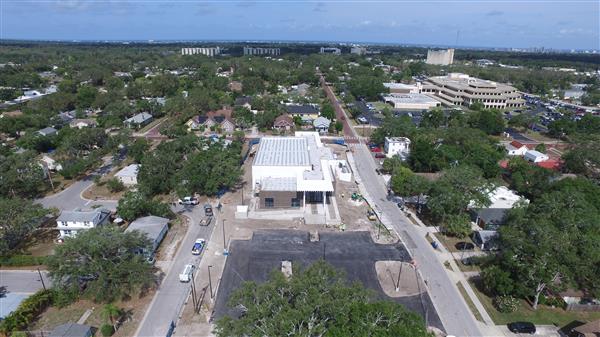

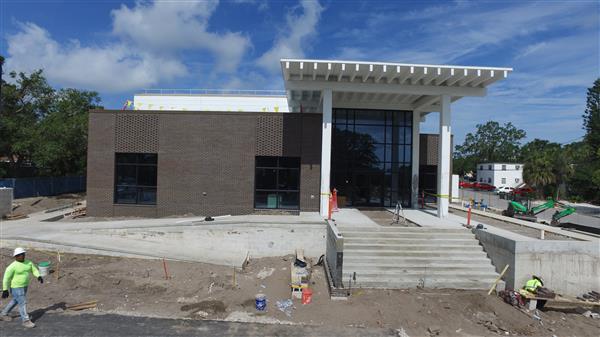

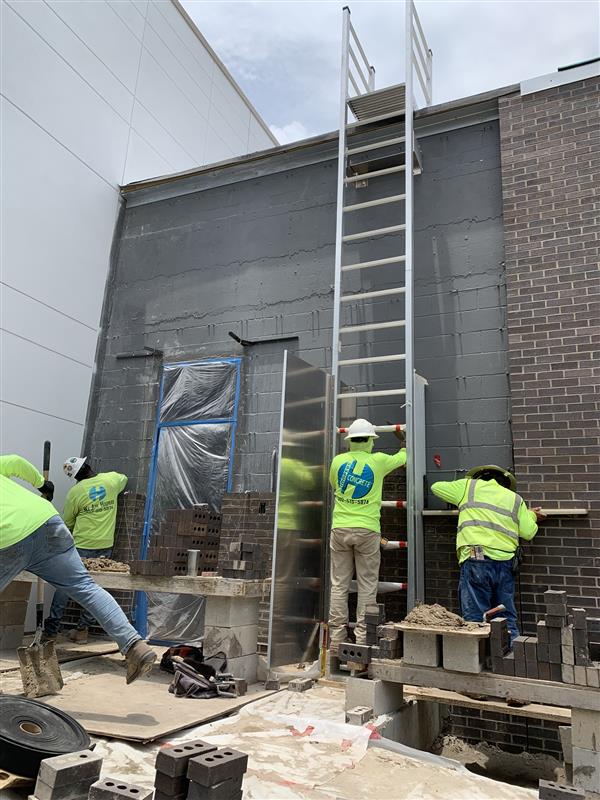

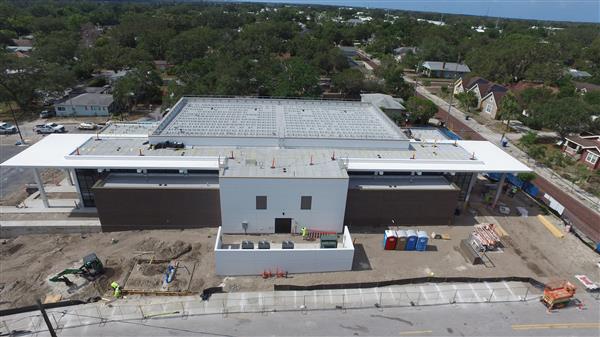

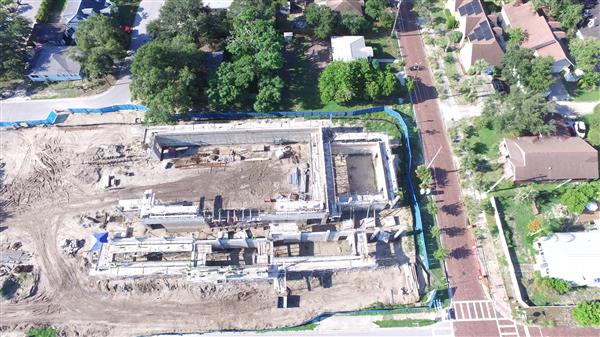

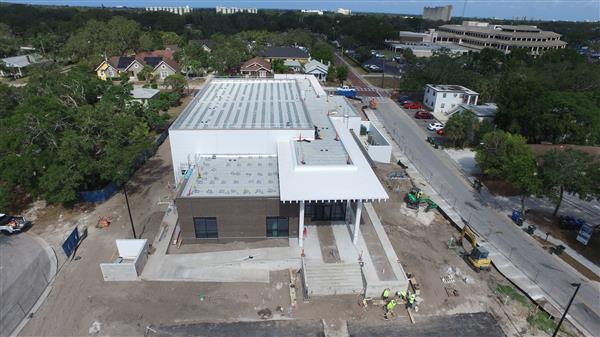

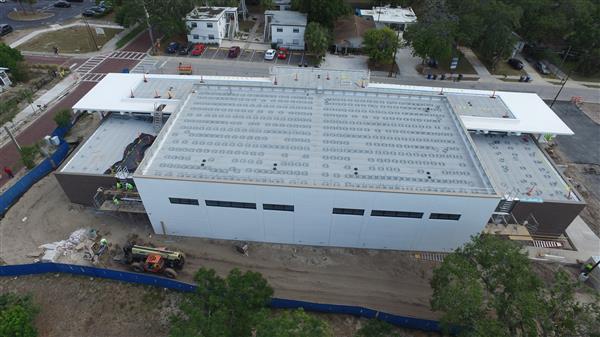

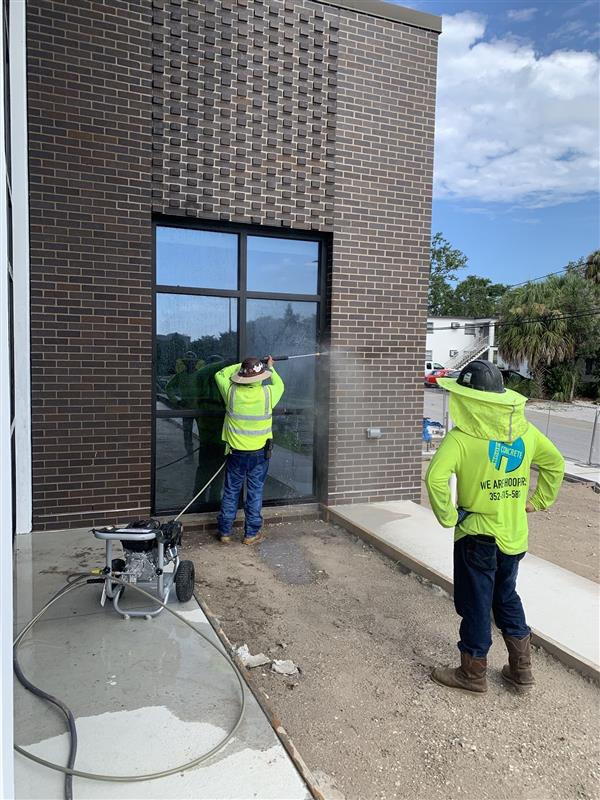

Project Status:

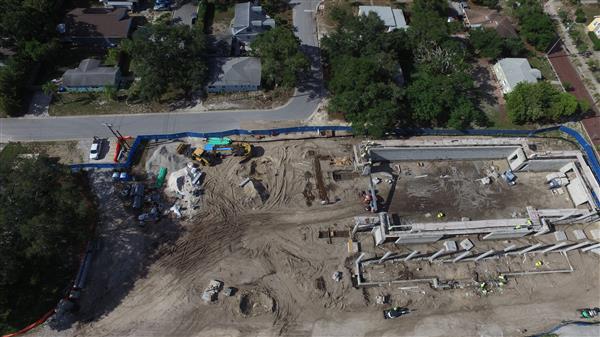

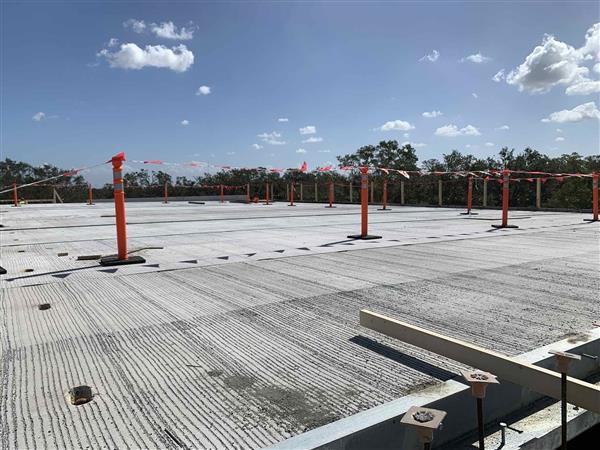

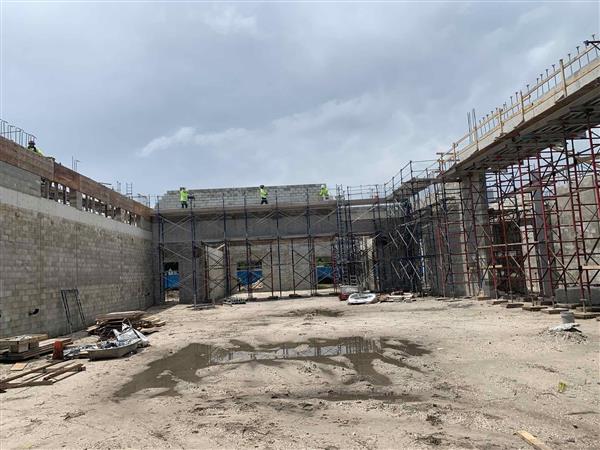

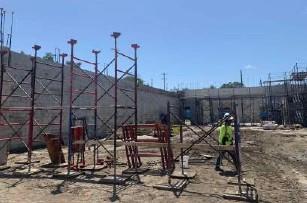

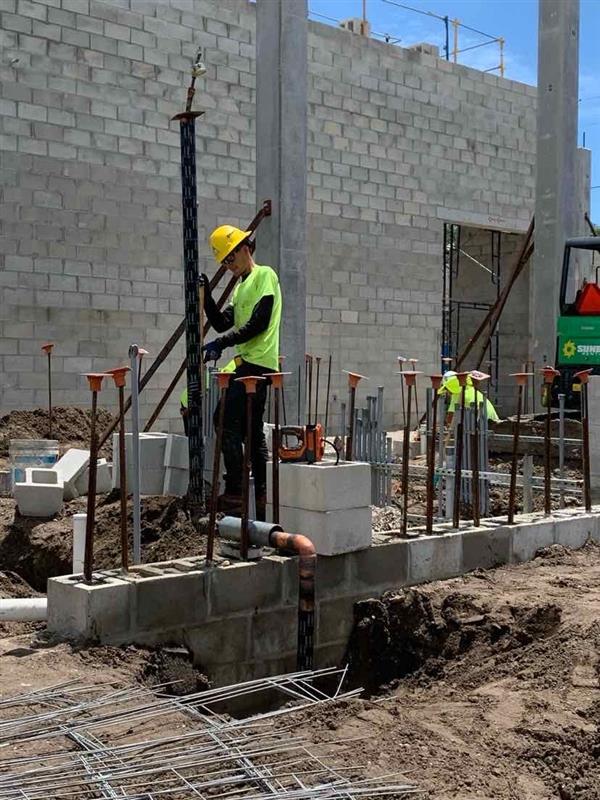

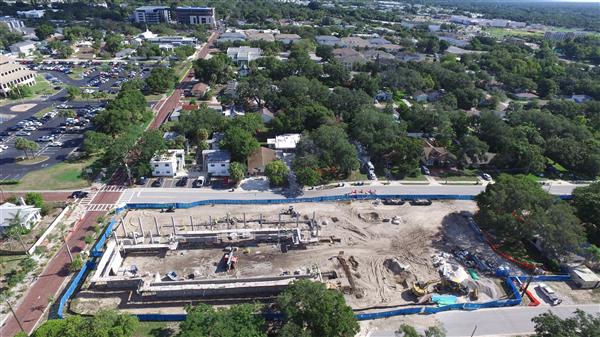

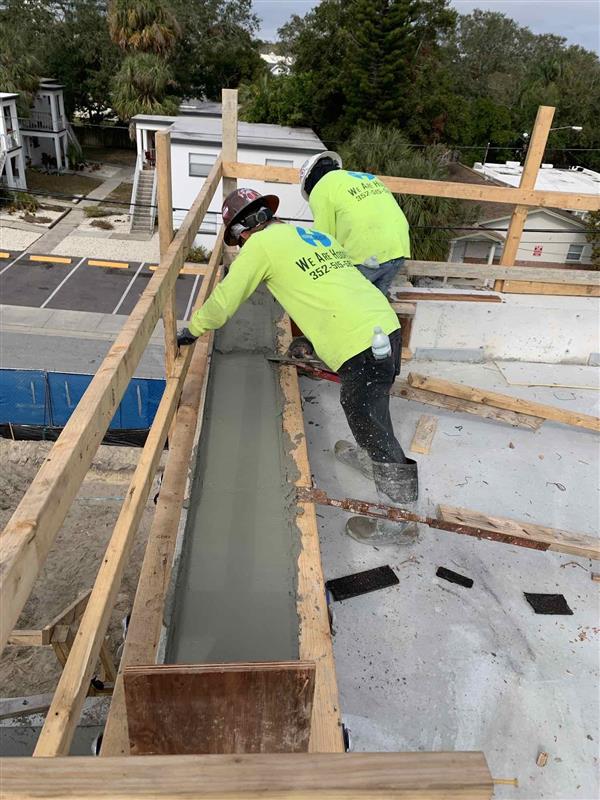

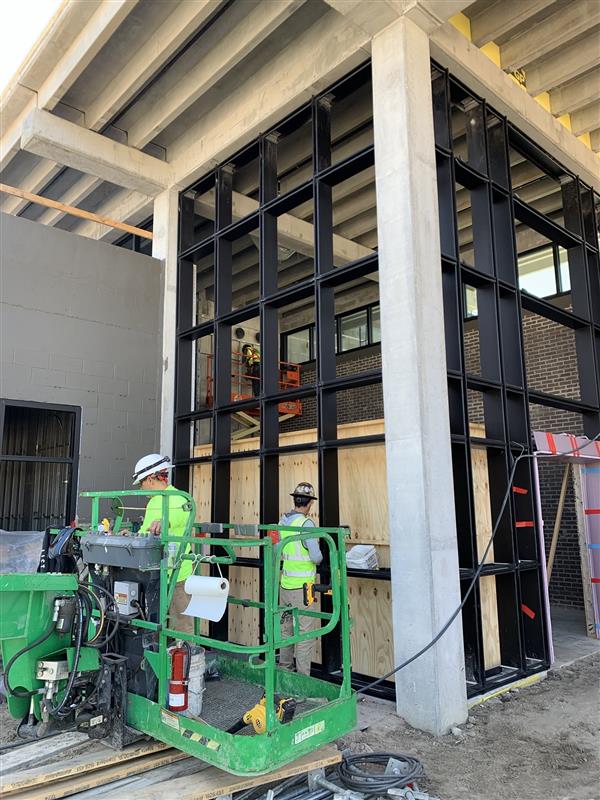

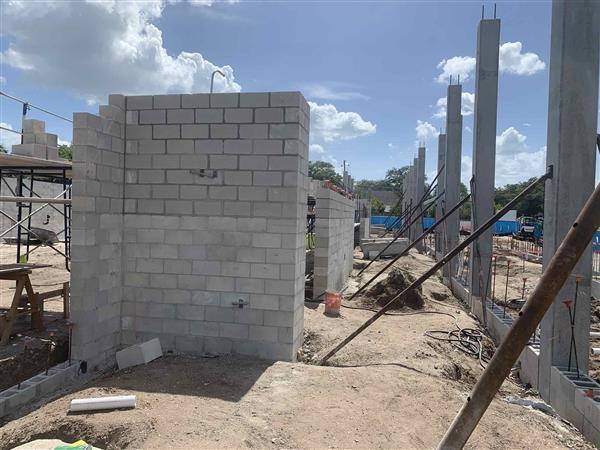

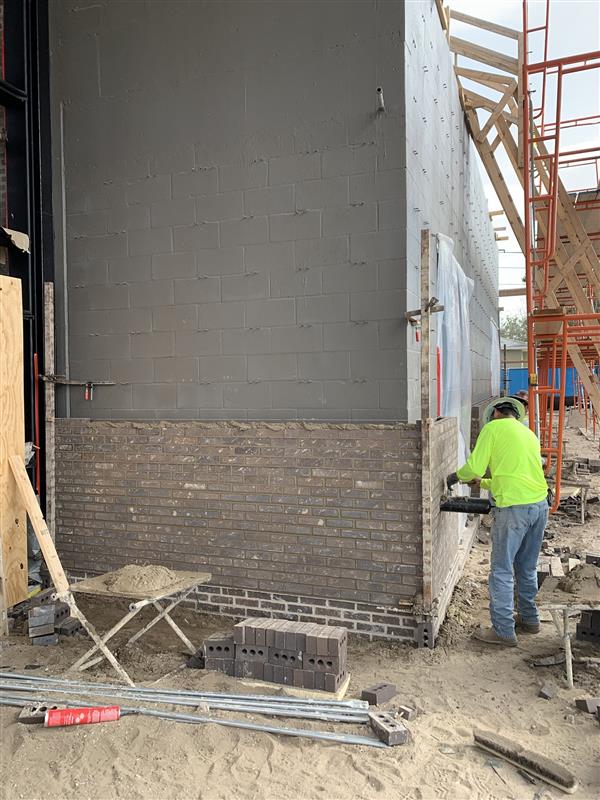

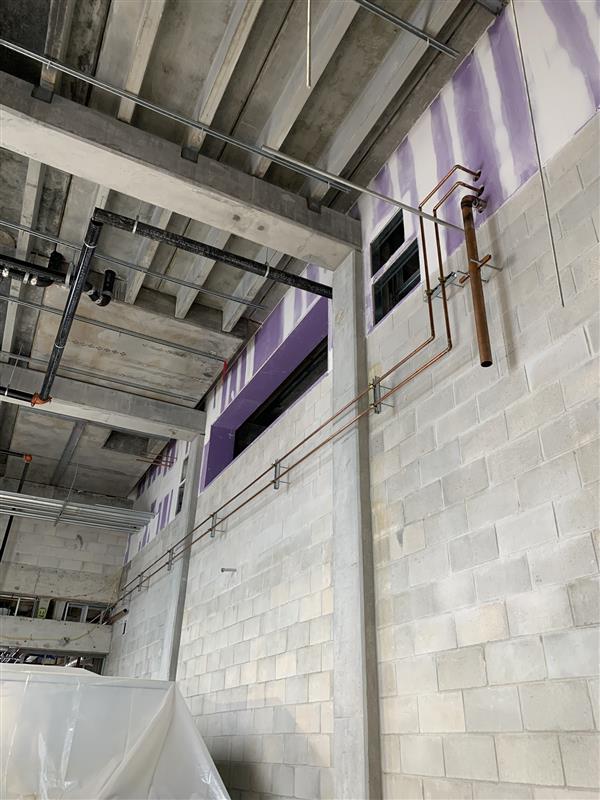

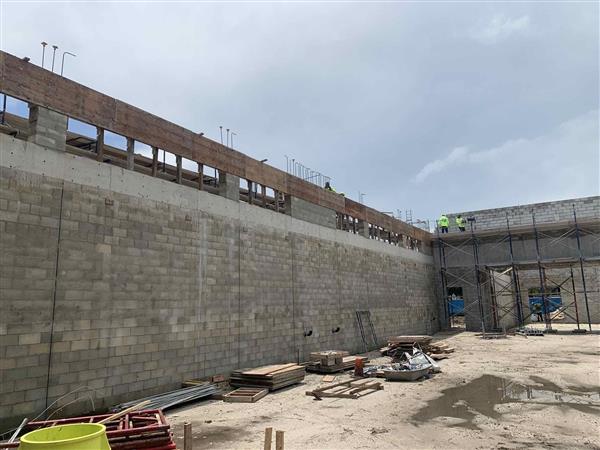

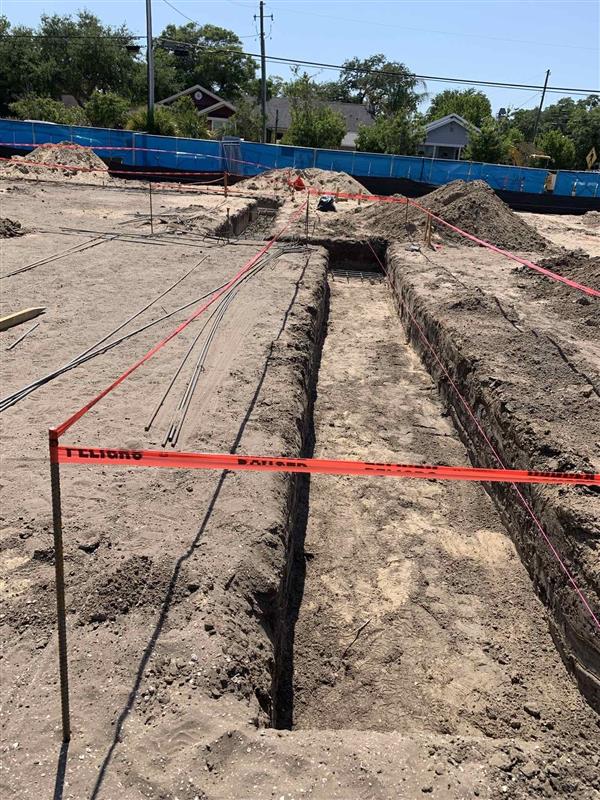

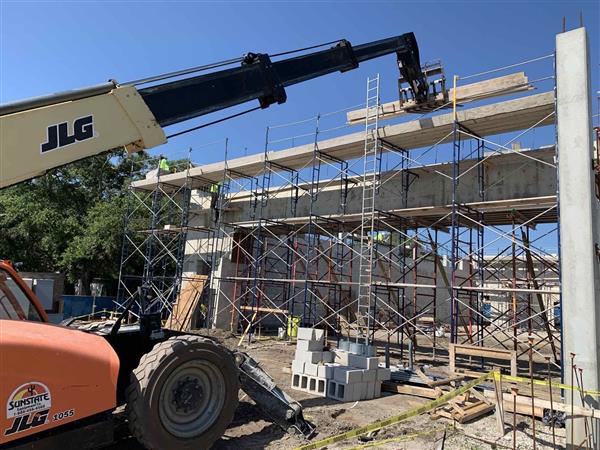

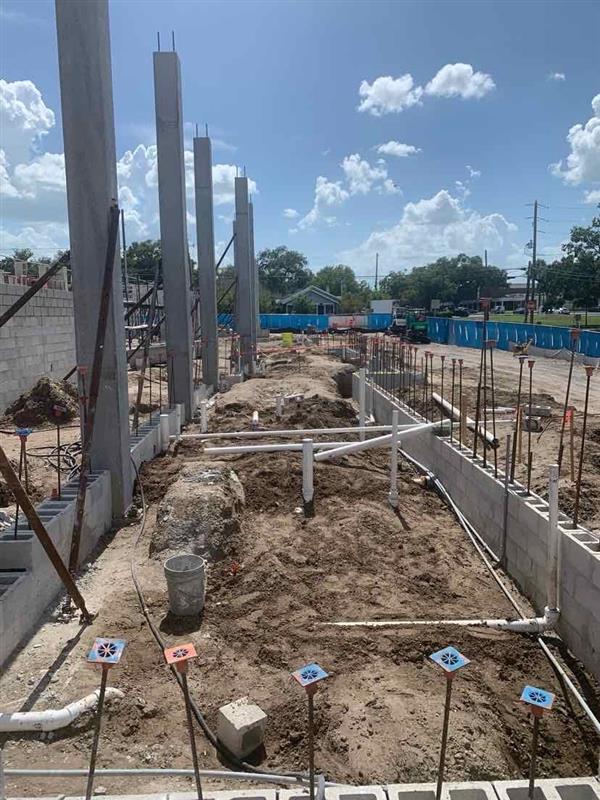

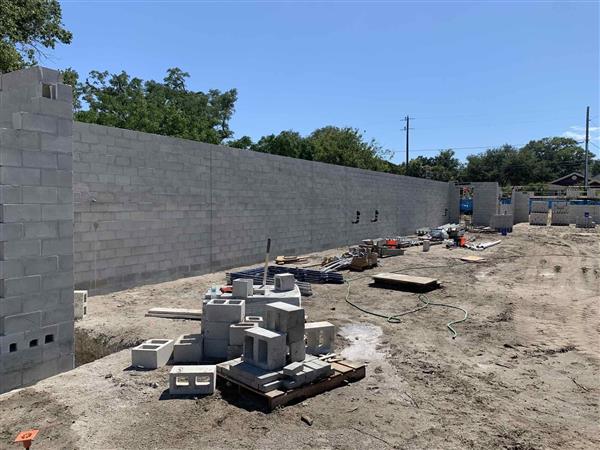

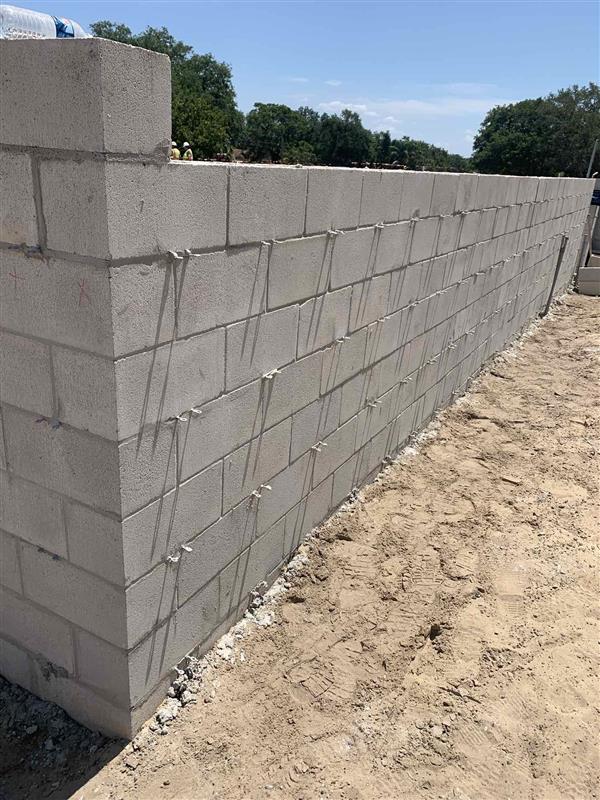

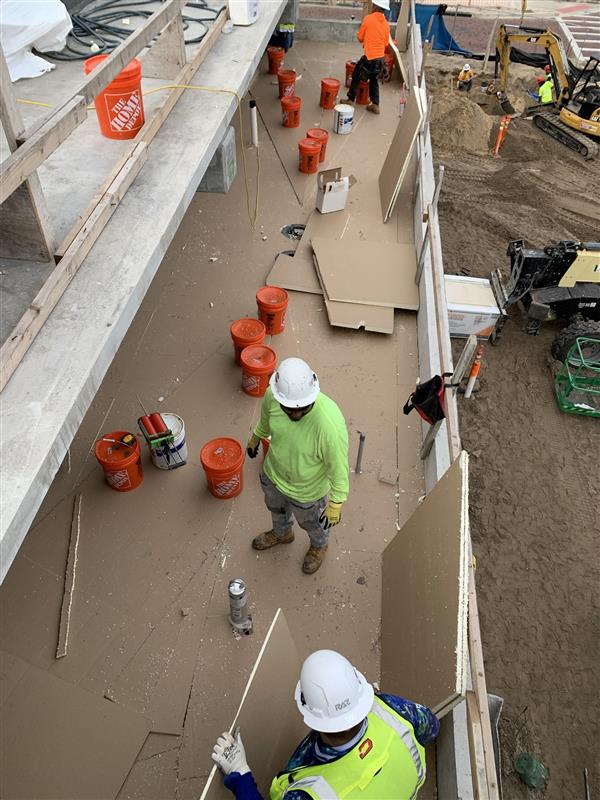

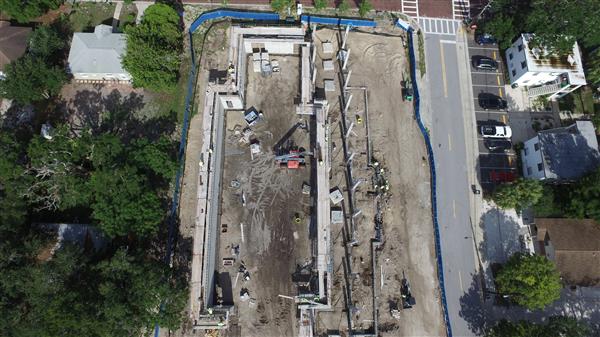

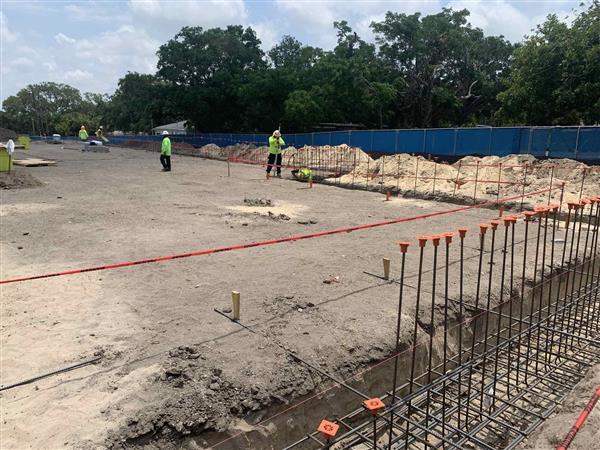

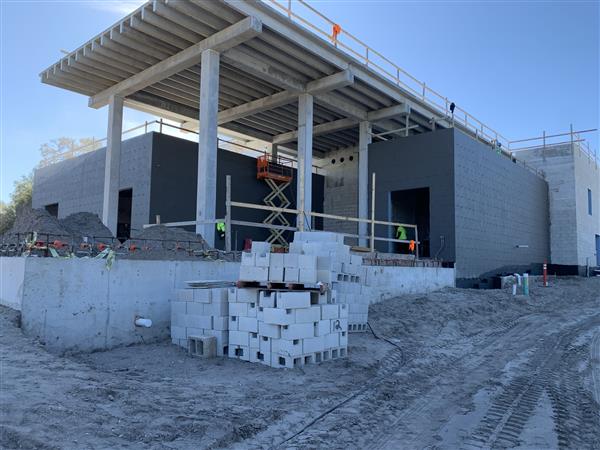

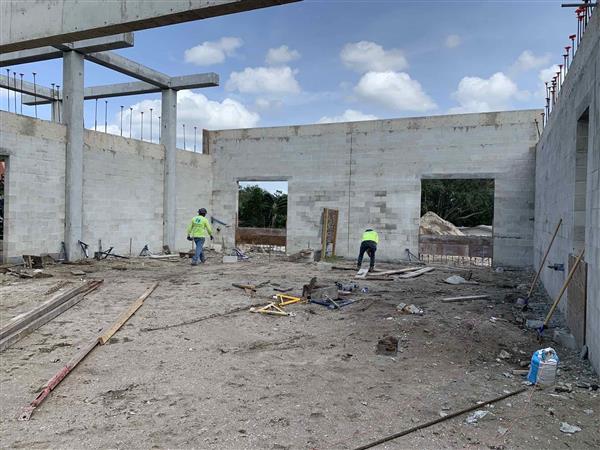

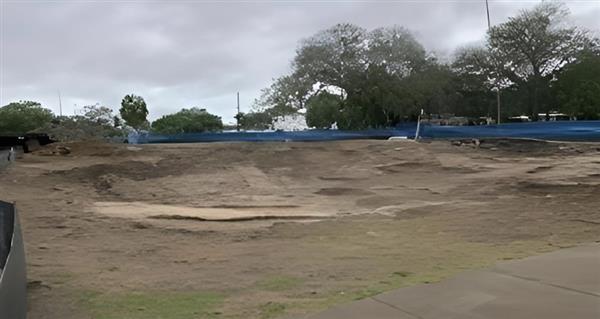

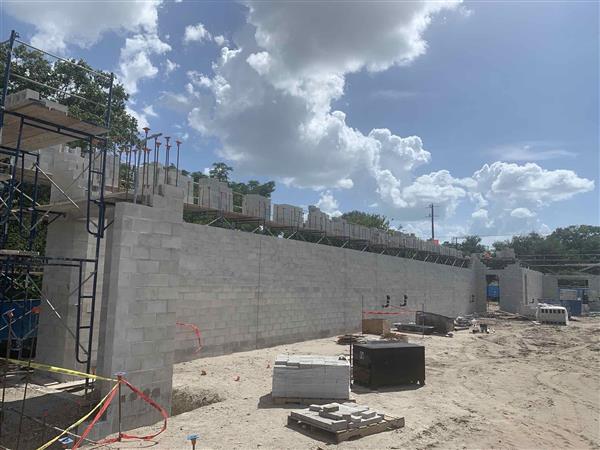

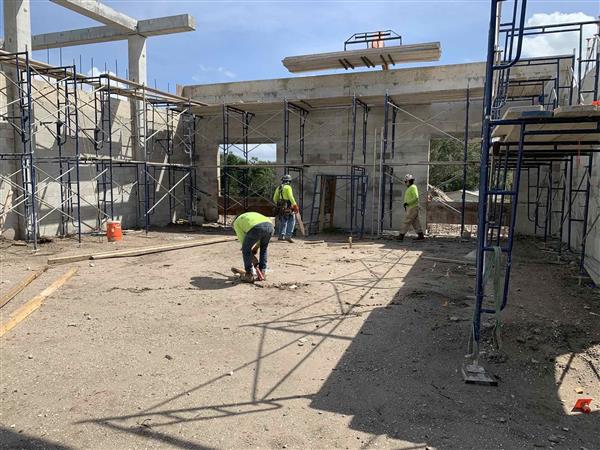

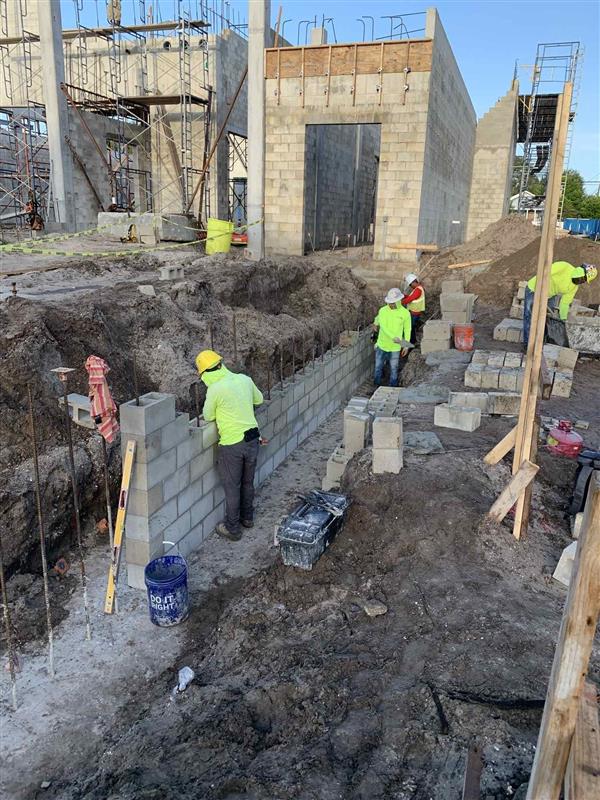

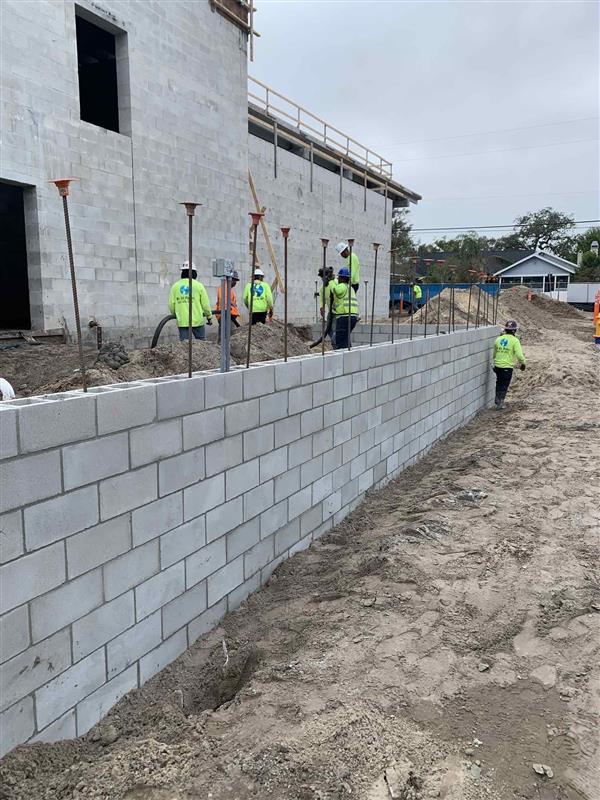

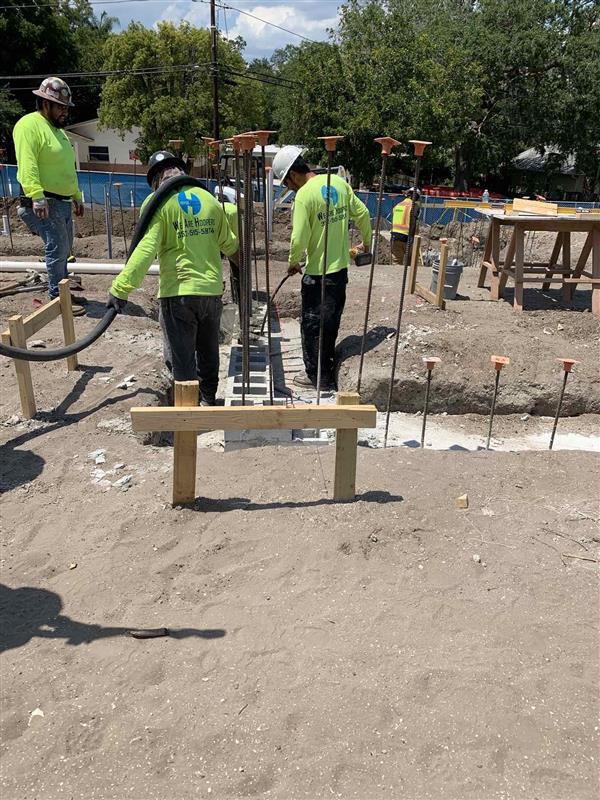

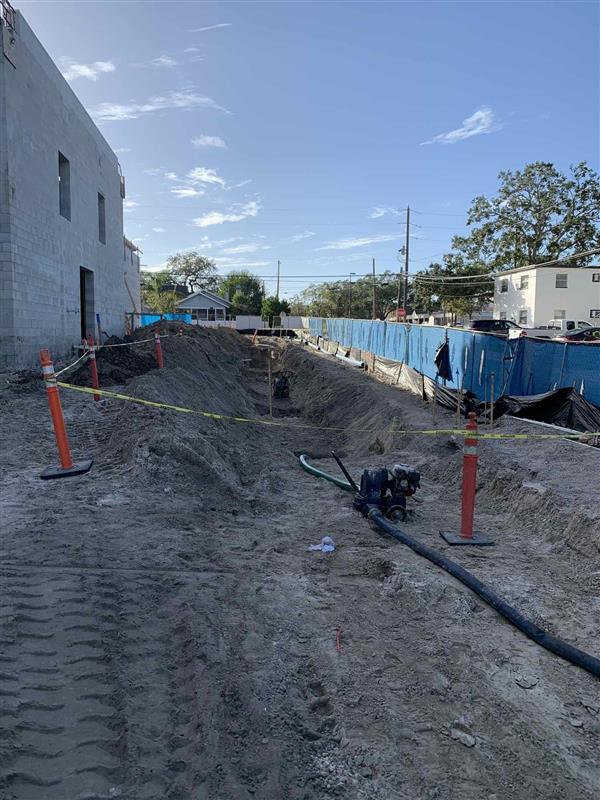

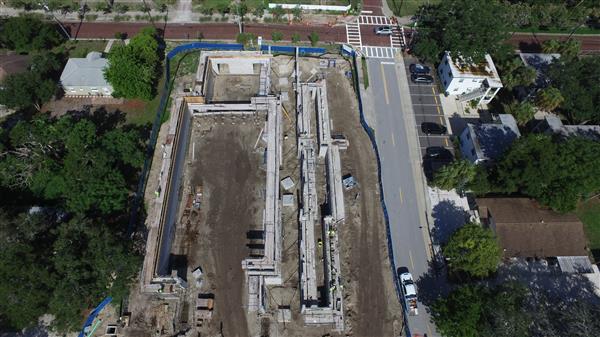

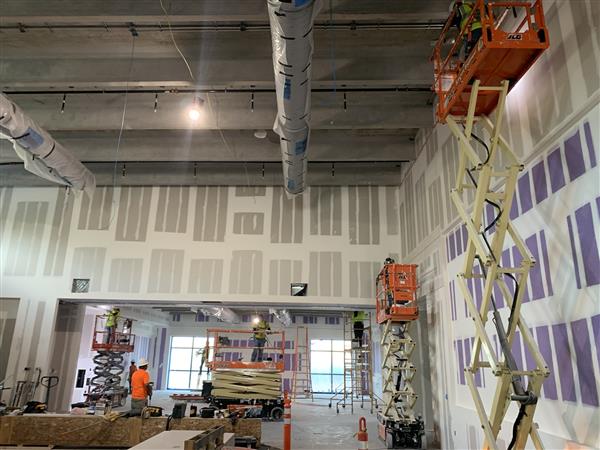

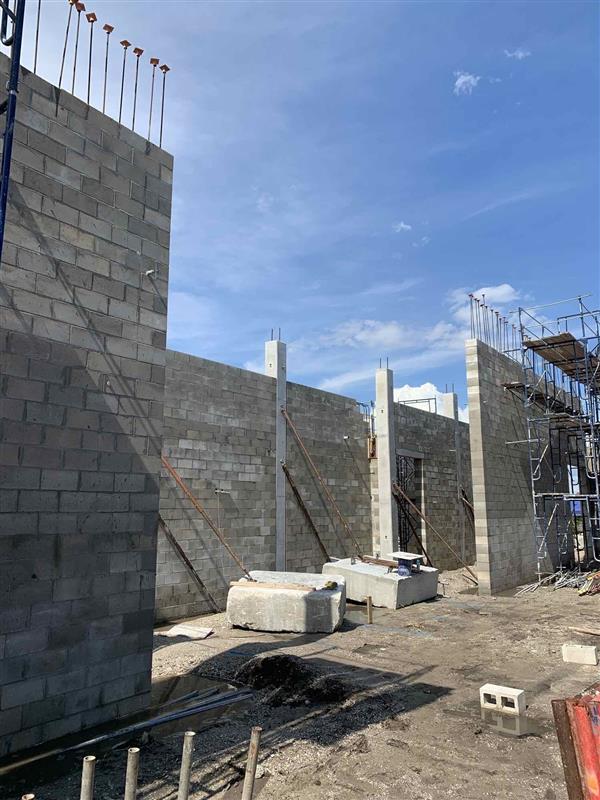

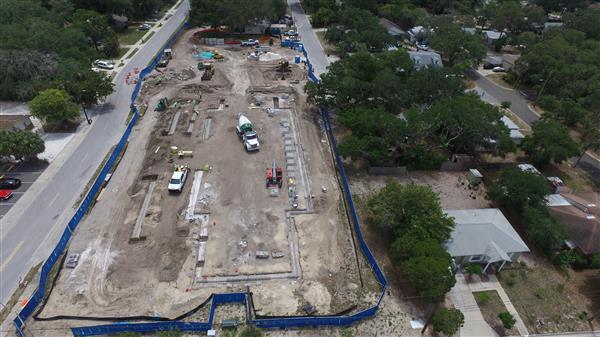

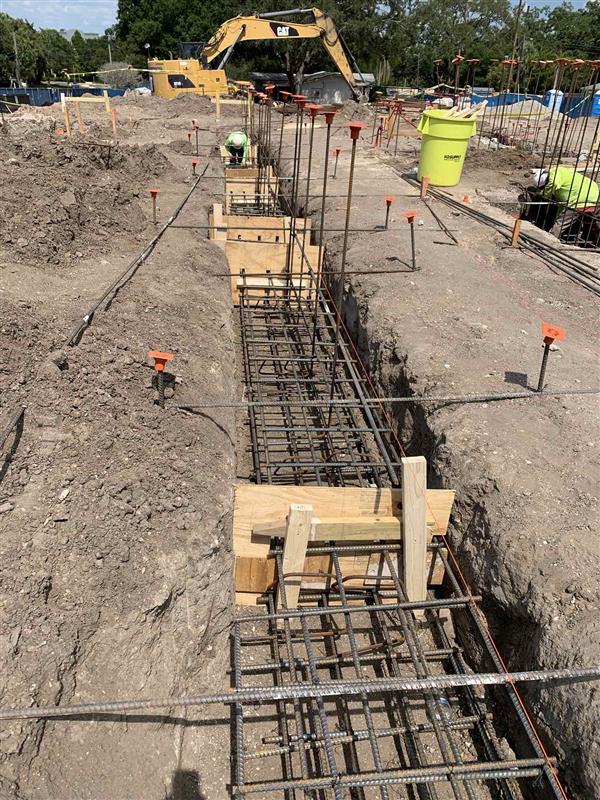

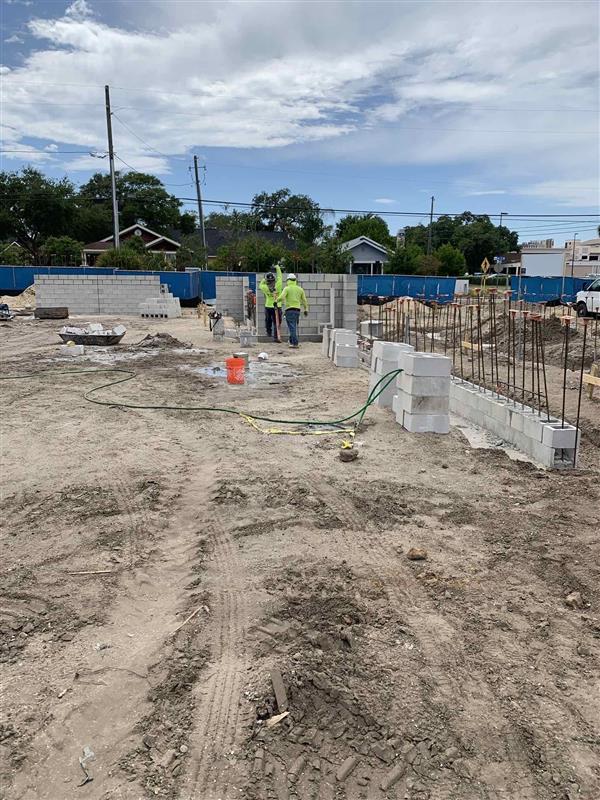

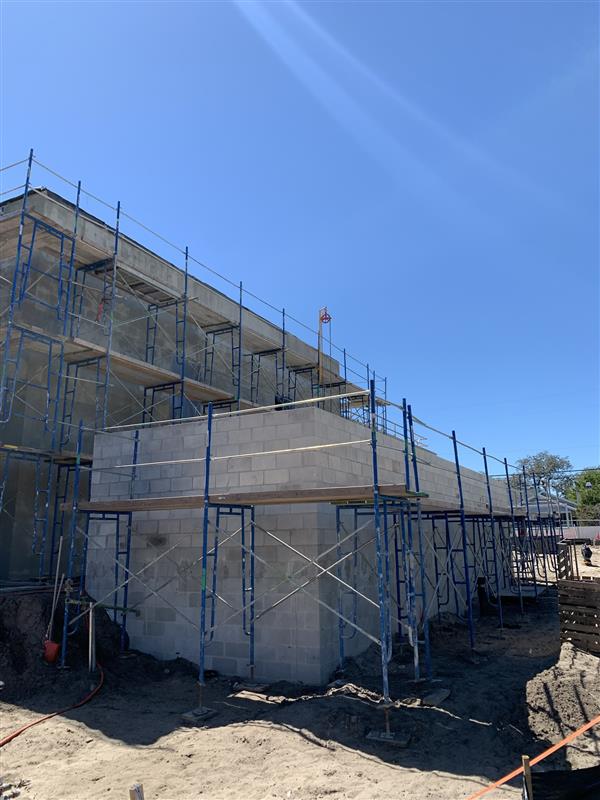

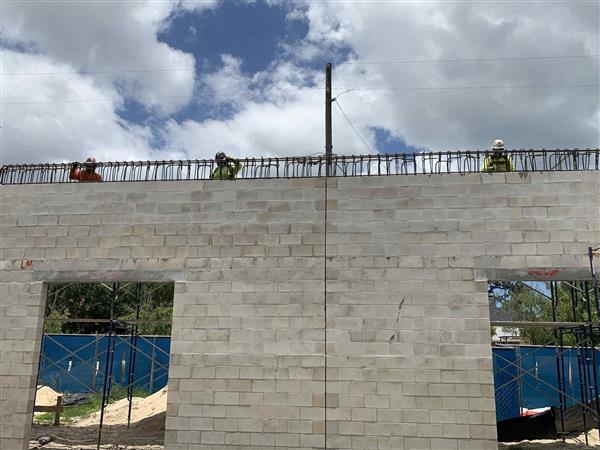

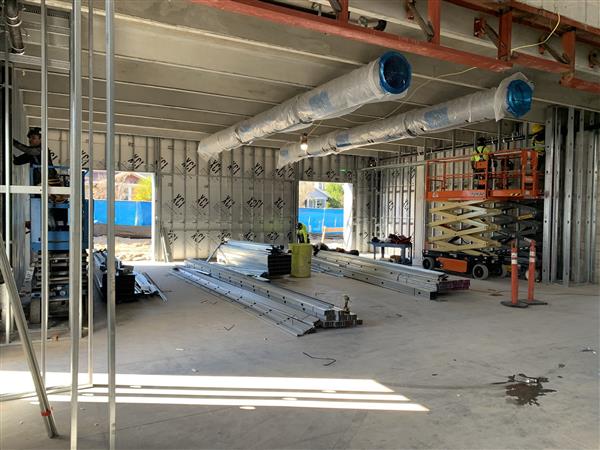

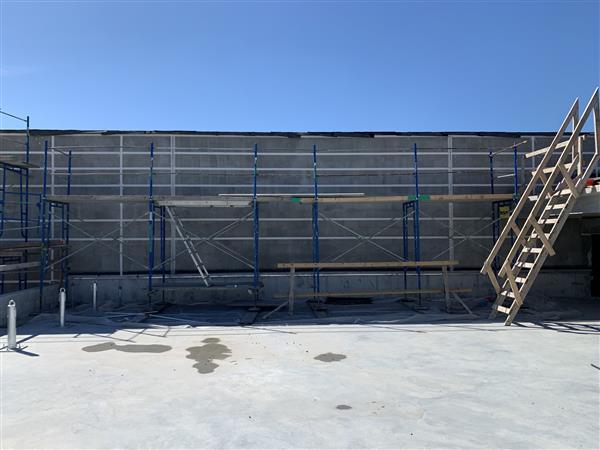

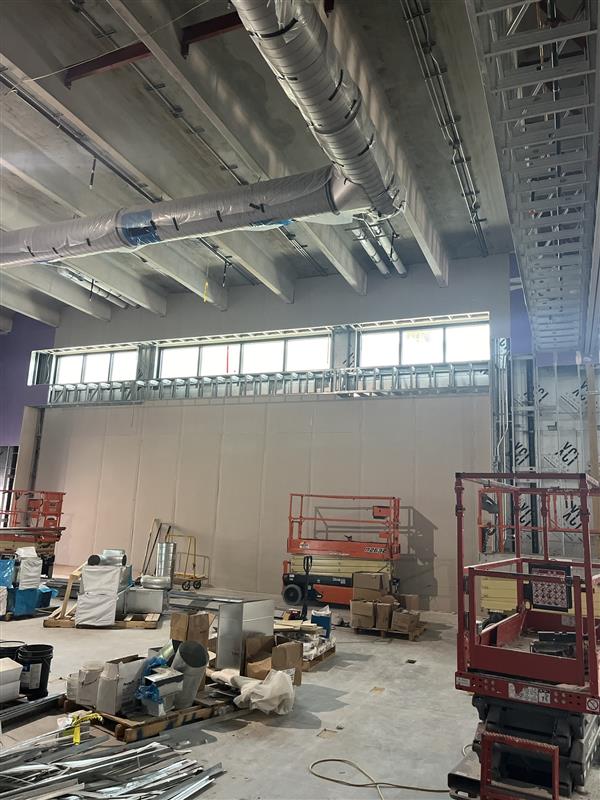

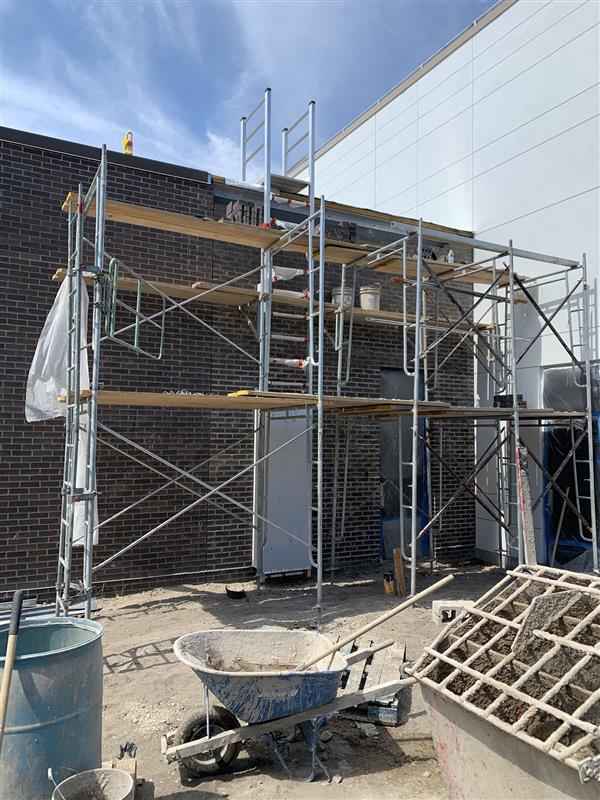

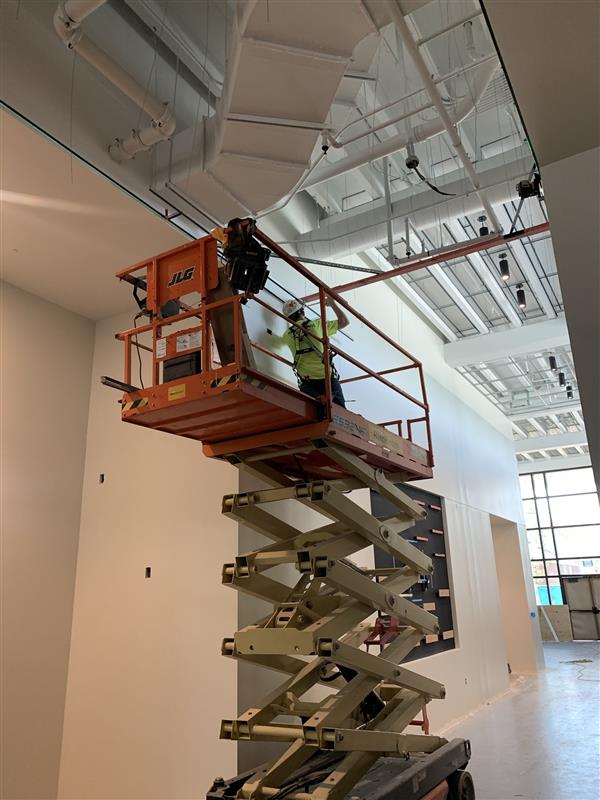

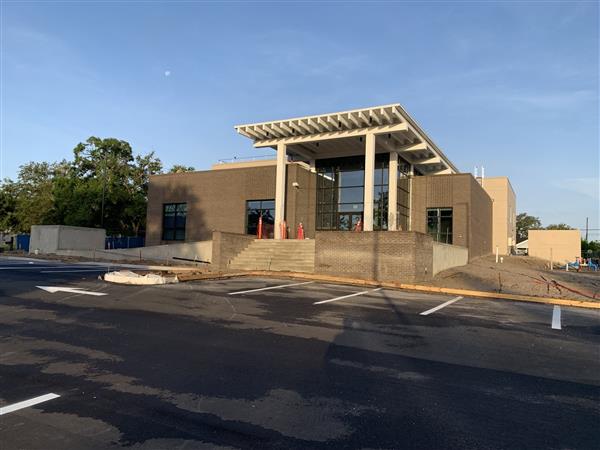

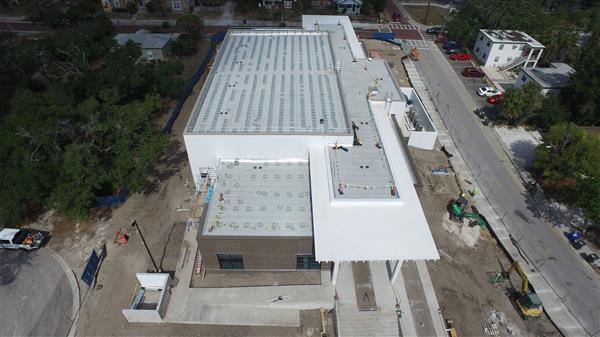

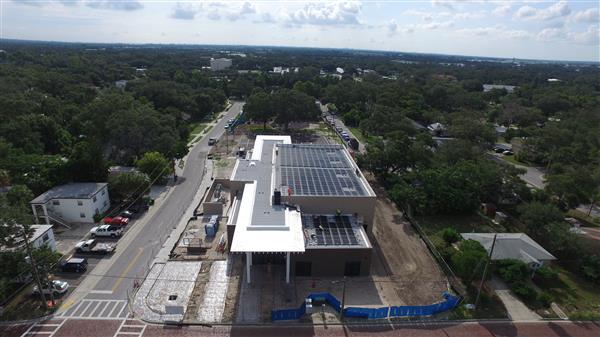

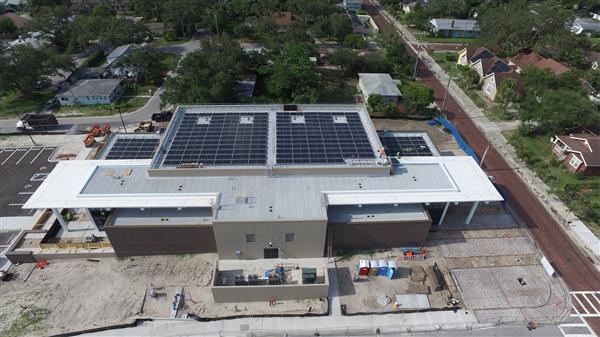

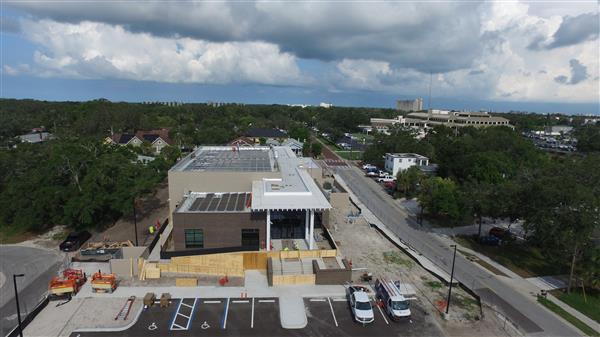

Week of 5/16/25

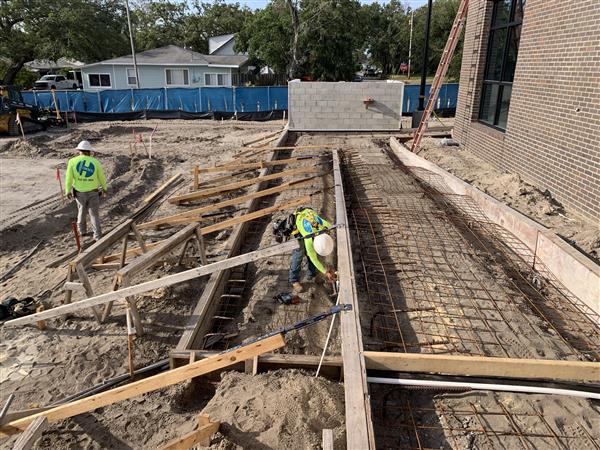

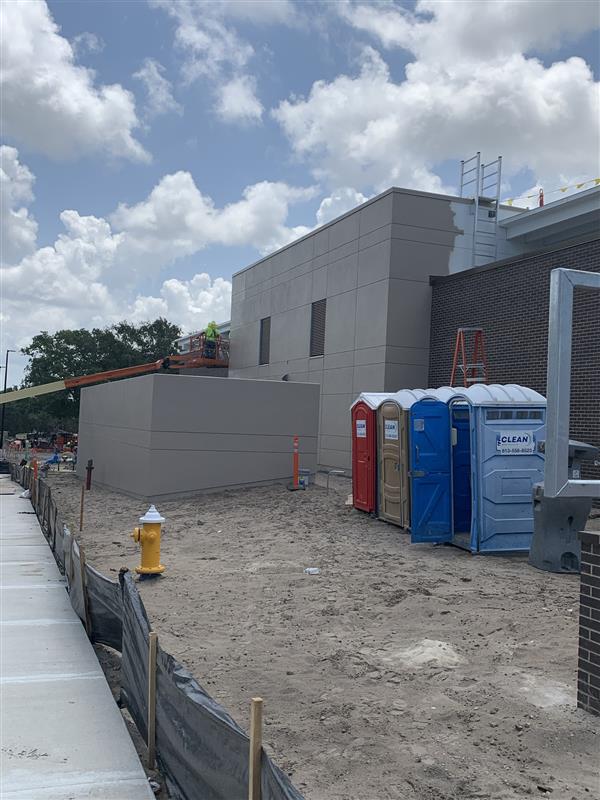

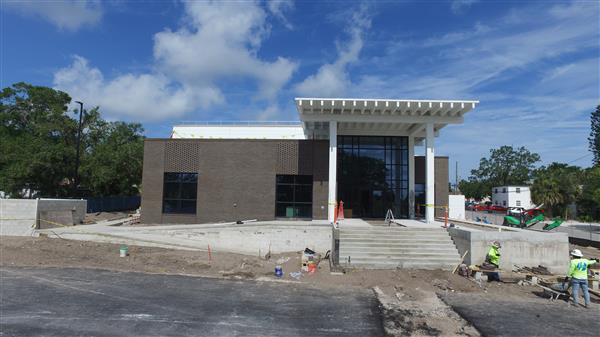

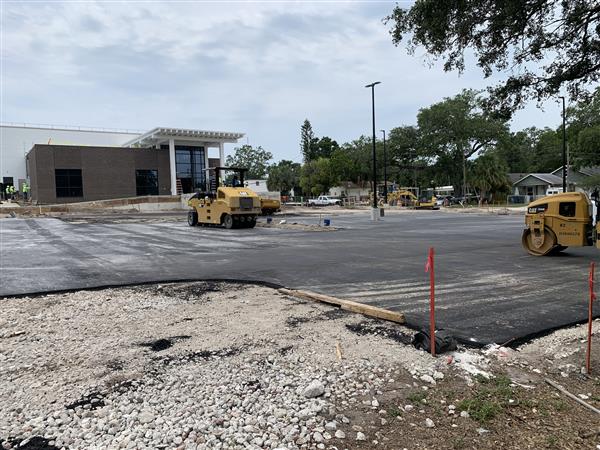

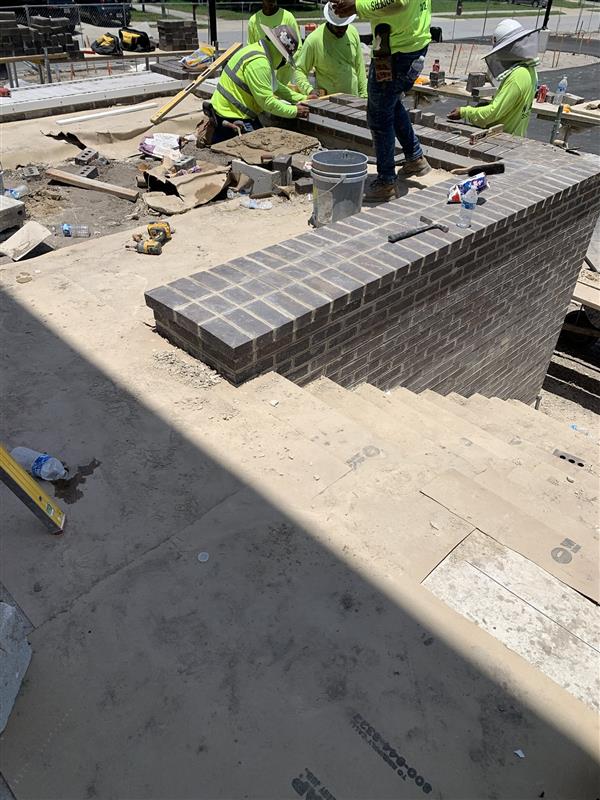

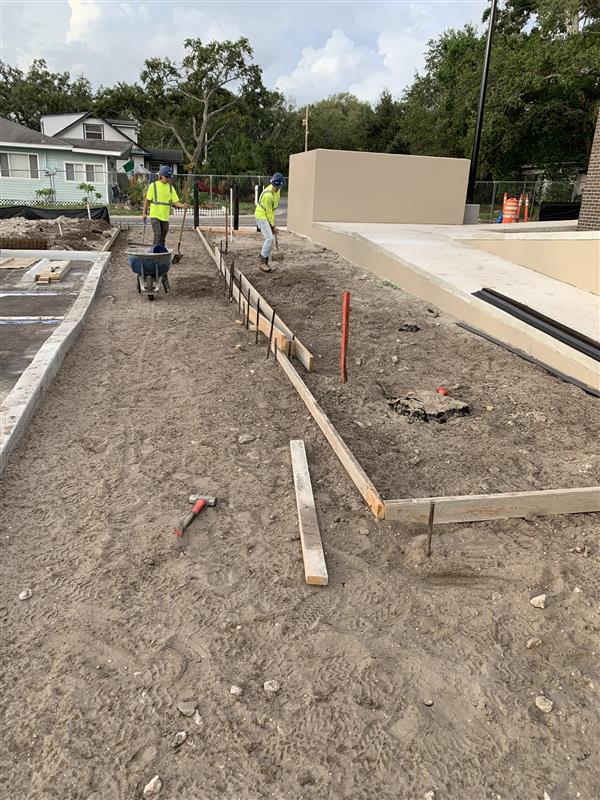

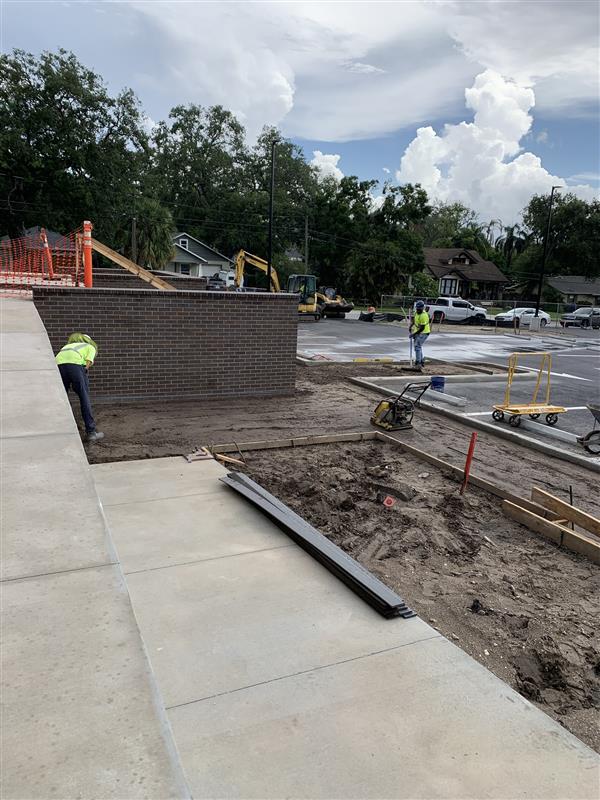

- Continuing grading and adding sub-base for parking lot, fire hydrant flush test, grade and form sidewalks, pour off-site sidewalk and paint DCDA

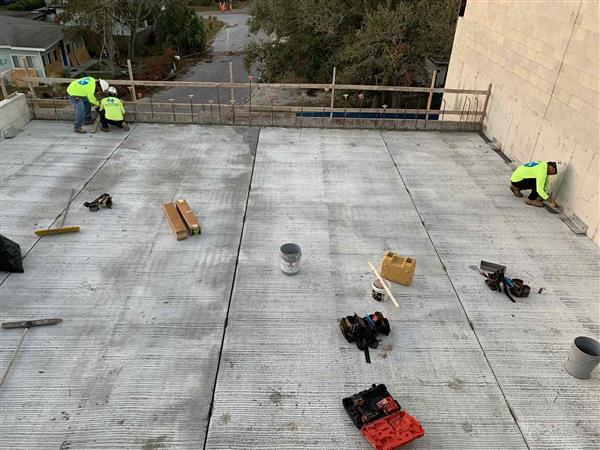

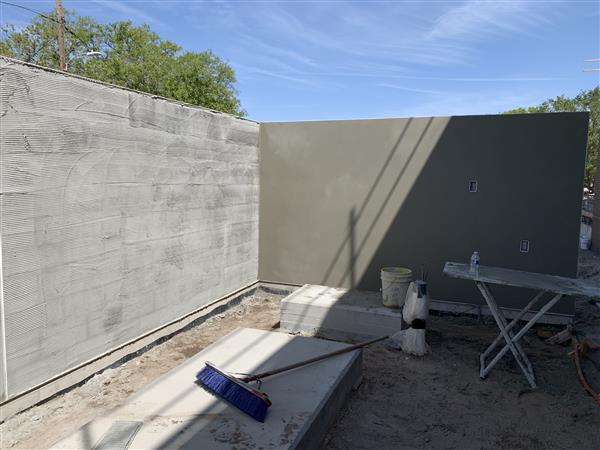

- Preparing east plaza for concrete pour

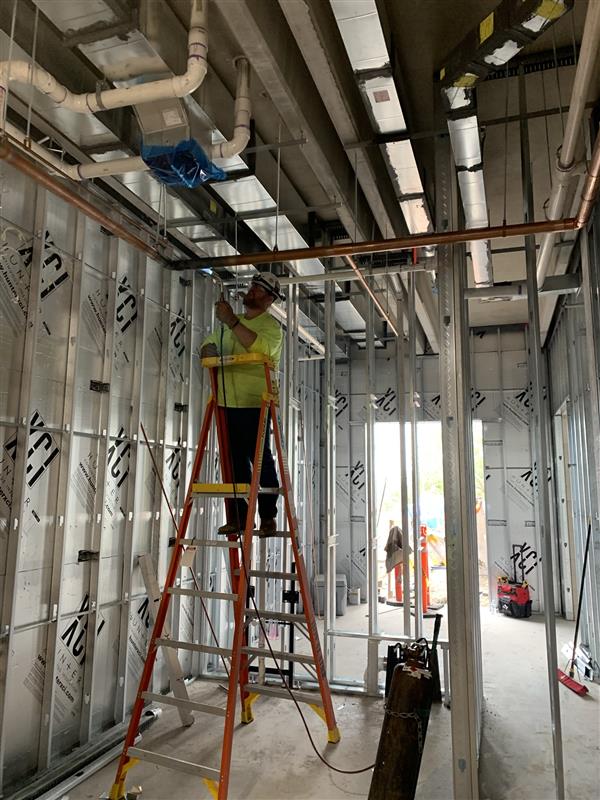

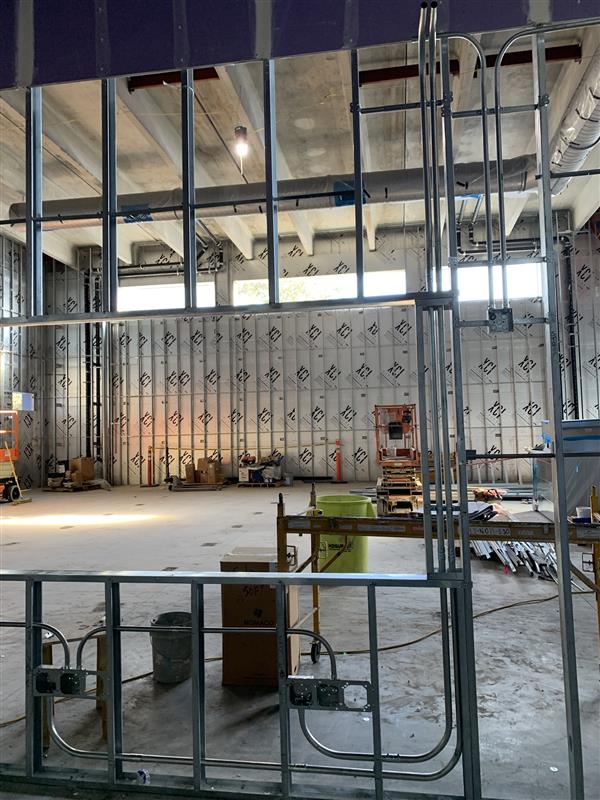

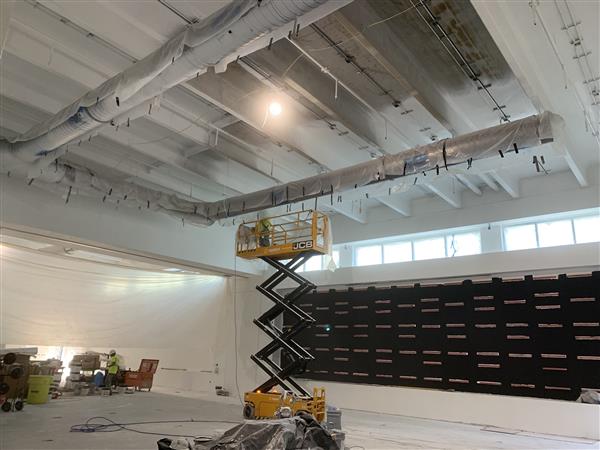

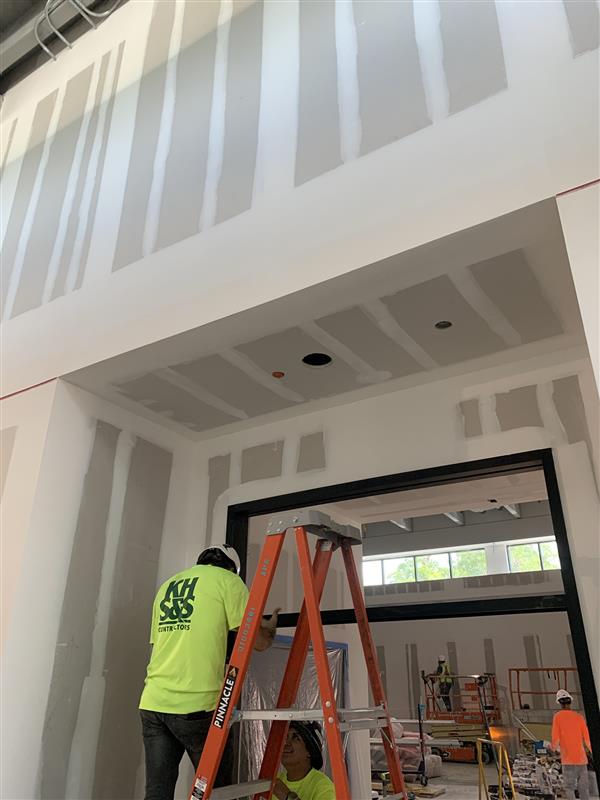

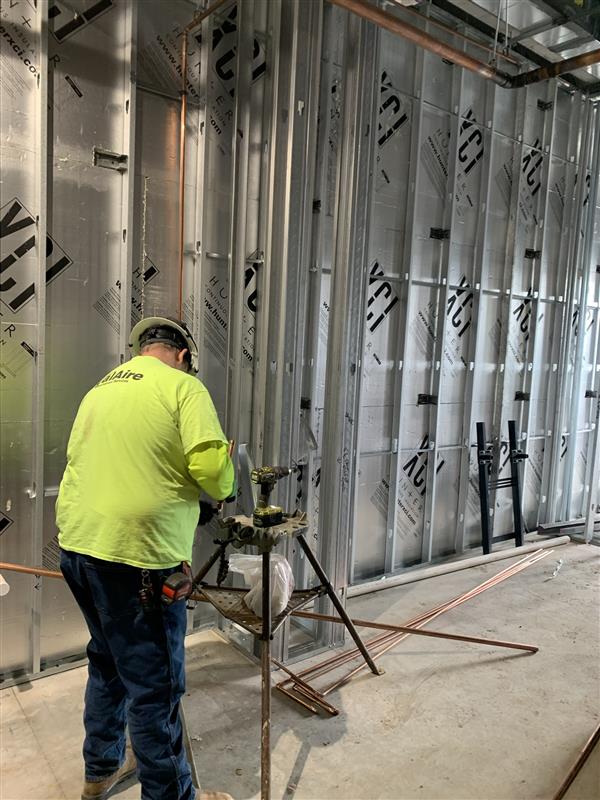

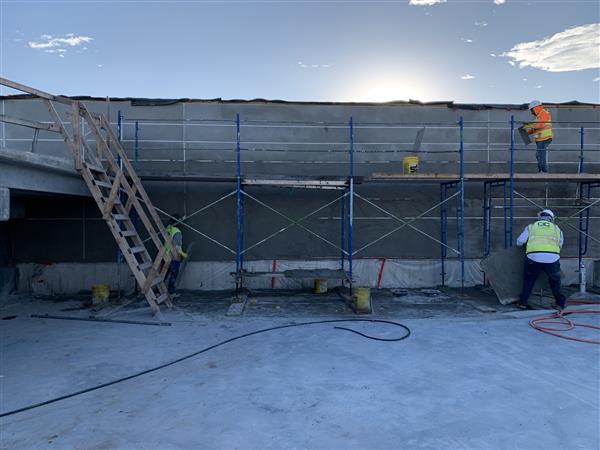

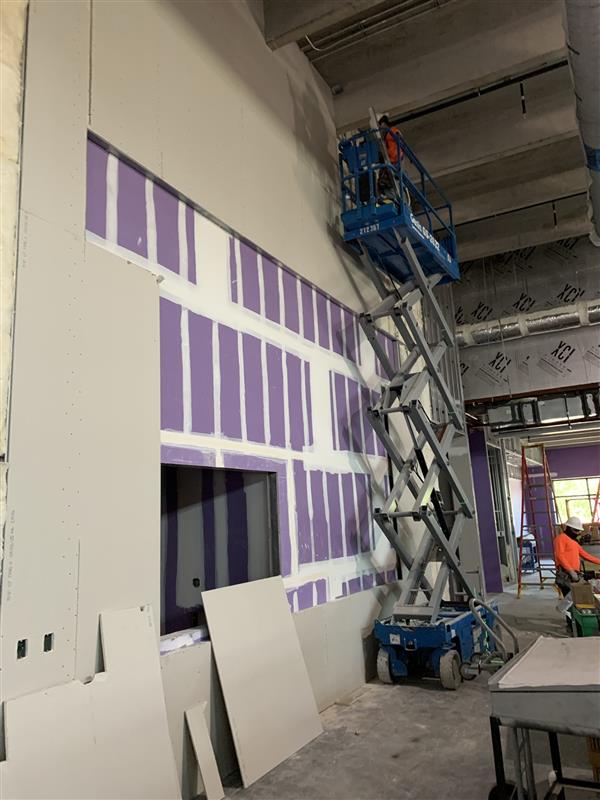

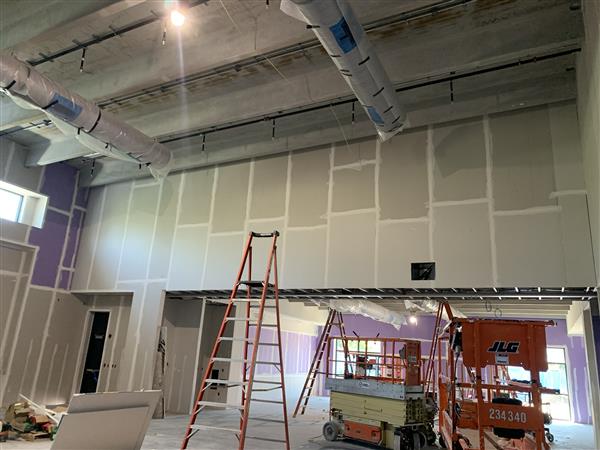

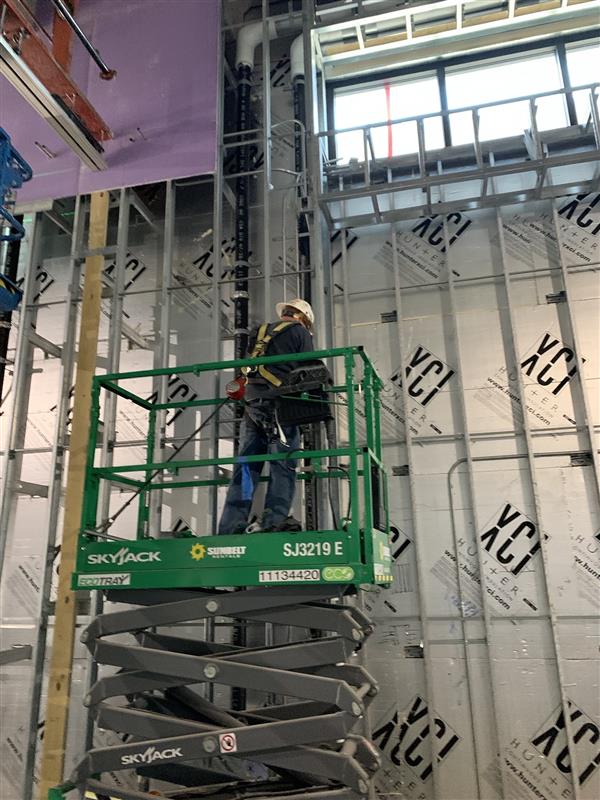

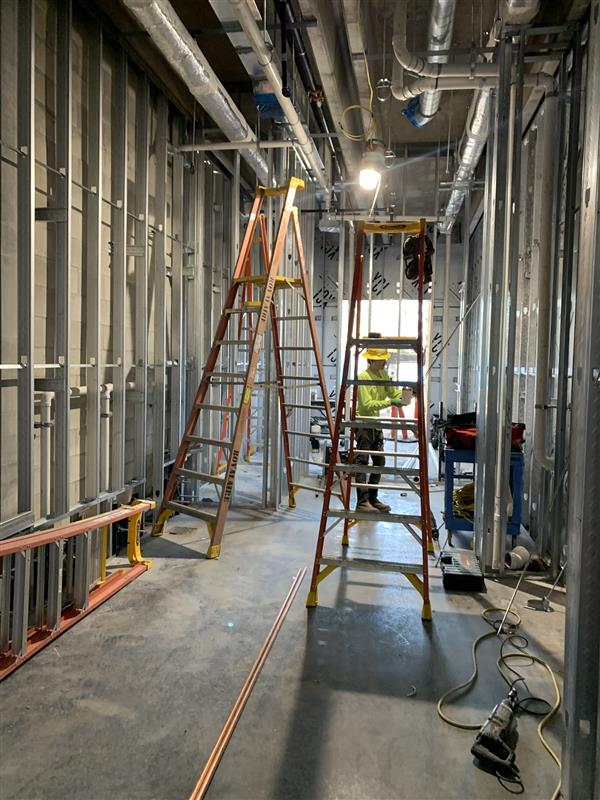

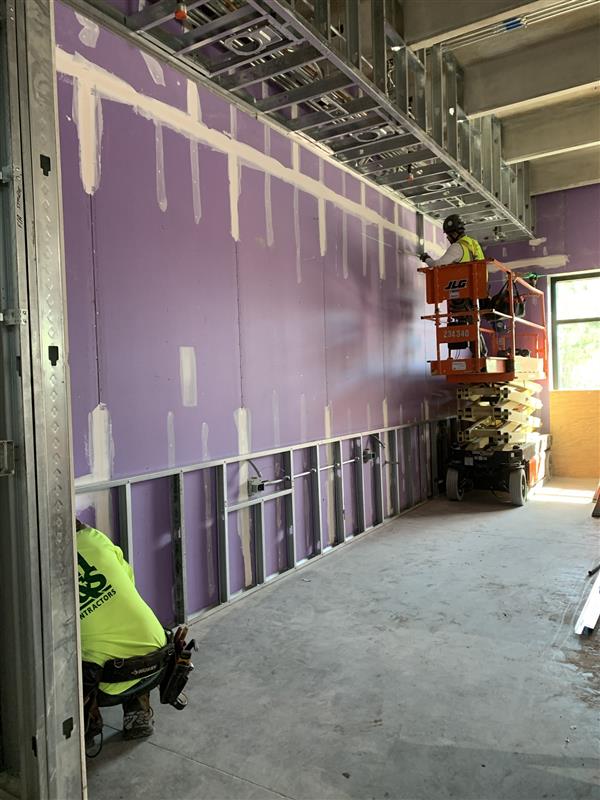

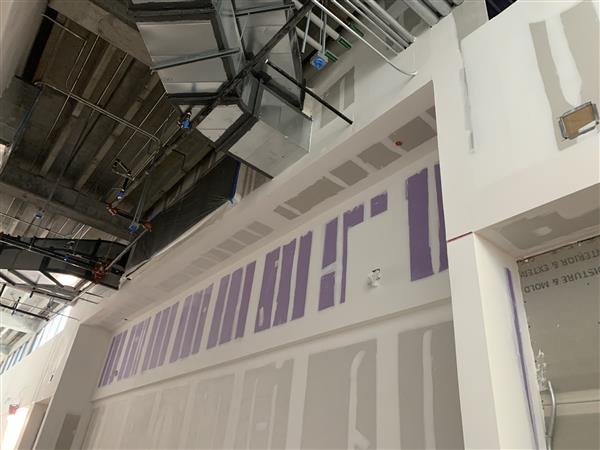

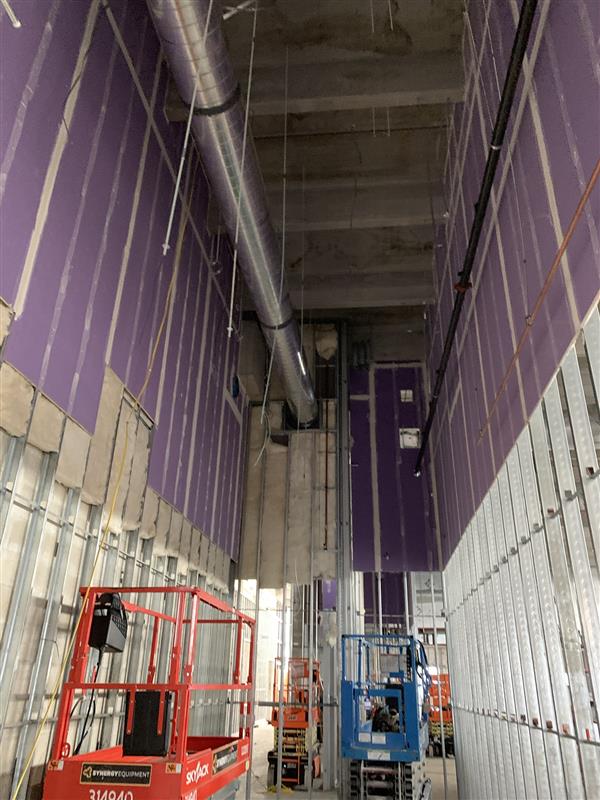

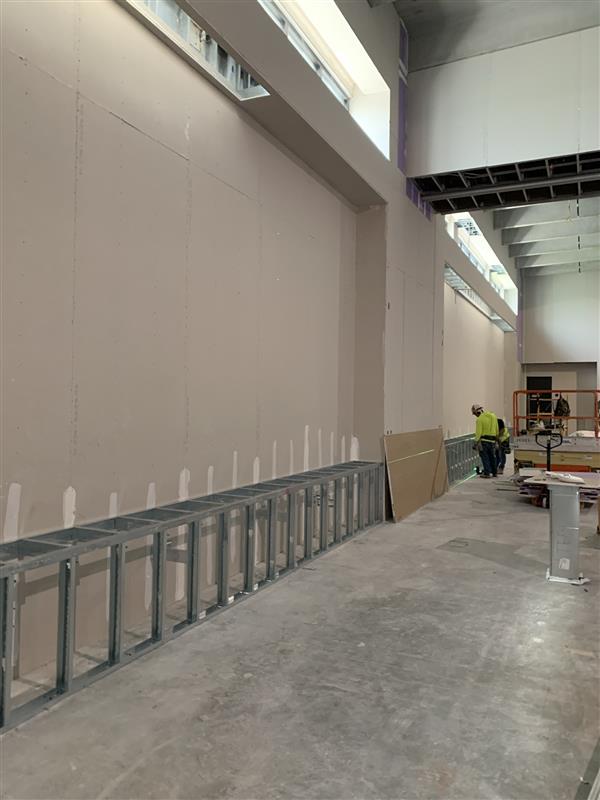

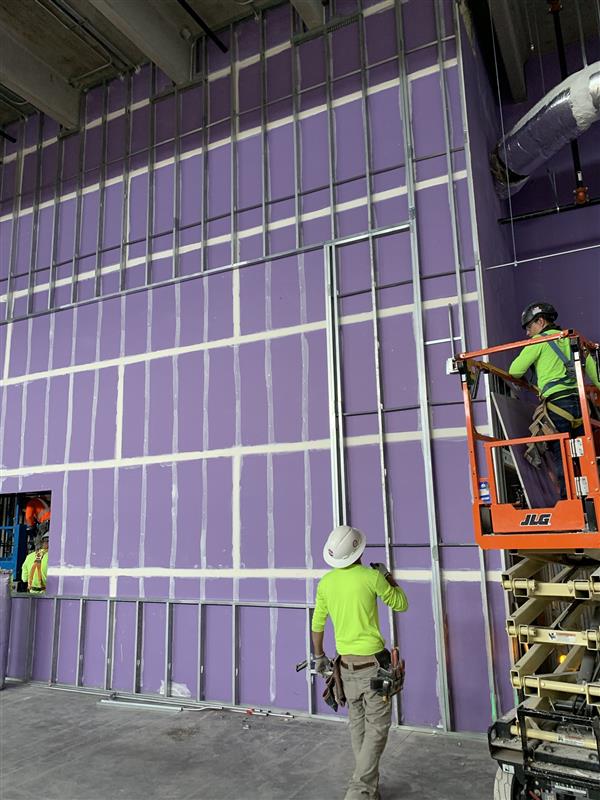

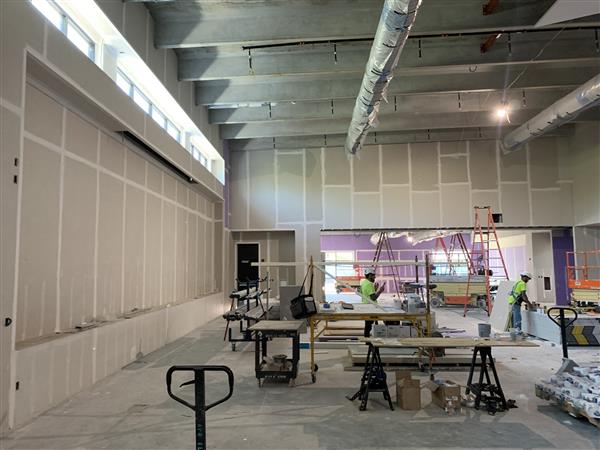

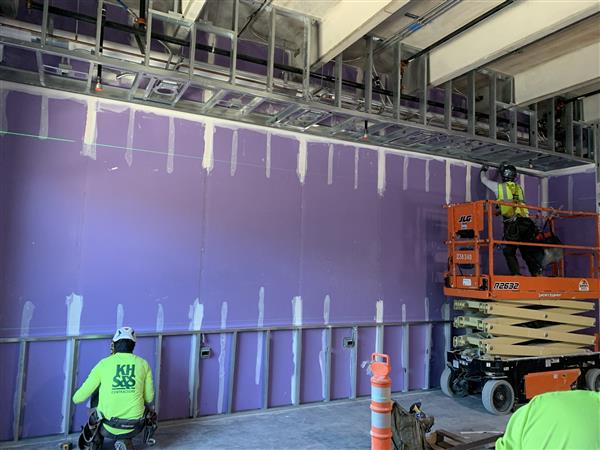

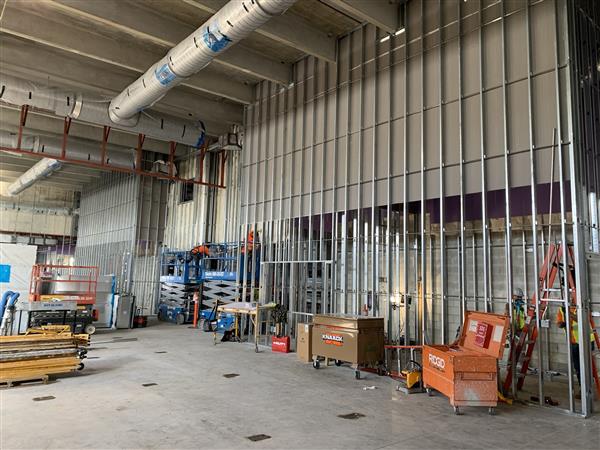

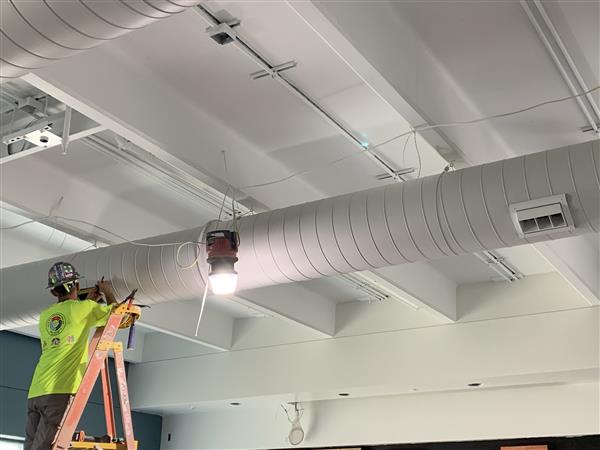

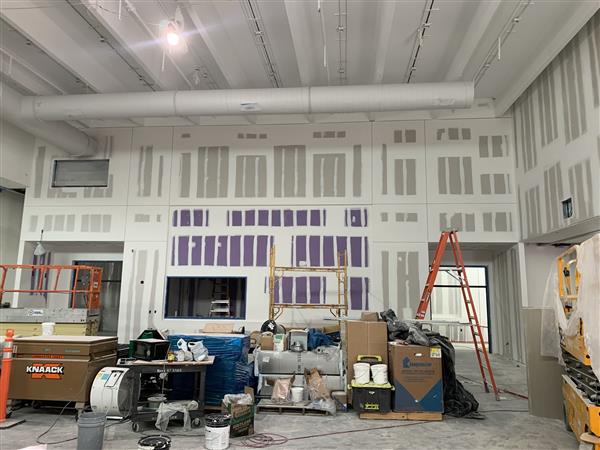

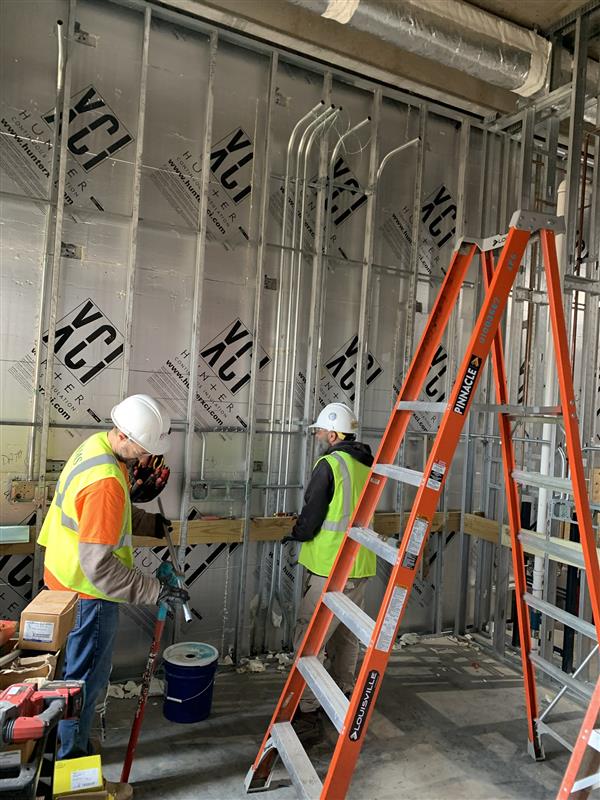

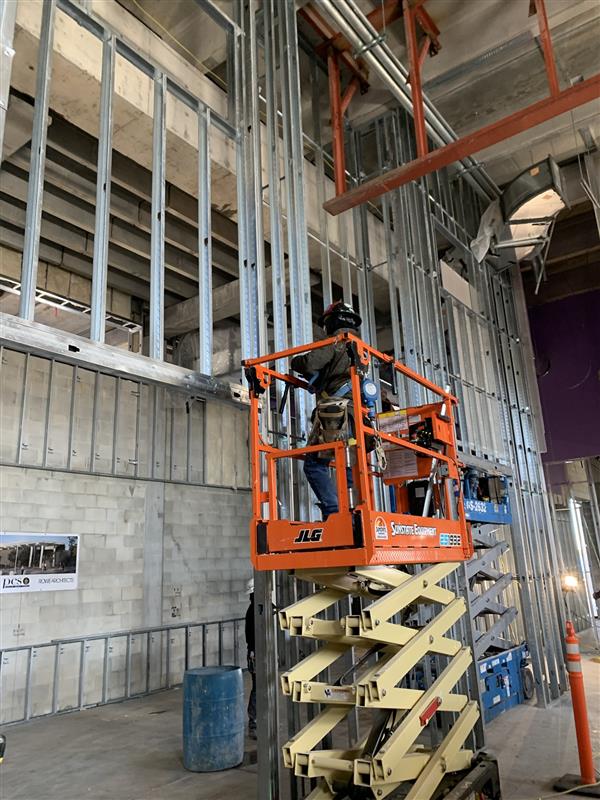

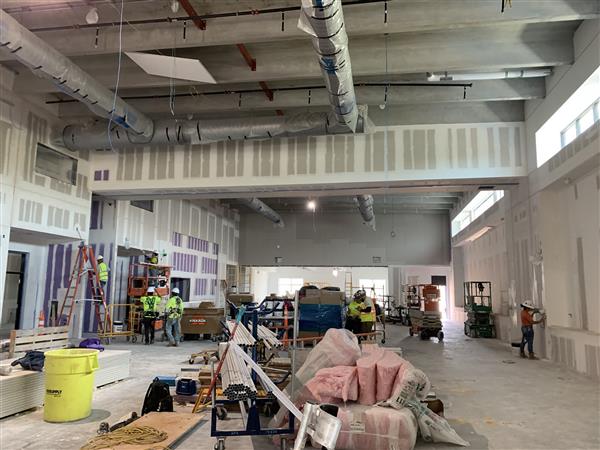

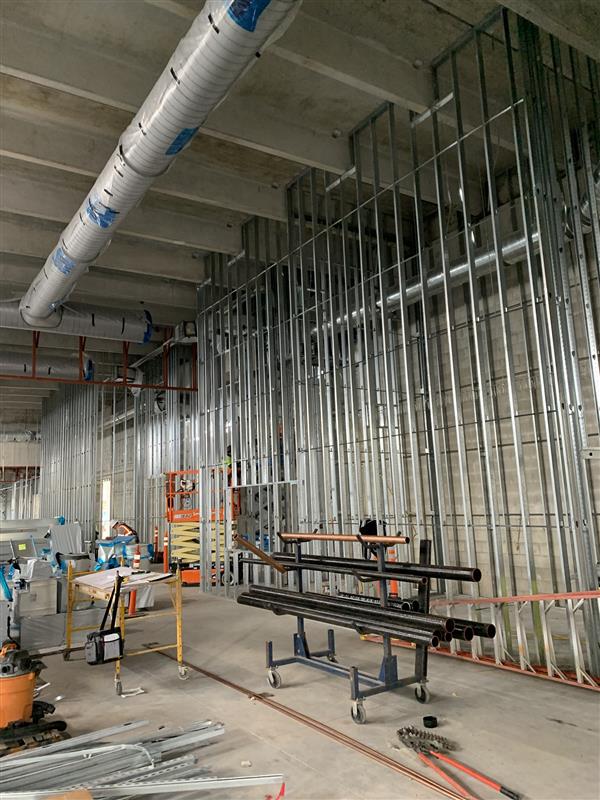

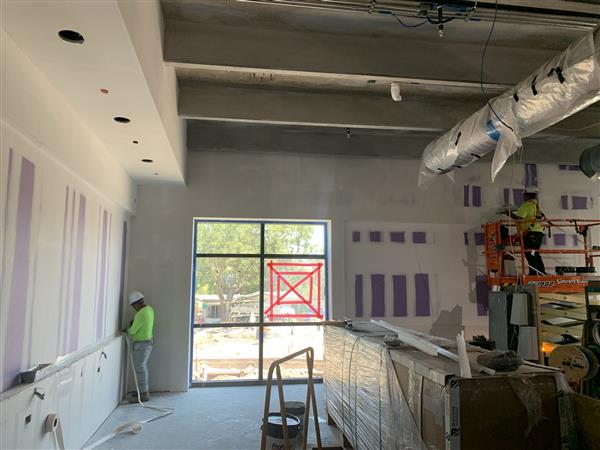

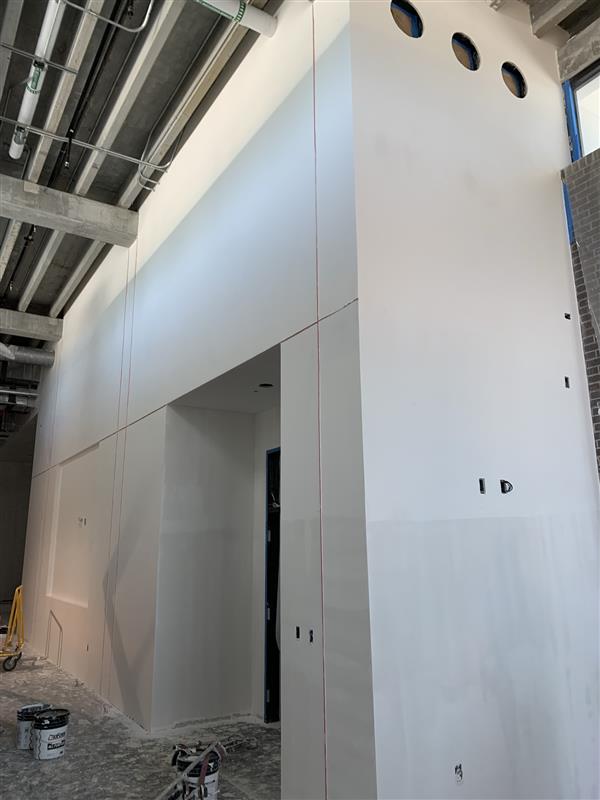

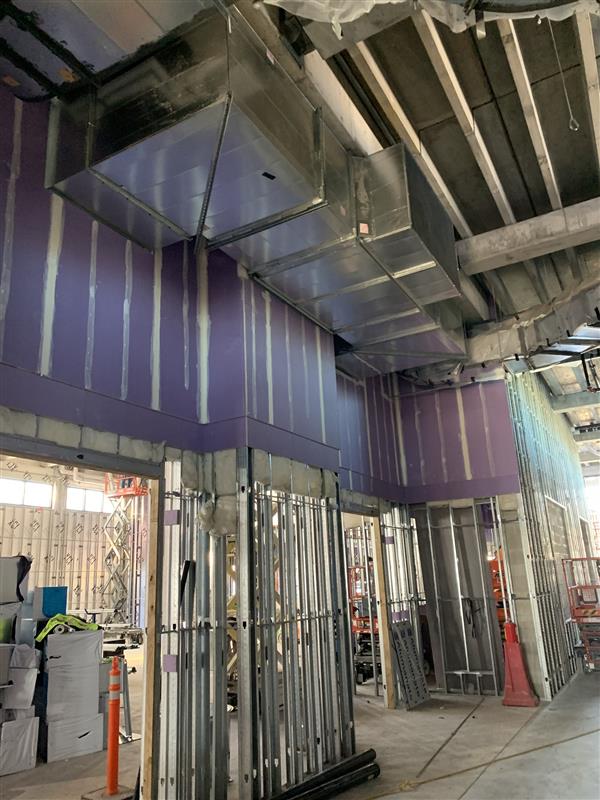

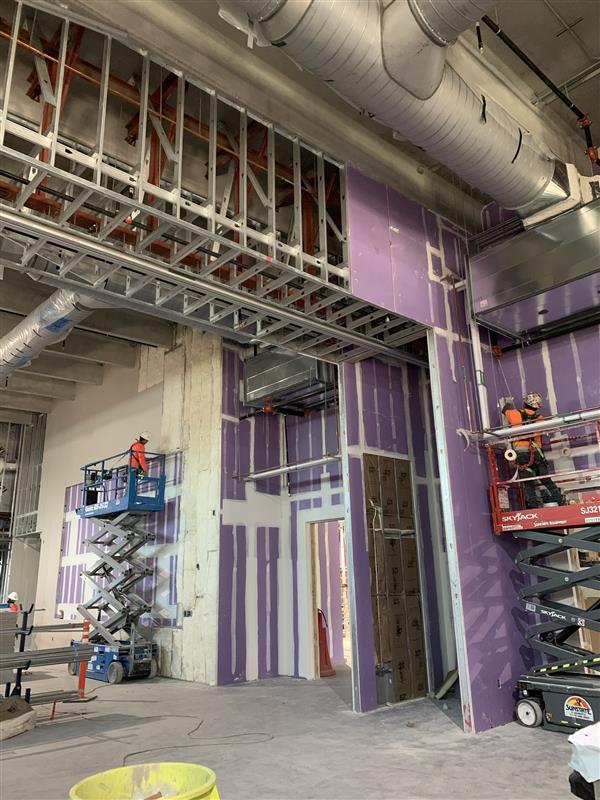

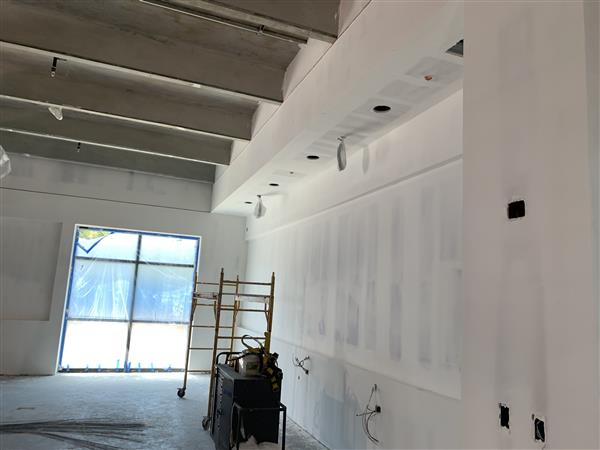

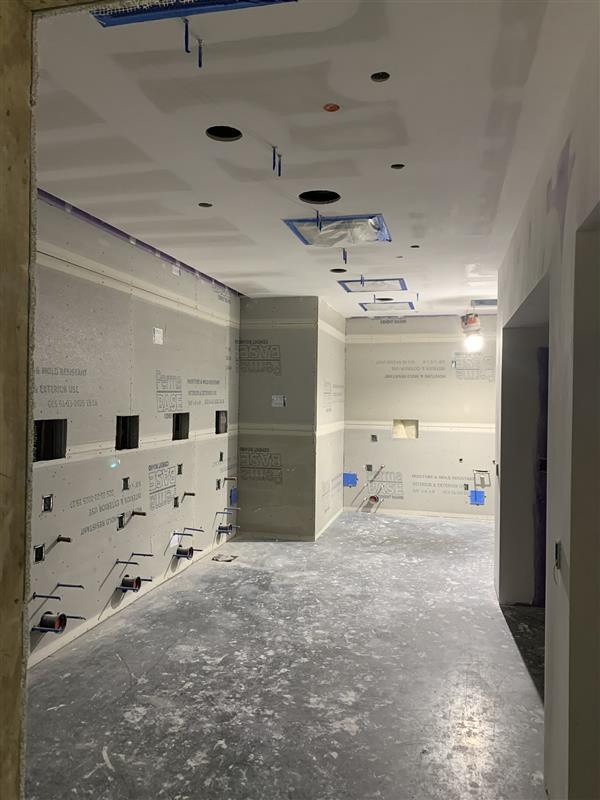

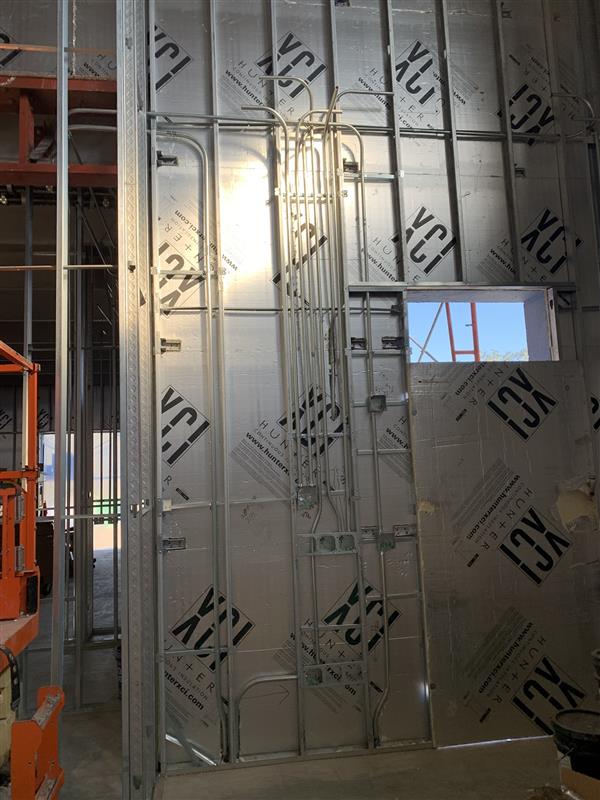

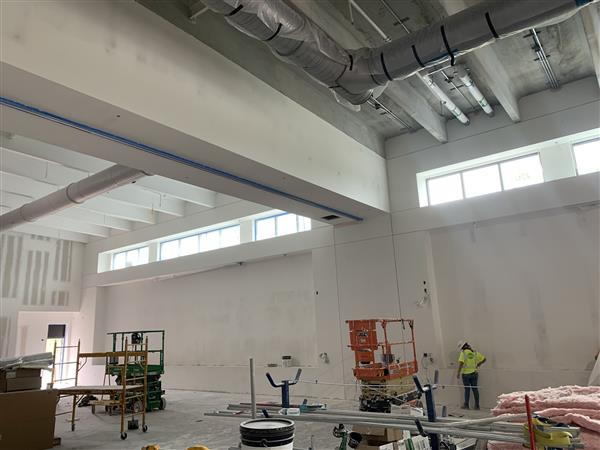

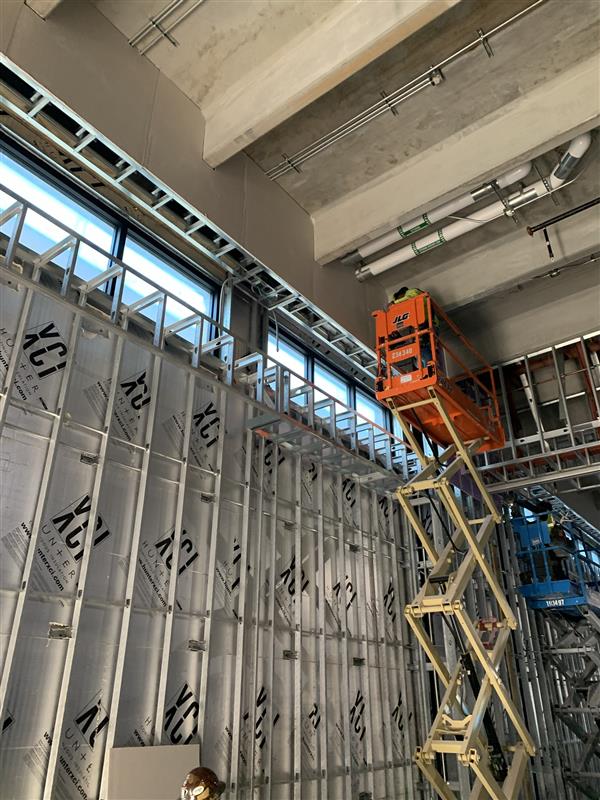

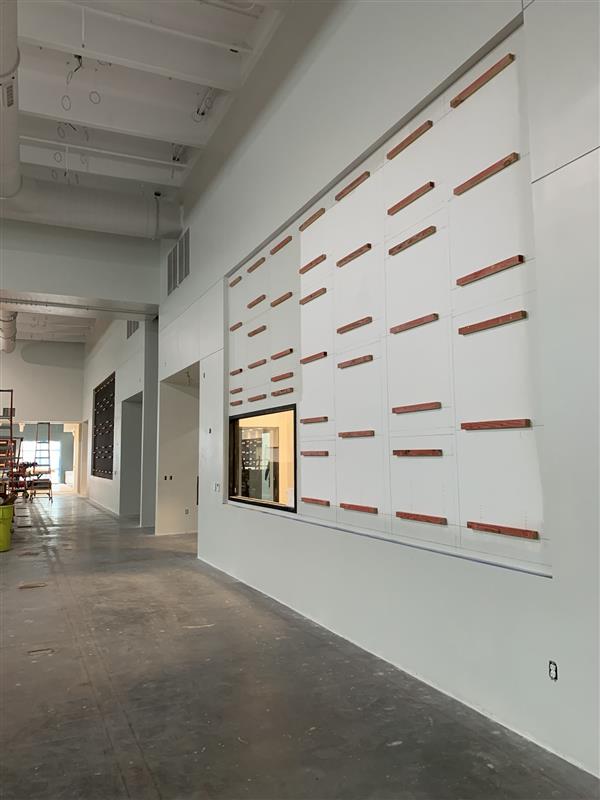

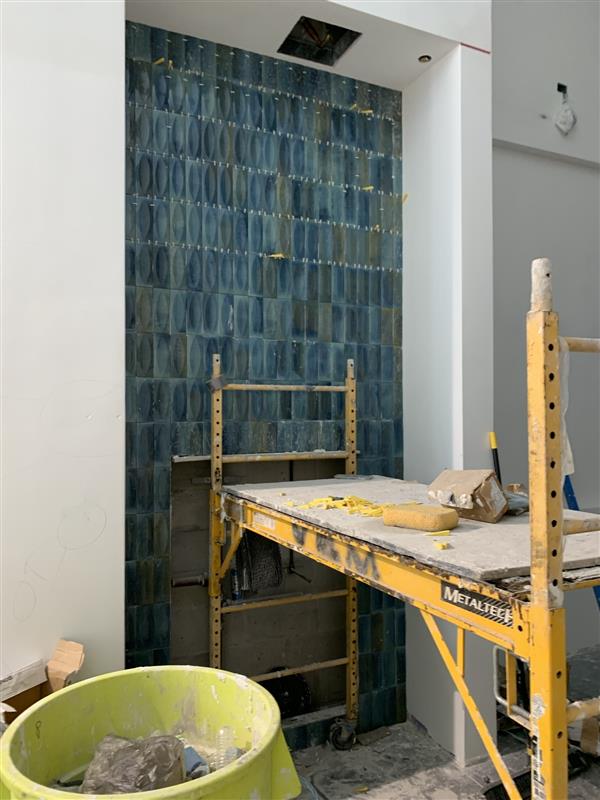

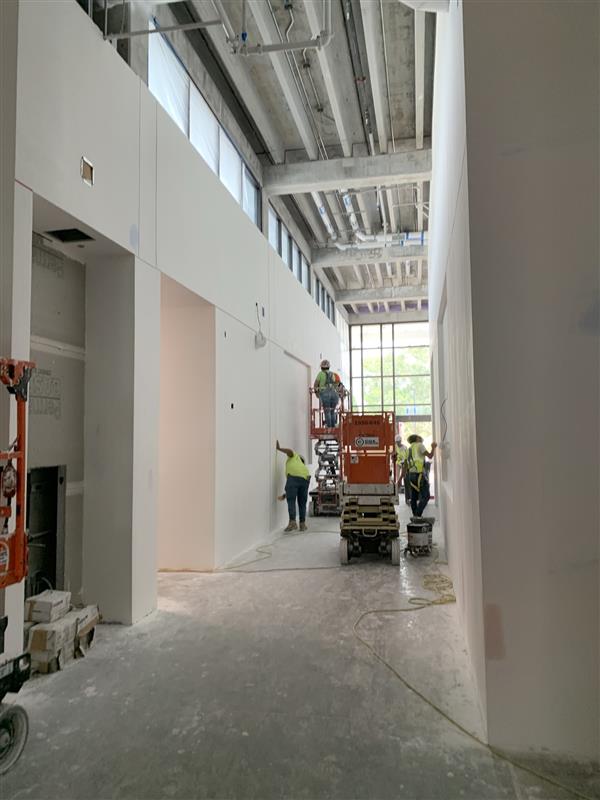

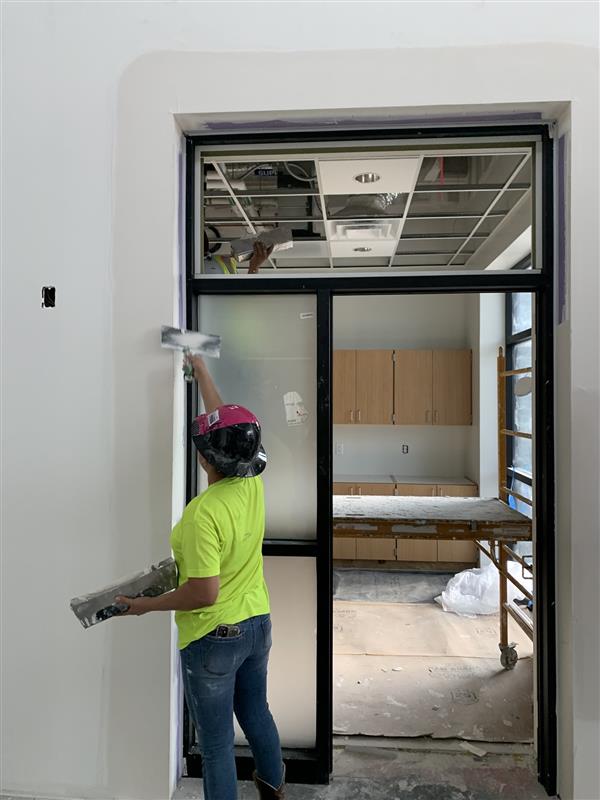

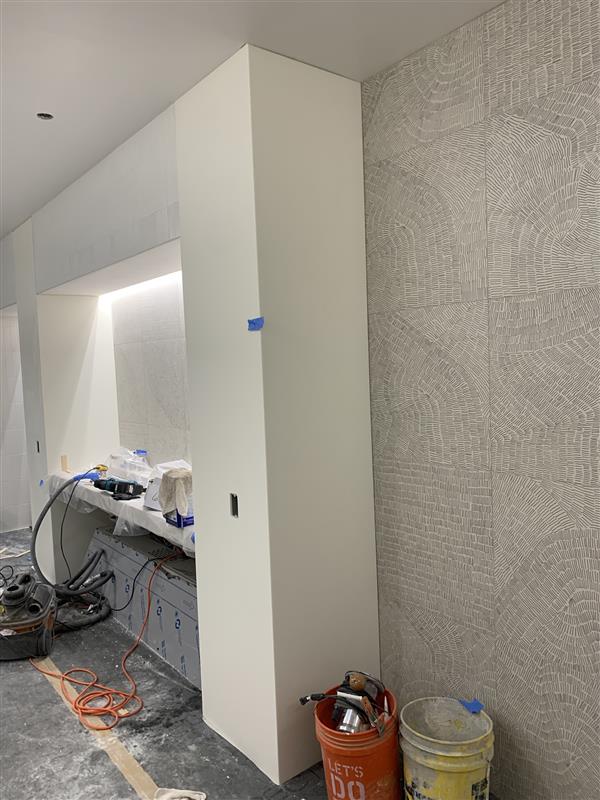

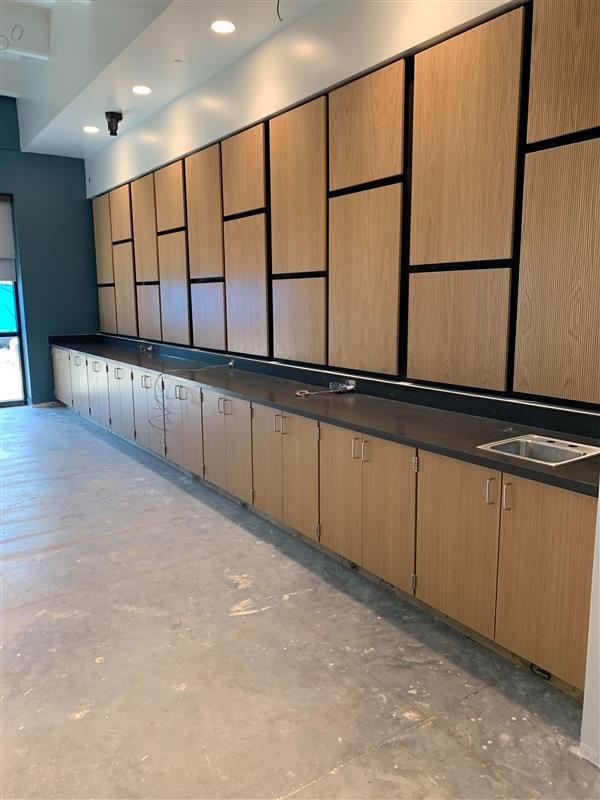

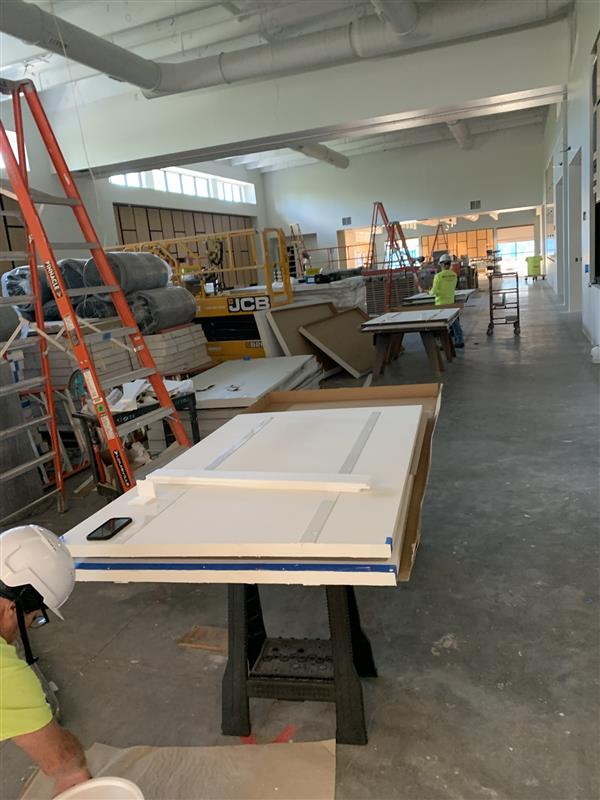

- Continuing with drywall finish

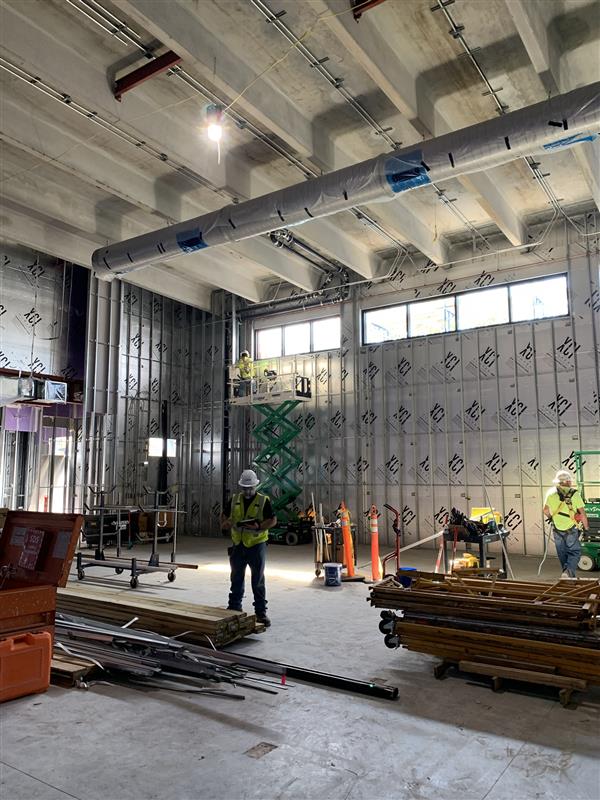

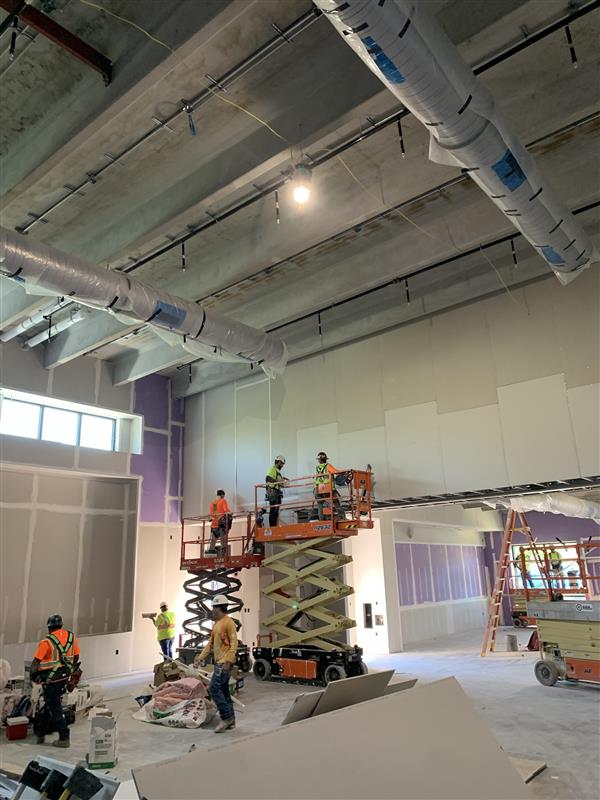

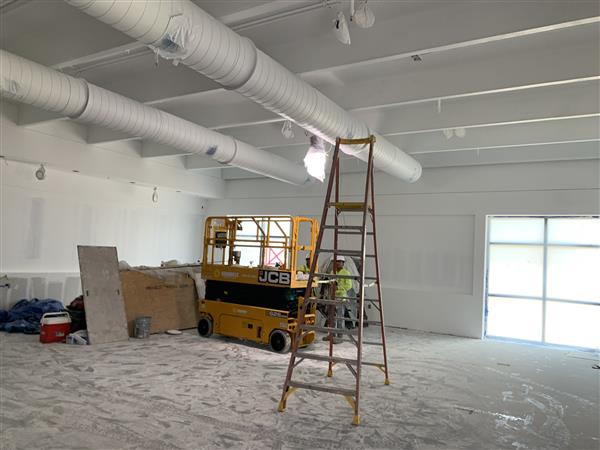

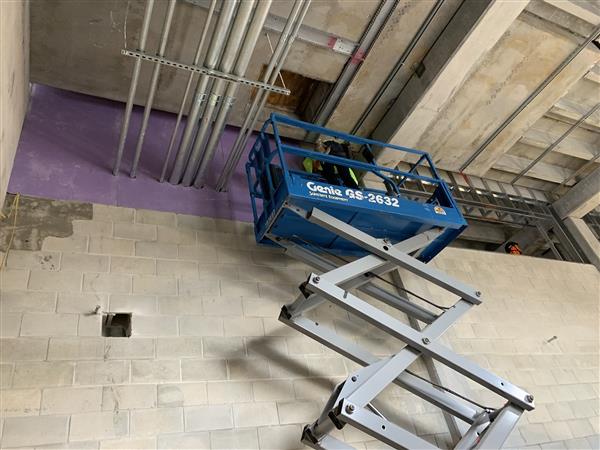

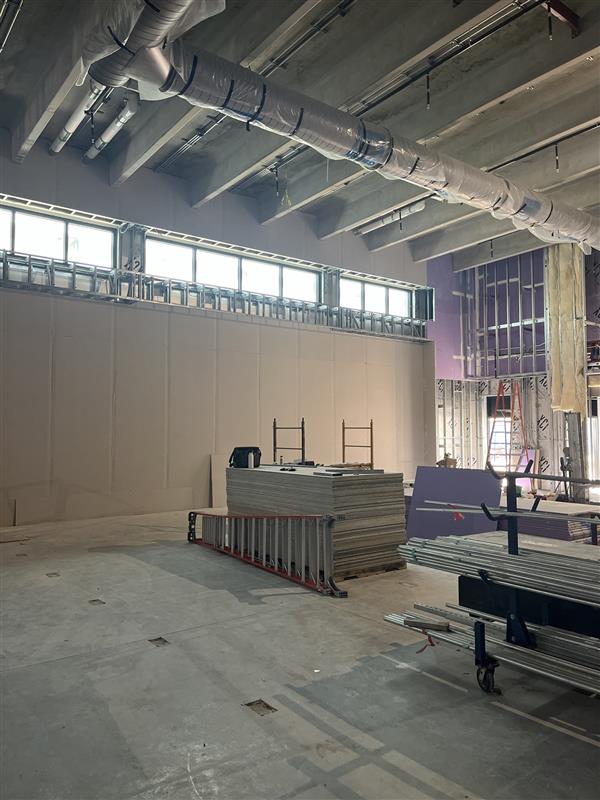

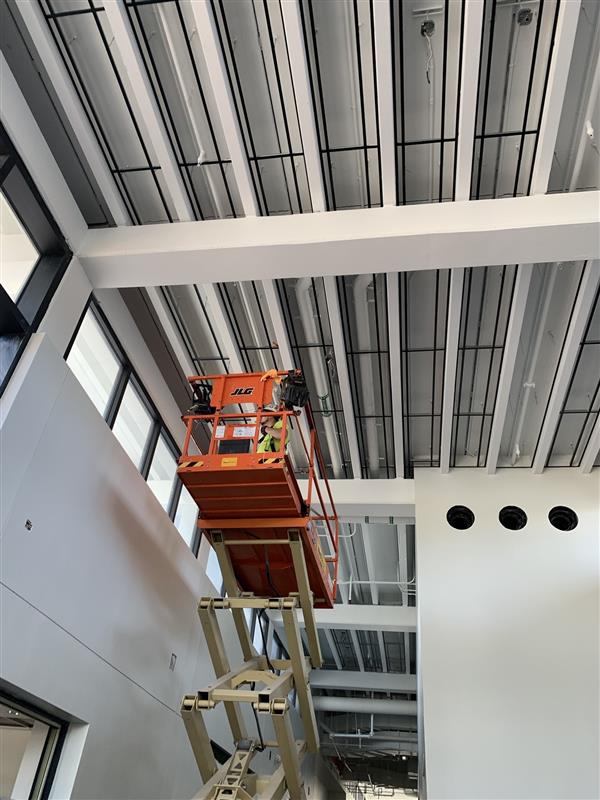

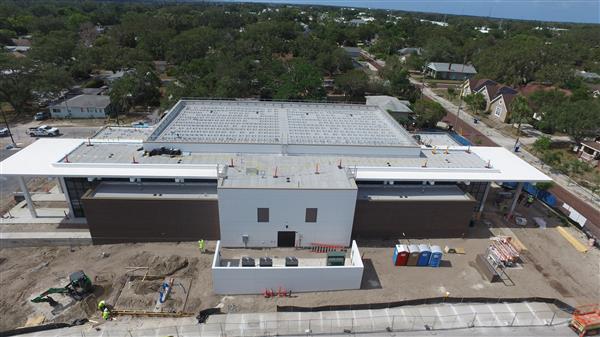

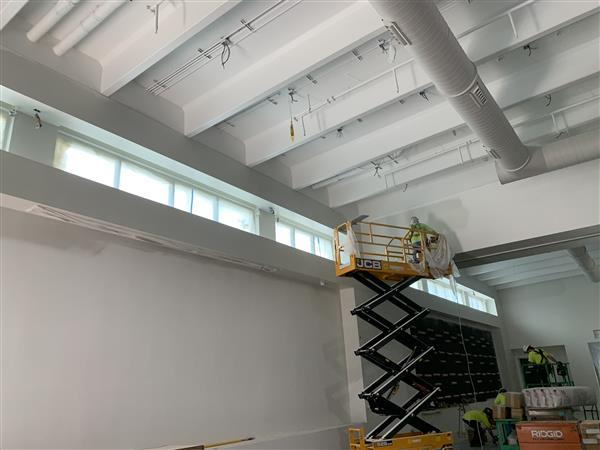

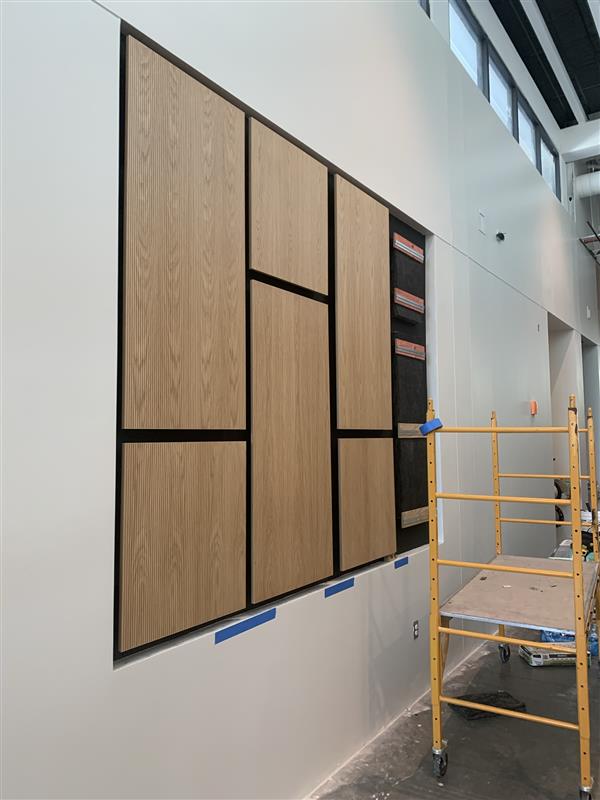

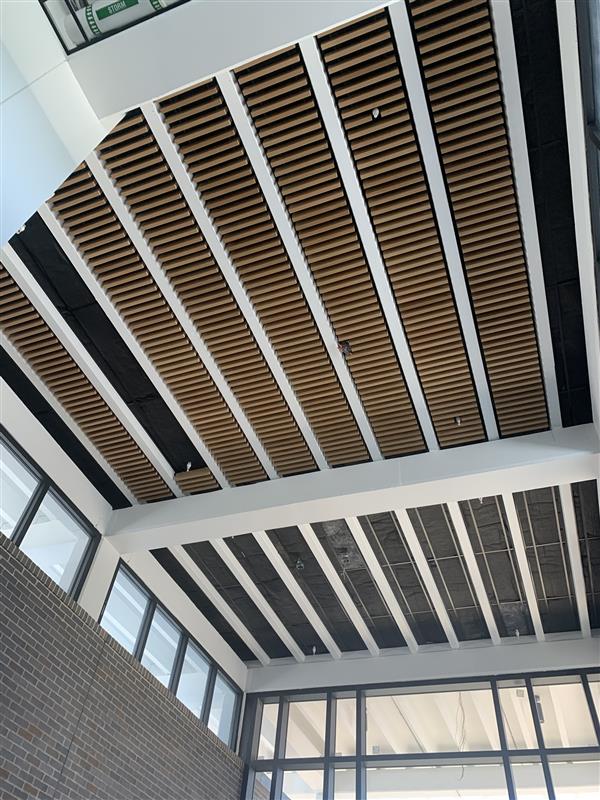

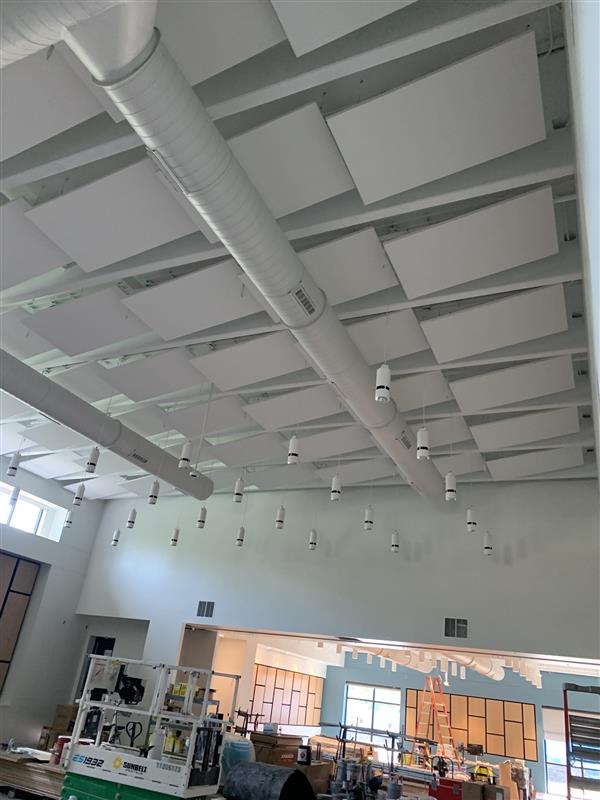

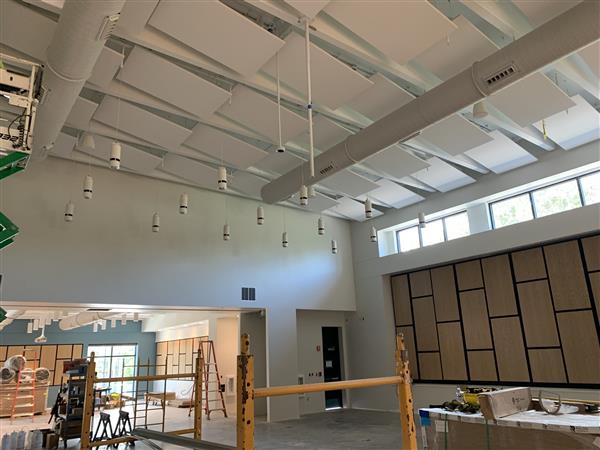

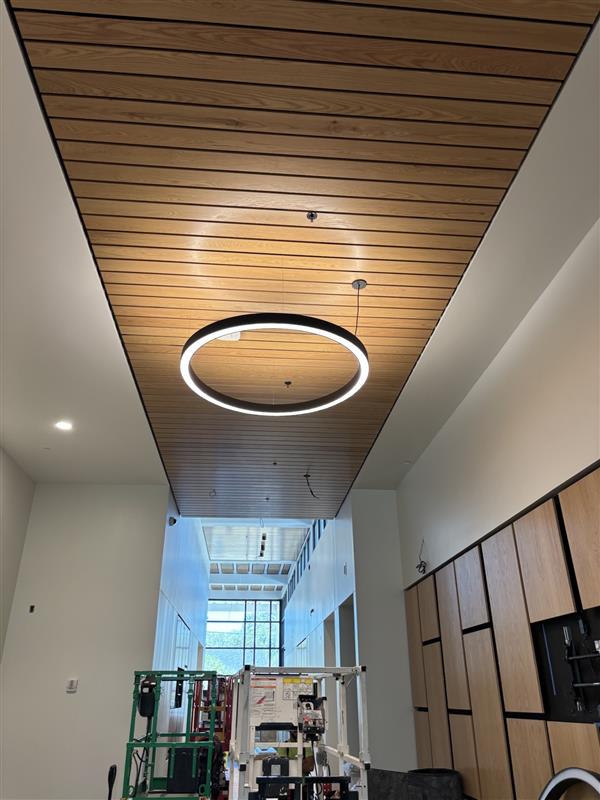

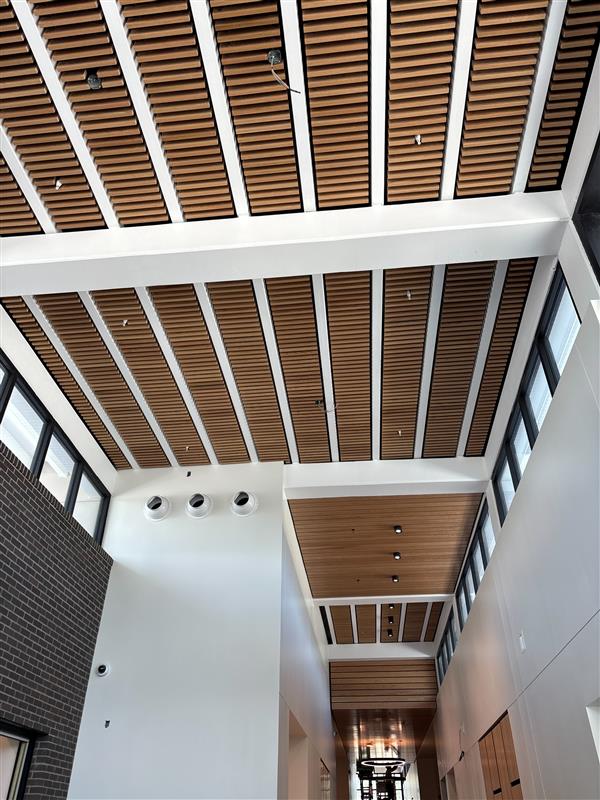

- Continuing wood wall panel lay out and install acoustical ceiling panel supports

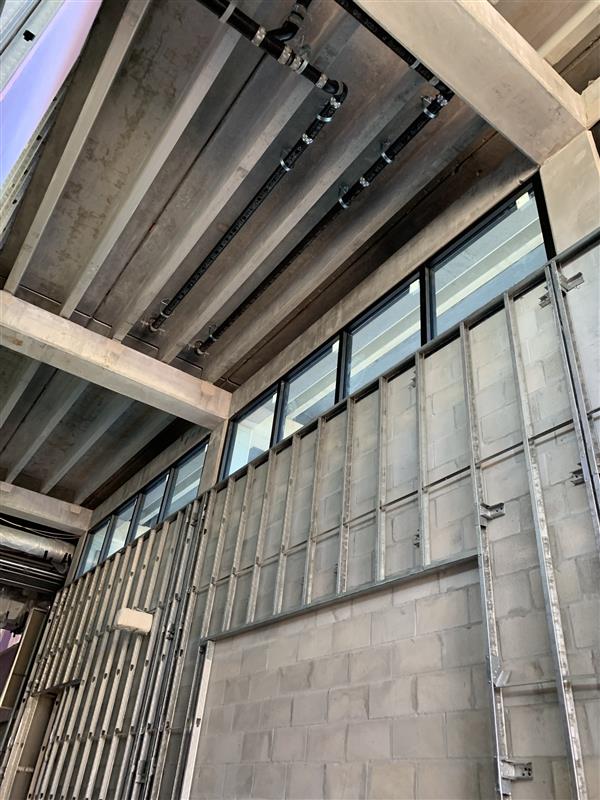

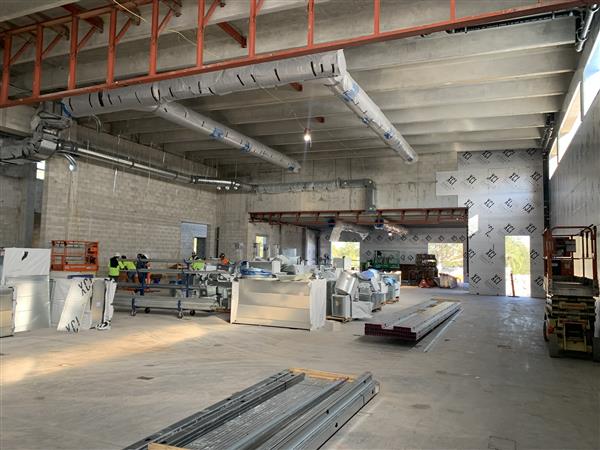

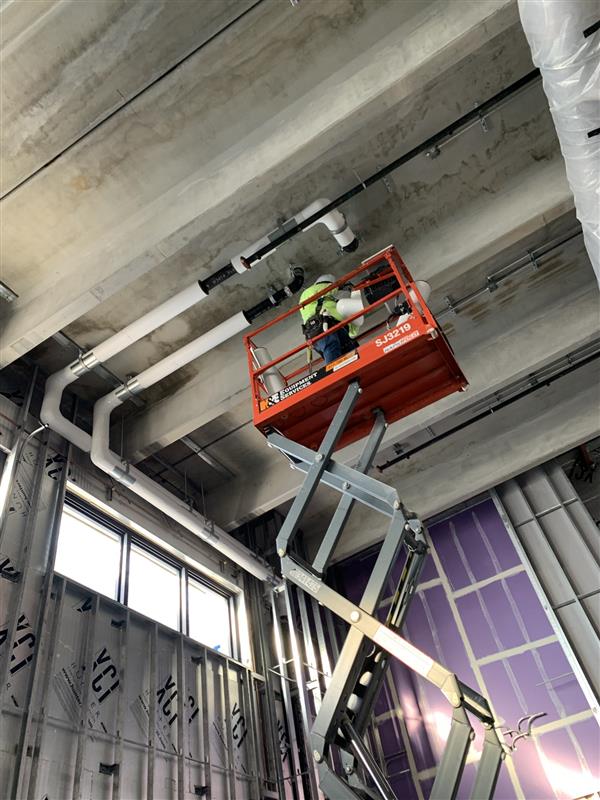

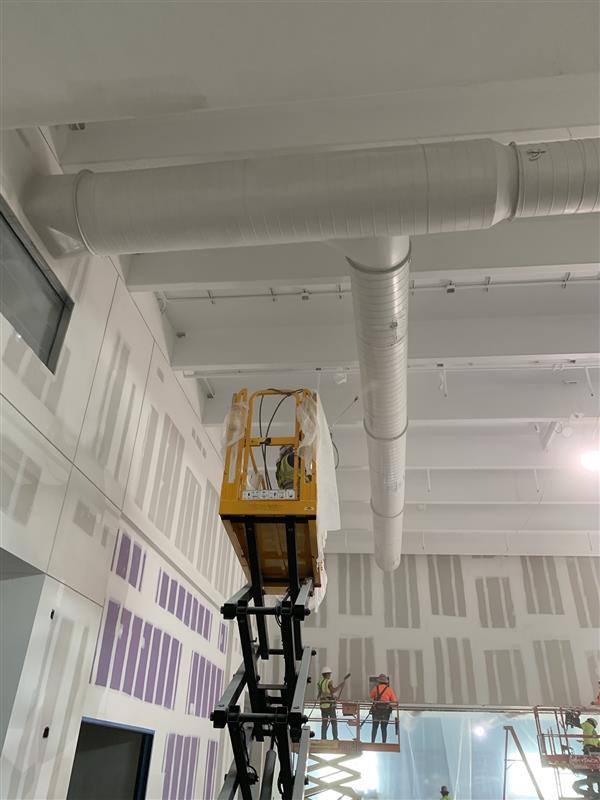

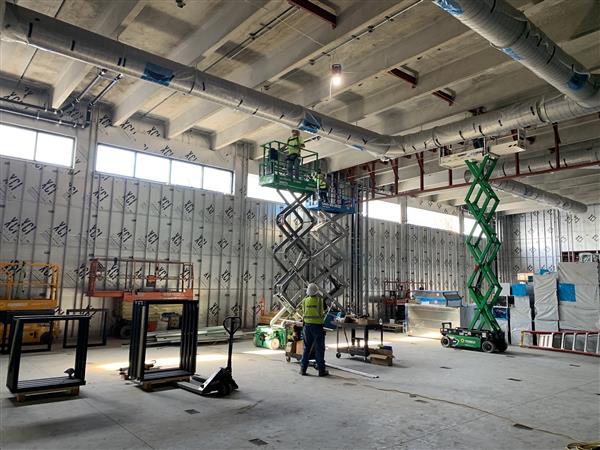

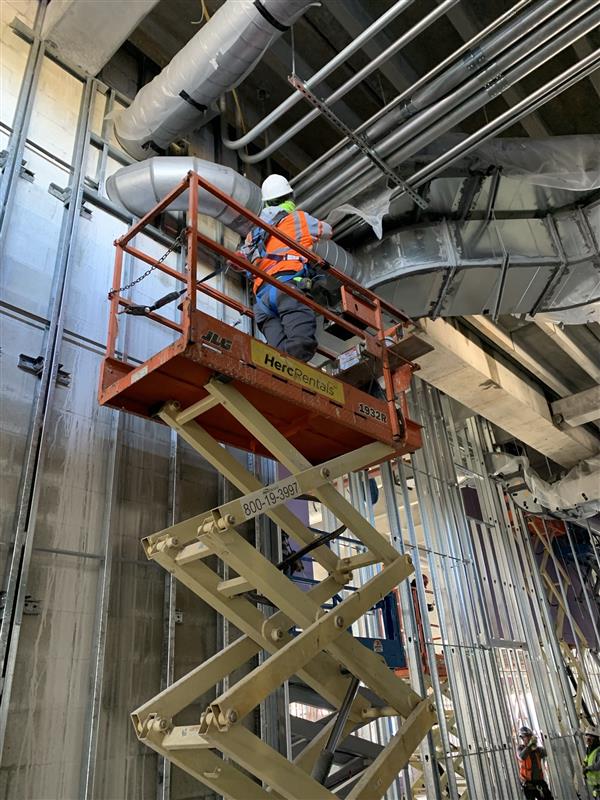

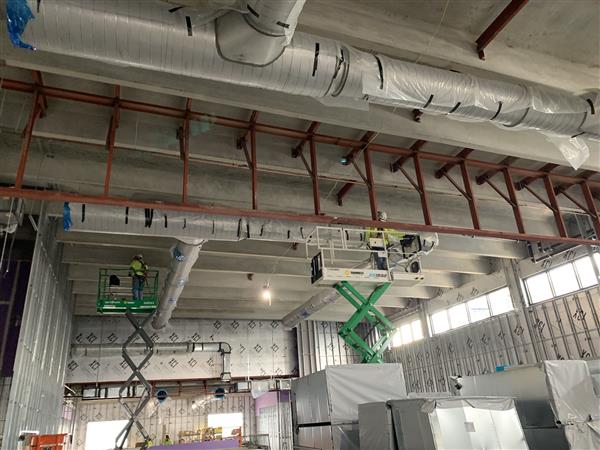

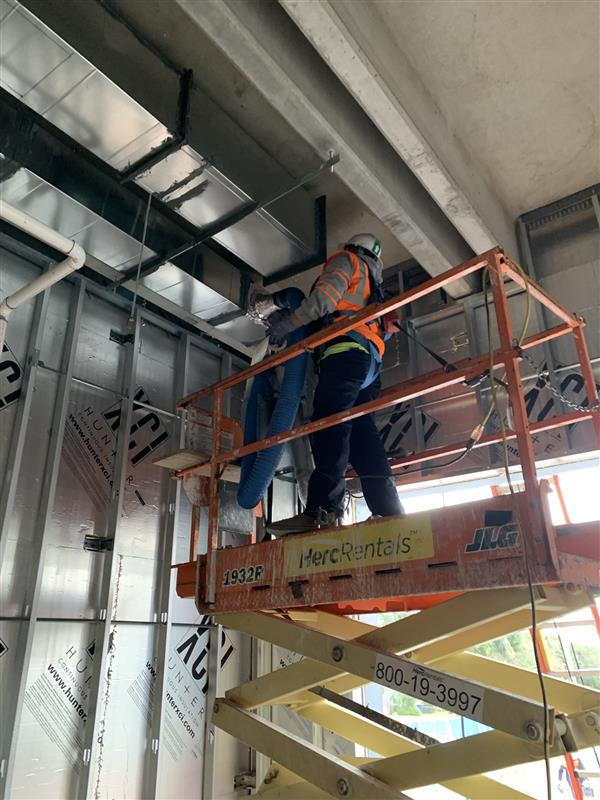

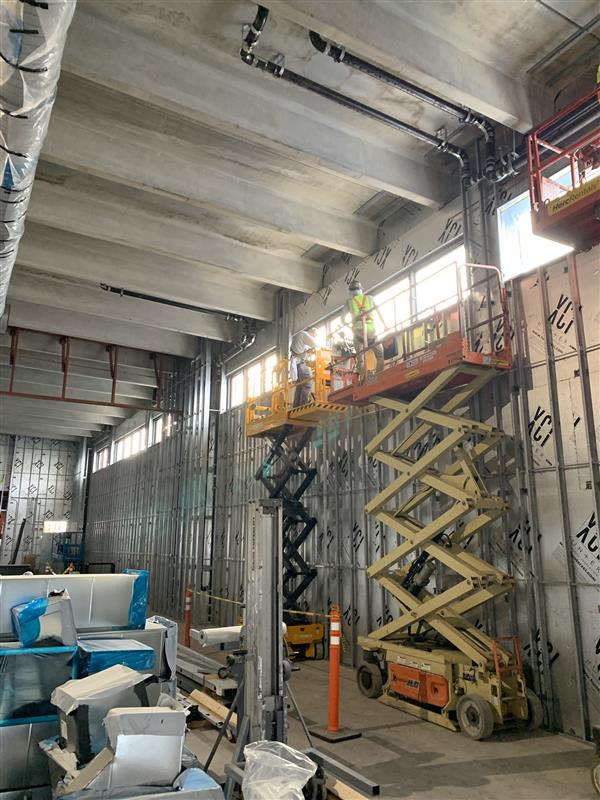

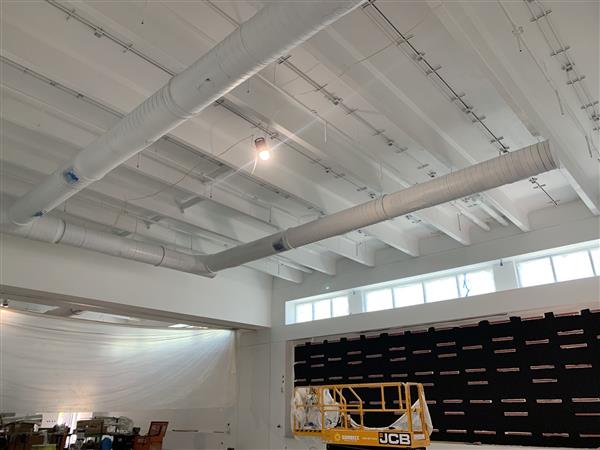

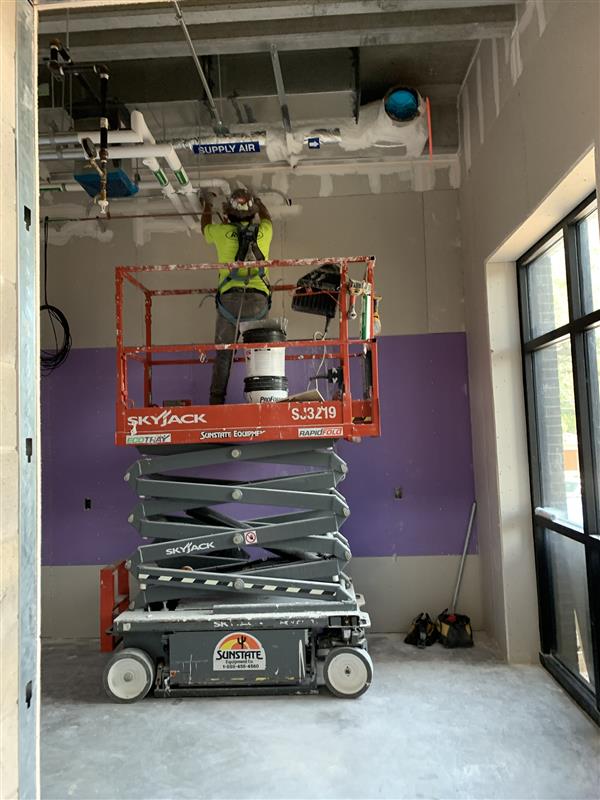

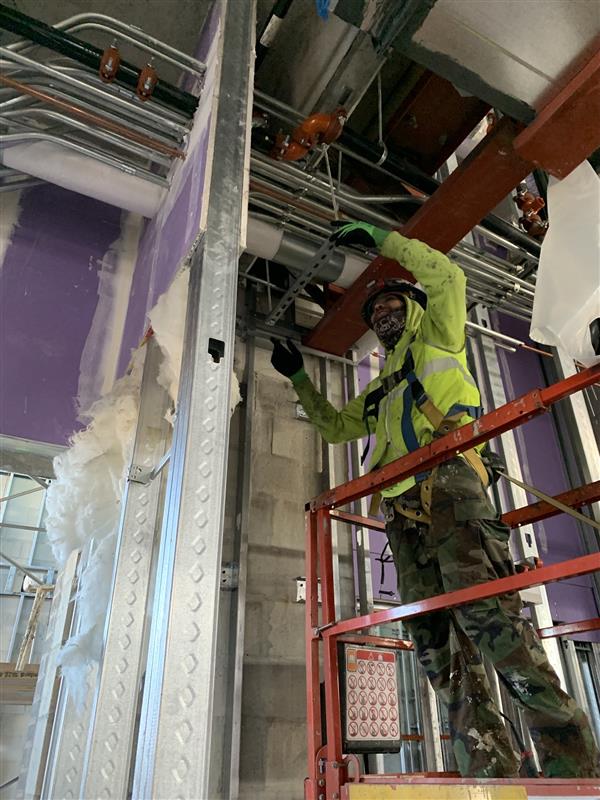

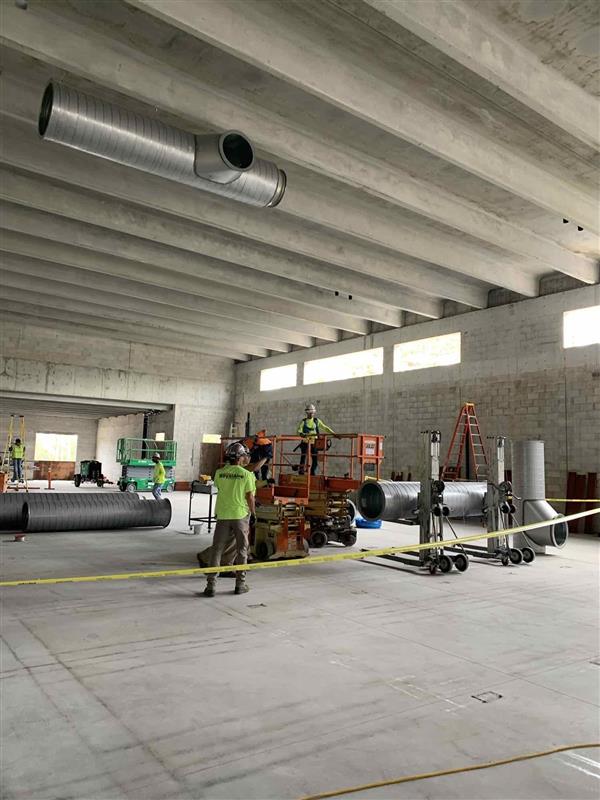

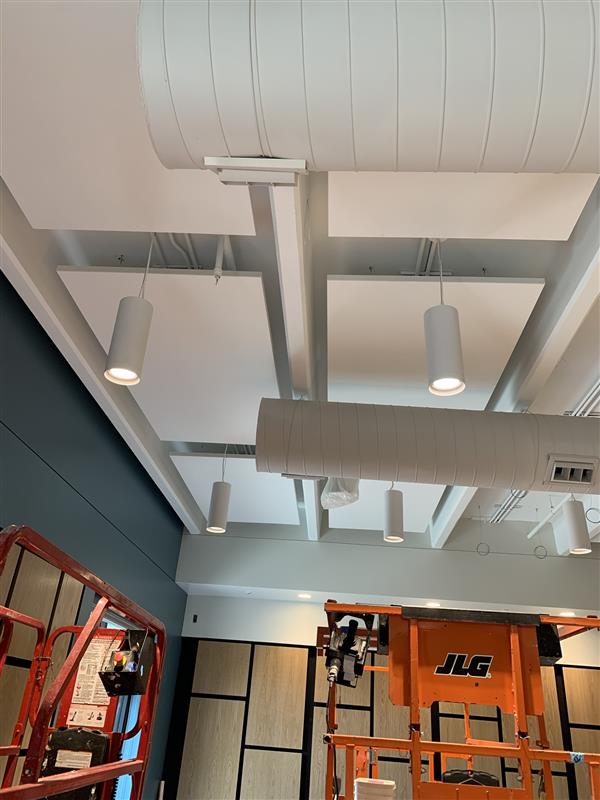

- Continuing installing and programming HVAC controls and VAVs as well as installing diffusers

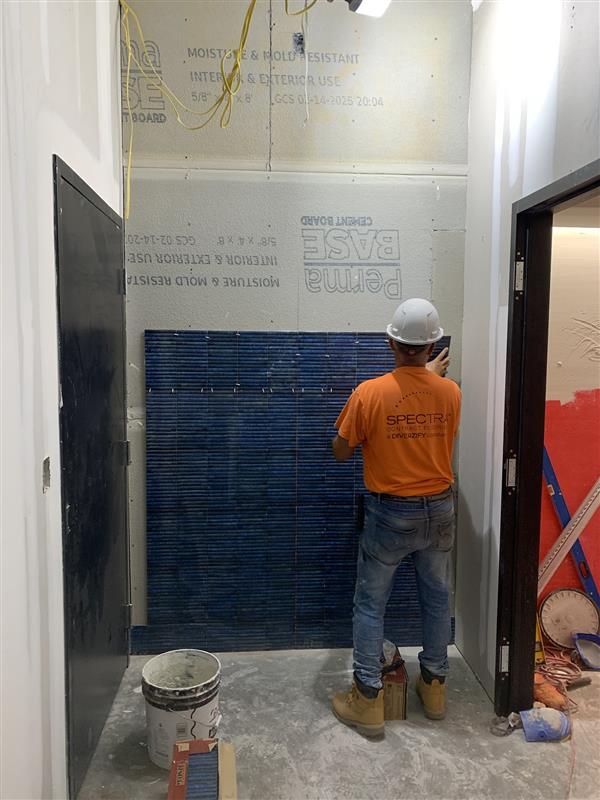

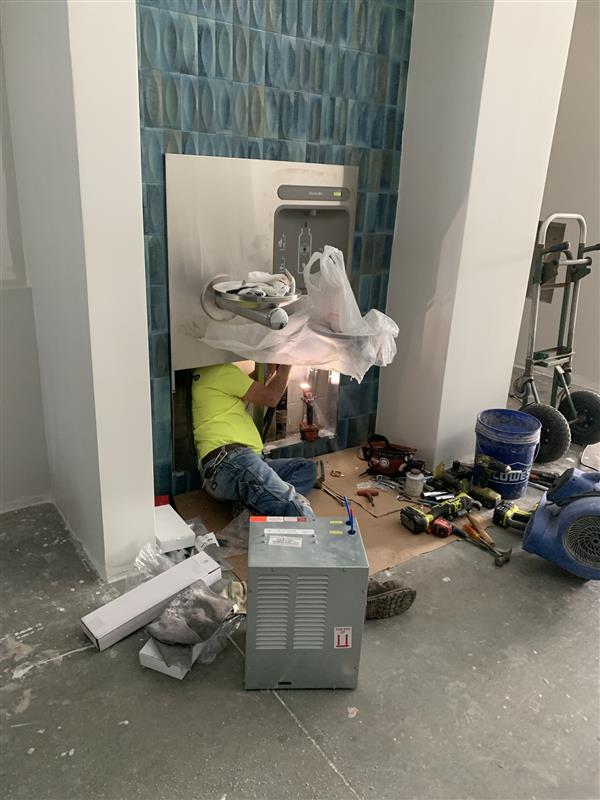

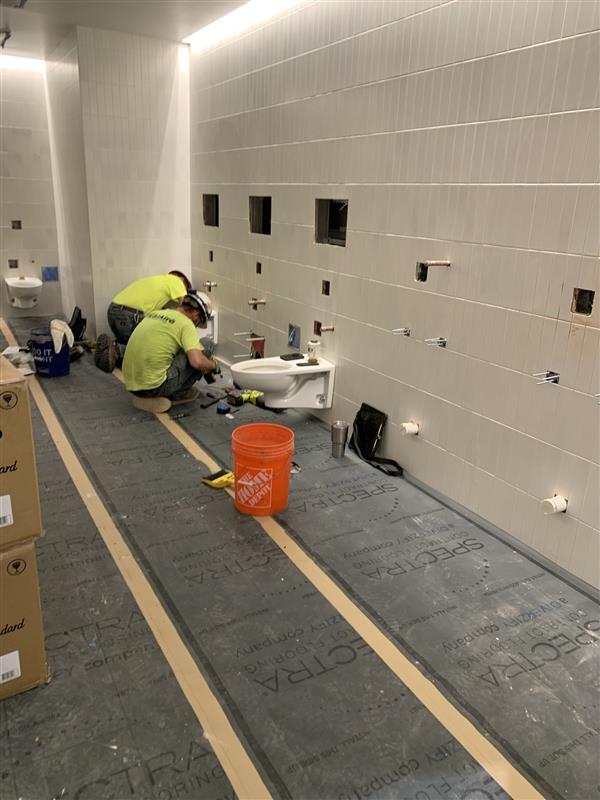

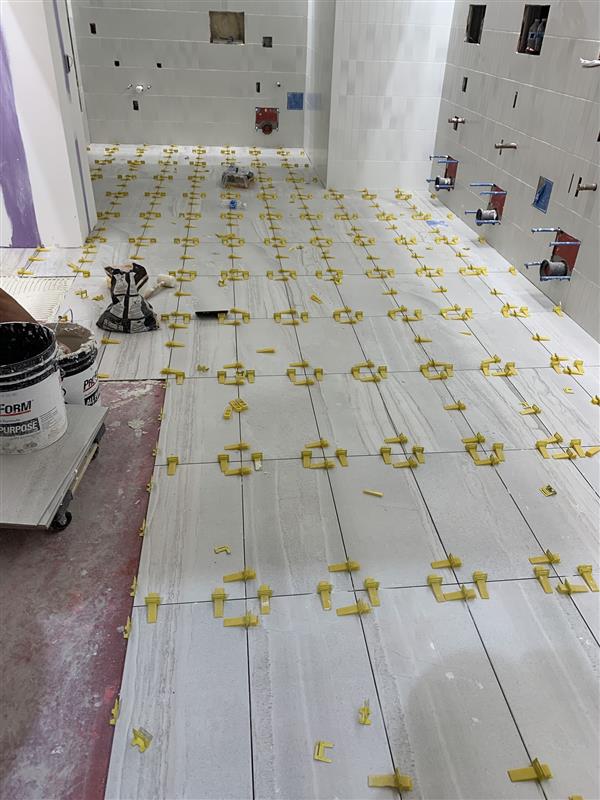

- Continuing tile and grout in men's restroom

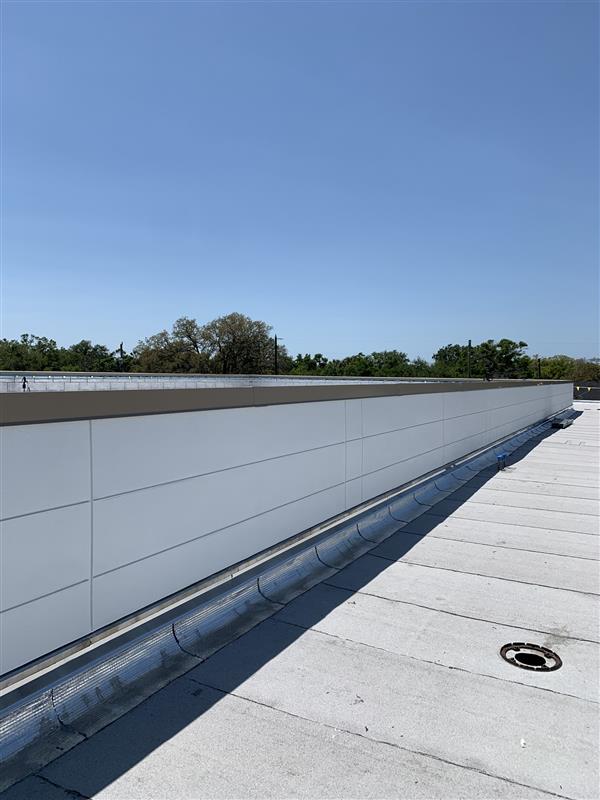

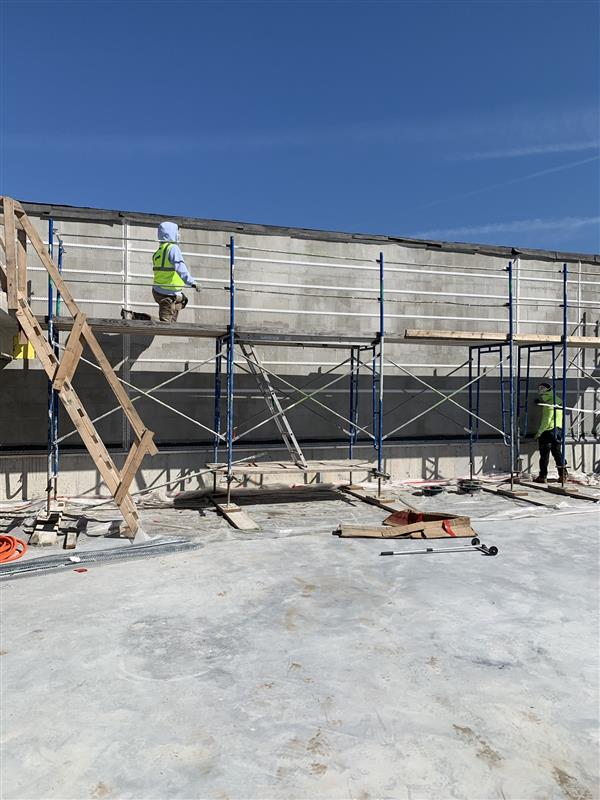

- Installing flashing around steel plates for guard rails at the high roof

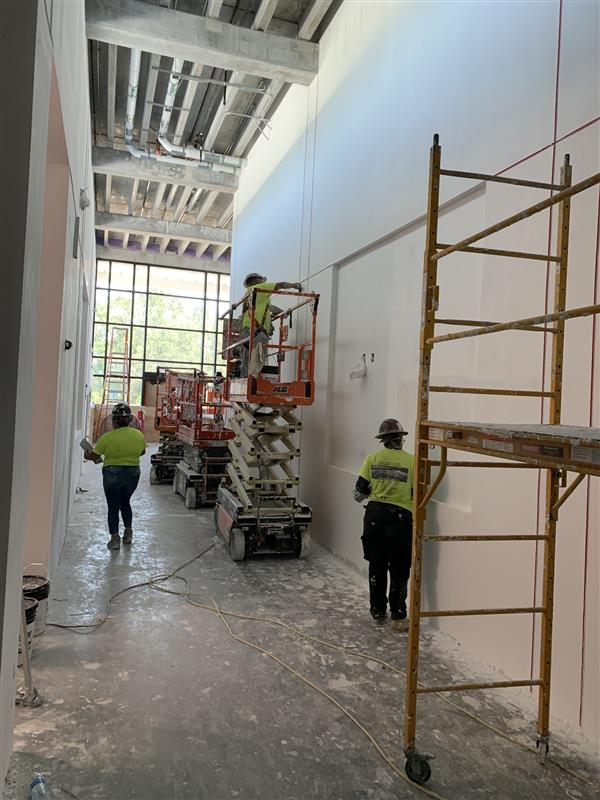

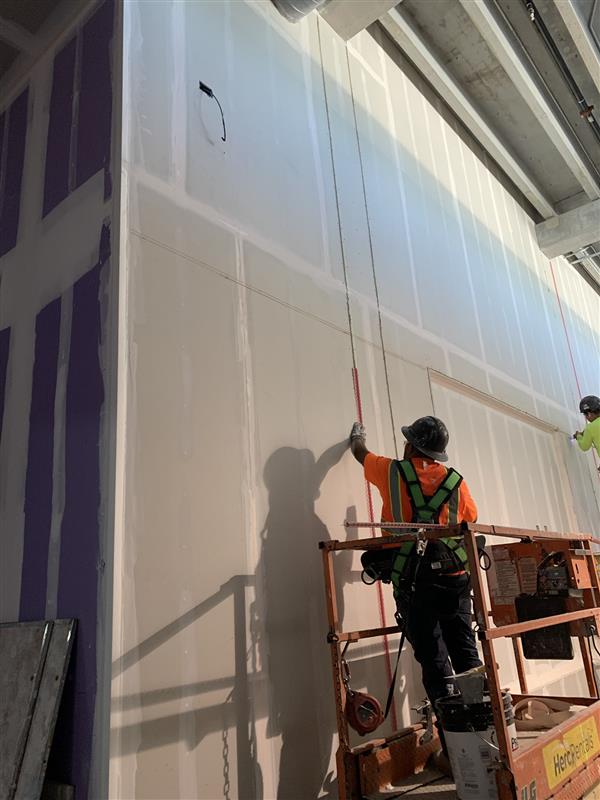

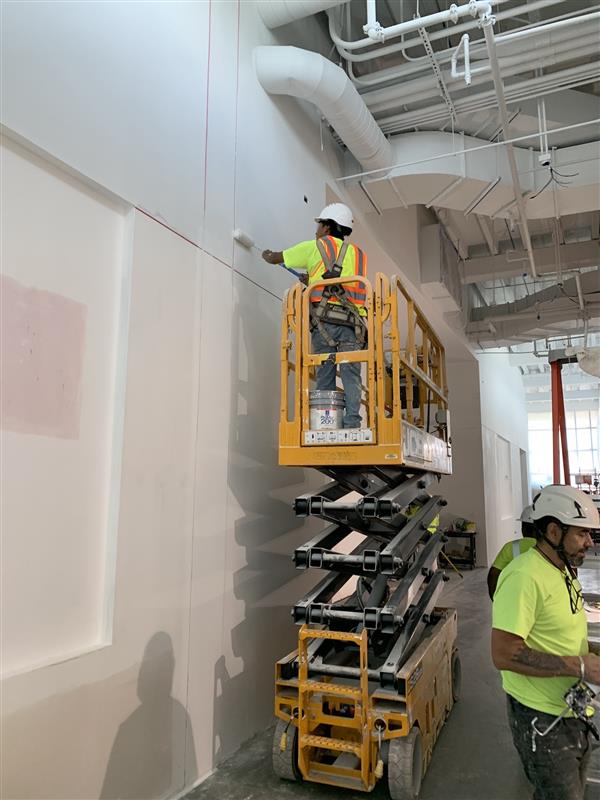

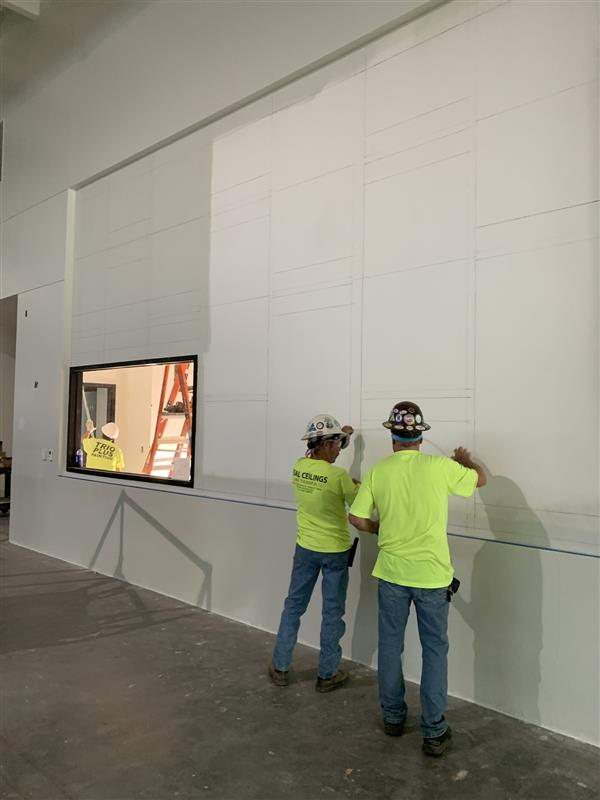

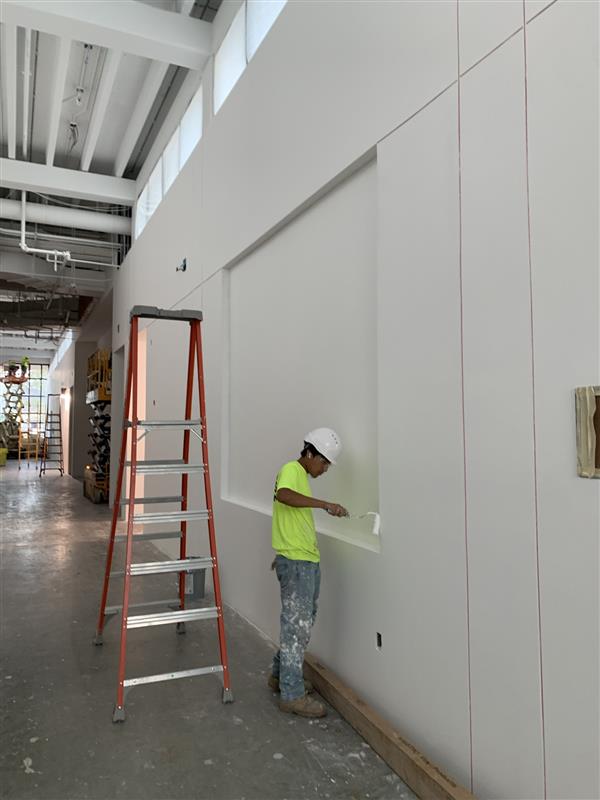

- Continuing interior painting
